Disclosure: NOXI publishes this guide and is one of the tools it mentions; the method works in any presentation software.
Quick answer: A project kickoff presentation gets the people who will fund, approve and do the work to agree on eight things: the goal, the scope (in and out), the success measures, roles and decision rights, the timeline and milestones, risks and assumptions, ways of working, and the first two weeks. A workable deck is ten slides for a 60-minute meeting, and each slide should end in an agreement or in an open question with an owner and a date. A client kickoff adds the contract scope, approvers on both sides and the change-request route.
Most kickoff decks fail quietly. The slides are accurate and people nod, then three weeks later the team learns that the sales director assumed quoting was in scope, that two managers each believed they approved the field definitions, and that nobody owned the data clean-up. The meeting informed people; it did not make them agree.
This guide treats the kickoff as a set of agreements and builds the deck backwards from them: a ten-slide template, a 60-minute run-of-show, a RACI and decision-rights template, a checklist, and a worked example of a fictional CRM migration for a 40-person sales team, with every number calculated so you can check it.
In short
- PurposeTurn the approved charter into agreements with the people doing the work.
- DeckTen slides in meeting order; each title states the agreement, not the topic.
- Meeting60 minutes with a pre-read; about 28 of them go to scope, decision rights and risks.
- Decision rightsOne accountable person per decision, written limits and a named escalation route.
- Client kickoffStarts from the statement of work and names approvers on both sides.
- AfterwardsSummary, decision log and first-two-weeks plan sent within 24 hours.
What a project kickoff presentation is for
A project kickoff presentation is the deck used in the first meeting of an approved project to turn its goals and plan into shared working agreements. It is not the charter, which authorizes the project, and it is not the plan, which schedules the work.
PMI's Lexicon of Project Management Terms (version 5.0, January 2026) describes a kickoff meeting in similar terms: the team and key stakeholders gather at the start of a project to set expectations formally, reach a common understanding and begin work. Because the lexicon's charter is the document that formally authorizes the project, the charter comes first and the kickoff second.
| Document | Its job | When |
|---|---|---|
| Charter | Authorizes the project, its budget and the project manager's authority; approved by the sponsor | Before the kickoff |
| Statement of work | Describes what a supplier will deliver under a contract; agreed by client and supplier | Before a client kickoff |
| Kickoff deck | Turns those decisions into agreements on scope, measures, roles, dates and ways of working | Week 1 |
| Status report | Compares progress with the baseline the kickoff set | Every one to four weeks |
Some teams use a lighter, living document instead of a formal charter, such as Atlassian's project poster. Either works, as long as someone with authority has agreed to the project before the kickoff. Afterwards, the kickoff's agreements become the baseline for every status report.
When to hold it, and who to invite
Hold the kickoff after the project is approved and the core team is named, and before work starts: in practice, in the first week. If the budget or the sponsor is still undecided, you are running a planning workshop, and the deck should say so. Invite the sponsor, the project manager, the core team and the stakeholders whose input or approval the project needs. Atlassian's Project Kickoff play names these roles, adds a facilitator who keeps the meeting moving, and is sized for 3 to 14 people over 90 minutes. Above about 14, discussion turns into a broadcast, so hold the working kickoff with the core group and brief the wider audience separately with the same deck.
The 10-slide project kickoff template
A kickoff deck needs ten main slides, in the order the meeting will discuss them, from the purpose of the hour to the first two weeks of work. Each slide exists to produce one agreement, and its title should state that agreement in a full sentence.
The last column is the test: if you cannot say what the room must agree on a slide, the slide is a briefing, and it belongs in the pre-read or the appendix.
| # | Slide | What goes on it | Agreement it must produce |
|---|---|---|---|
| 1 | Purpose and today's outcomes | The project in one sentence, the sponsor's reason, the agreements this meeting must reach | Why the project exists and what the hour is for |
| 2 | Why now | The problem, the baseline numbers, the cost of waiting | Everyone describes the problem the same way |
| 3 | Goal and success measures | The outcome goal; three or four measures with baseline, target, date and owner | What "done" and "worked" mean |
| 4 | Scope: in, out, later | Three columns and the change-request route | The line around the work, and how it moves |
| 5 | Roles and decision rights | RACI for the five to eight key decisions; decision limits and escalation | Who does, decides, is asked and is told |
| 6 | Timeline and milestones | Five to eight dated, verifiable milestones; dependencies; fixed dates marked | The dates the project will be held to |
| 7 | Risks, assumptions, constraints | Top five risks with owners and responses; assumptions to verify; constraints | What could stop the project, and who watches it |
| 8 | Ways of working | Meeting rhythm, channels, decision log, status reporting, response times | How the team works and records decisions |
| 9 | What we need from you | Time, access, data and approvals by group, in hours and weeks | Each group's commitment, in hours |
| 10 | First two weeks and decisions | Dated tasks with owners for ten working days; decisions read back; open questions | Work starts tomorrow, with names on it |
The appendix holds the full RACI, the risk register, the detailed plan and, for a client project, the contract scope.
Write the titles as agreements: "Scope" is a label; "Accounts, deals and two years of activity move; quoting and marketing do not" is a statement the room can accept or challenge. Read only the ten titles in order: if they tell the story of the project, the deck is ready. Our guide to consulting-style action titles covers the technique.
How many slides does a kickoff presentation need?
Count by the agreements the meeting must reach, not by the material you have. Ten slides fit a 60-minute kickoff at about six minutes each, which leaves room for discussion; our slides-per-minute table covers pacing. Adjust by project type:
| Project type | Slides | Meeting | What changes |
|---|---|---|---|
| Small internal | 5 | 30 minutes | Purpose and goal, scope, roles, timeline and risks, first steps |
| Standard | 10 | 60 minutes | The template above, with a pre-read |
| Client engagement | 10–12 plus appendix | 60–90 minutes | Contract scope, approvers on both sides, sign-off and change route; internal kickoff first |
| Agile team | 6–8 | 60–90 minutes | Product goal, working agreement, definition of done and the first sprint replace a detailed plan |
| Multi-team | 12–15 | Half day, in blocks | A shared opening, then sessions on interfaces, dependencies and joint decisions |
Run the 60-minute kickoff meeting
A 60-minute kickoff works when a pre-read goes out two working days before and the hour goes to the parts people will disagree about: about 28 minutes on goal and scope, decision rights and risks. The deck follows the agenda slide for slide.

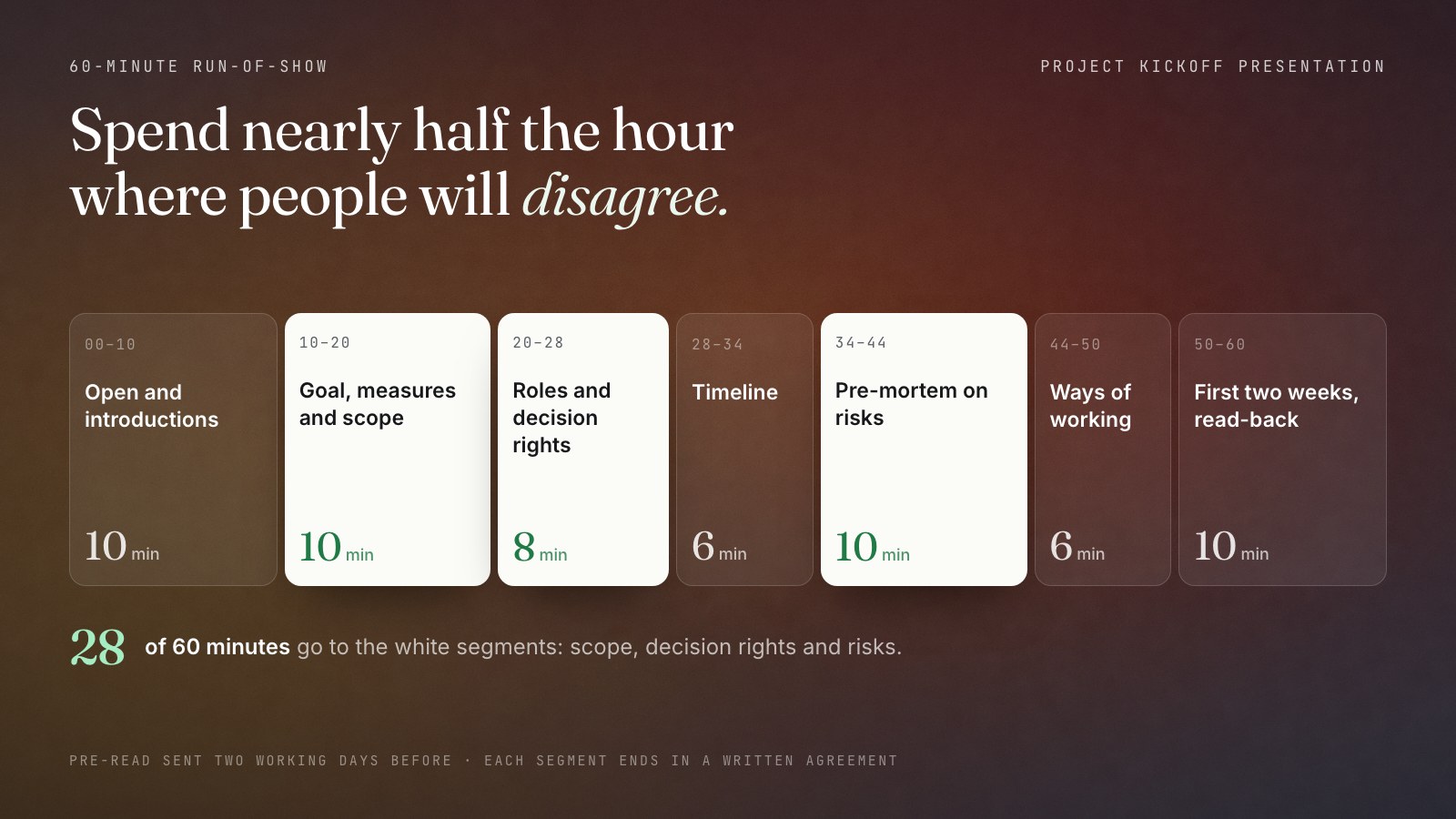

| Minutes | Segment | Slides | Led by | Output |
|---|---|---|---|---|
| 00–10 | Open and introductions | 1–2 | Sponsor, then facilitator | The reason for the project, from the sponsor; everyone knows who is who |
| 10–20 | Goal, measures and scope | 3–4 | Project manager | Measures accepted or flagged; out-of-scope list confirmed aloud |
| 20–28 | Roles and decision rights | 5 | Project manager | Each key decision has one accountable person and a written limit |
| 28–34 | Timeline and milestones | 6 | Project or delivery lead | Fixed dates and dependencies acknowledged |
| 34–44 | Pre-mortem on risks | 7 | Facilitator | Top risks named, each with an owner |
| 44–50 | Ways of working and commitments | 8–9 | Project manager | Rhythm, channels and time commitments agreed |
| 50–60 | First two weeks and read-back | 10 | Facilitator; sponsor closes | Decisions read aloud; actions with owners and dates |

Introductions take about 30 seconds each: name, role and the one thing the person owns or decides on this project. The sponsor's opening should be short and specific: why this project, why now, and what the sponsor will personally decide. Mark on every slide what is fixed and what is proposed, and ask for objections to the proposed parts in the room; a plan presented as final gets polite nods and is reopened in week three.
Pre-read, facilitation and remote rooms
Send the deck and the charter or statement of work two working days ahead, and ask each attendee to bring one question or objection. Name a facilitator who keeps time and calls for objections, and a recorder who writes each agreement down as it is made; presenting a plan and refereeing objections to it is hard to do at once. In a remote or hybrid kickoff, share the decision log on screen, collect objections round-robin, give remote participants the first turn, and run the pre-mortem's silent writing in a shared document. For a 30-minute version, use the five-slide deck and replace the pre-mortem with a two-minute "what worries you most?" round.
Goal and success measures: agree what "done" and "worked" mean
State the goal as an outcome, not a deliverable, and give it three or four success measures, each with a baseline, a target, a date and an owner. "Implement the new CRM" is finished the day it is installed; "36 of 40 sales staff work in the CRM every week by week 14" is finished when the project has worked.
PMI's lexicon describes project success as the shared view of beneficiaries, stakeholders and participants that a project delivered value worth its cost. That shared view cannot be discovered at the end; it has to be agreed at the start.
| Weak goal | Why it fails | Stronger version |
|---|---|---|
| "Implement the new CRM" | A deliverable; done on installation, whether anyone uses it or not | "36 of 40 sales staff log their activity in the CRM each week, measured in week 14" |
| "Improve forecasting" | No baseline, target or date | "The month-end forecast takes 4 hours of sales-operations time, down from 16, by the second month-end after go-live" |
| "Better data quality" | Nobody can say when it has been achieved | "Duplicate accounts at 2% or less in a 500-record sample after migration, down from 9%" |
A complete measure has six parts: metric, baseline, target, date, data source and owner. If a baseline is unknown, say so on the slide and make measuring it a first-two-weeks task. Keep deliverables separate: each gets acceptance criteria, the conditions it must meet before it is accepted, in the plan or the appendix. And add at least one measure dated after go-live or handover, or the project can be declared a success while the problem continues.
Scope: in, out and later
A scope slide needs three columns, in scope, out of scope and later, plus one line on how the boundary can change. The out-of-scope column prevents more arguments than the in-scope column, so read it aloud and ask for objections.
PMI's lexicon defines scope creep as scope expanding without matching adjustments to time, cost and resources. It rarely starts with a formal request; it starts with an assumption that something was obviously included. List the items people are most likely to assume, and place each in "out" or "later". "Later" tells a stakeholder the request has been heard and has a route, which makes "not now" easier to accept. Then put the change route on the same slide:
| Step | What happens | Time limit |
|---|---|---|
| 1. Request | Anyone records the change in the decision log: what, why and who asked | Any time |
| 2. Assess | The project manager estimates the effect on dates, cost, risk and success measures | Three working days |
| 3. Decide | Within the project manager's limits, the project manager; beyond them, the sponsor | Next weekly check-in |
| 4. Record | The decision, the reason and any new baseline are written down and shared | Within 24 hours |
Roles, RACI and decision rights
The roles slide should answer one question for every important decision: who decides? Use a RACI for the five to eight decisions and deliverables that matter most, with exactly one accountable person per row, and add a short table of decision limits that says what the project manager may decide alone and when a decision goes to the sponsor.
PMI's lexicon treats RACI as one type of responsibility assignment matrix. The single-accountable rule is a convention rather than a standard, but it is widely stated: IT@Cornell's RACI guidance, for example, allows one A per item, notes that the responsible person can also be the accountable one, and suggests naming one R and marking other helpers as support. A grid with roles across the top works in a spreadsheet; on a slide, the letters as columns and role names in the cells read more easily:
| Decision or deliverable | Accountable (one) | Responsible | Consulted | Informed |
|---|---|---|---|---|
| Go/no-go for launch | Sponsor | Project manager | Delivery lead, operations owner | All users |
| Scope changes beyond limits | Sponsor | Project manager | Product owner, finance | Core team |
| Requirements and definitions | Product owner | Business analyst | Users' managers | Sponsor |
| Milestone dates within limits | Project manager | Delivery leads | Core team | Sponsor |
| Security and access | Security lead | System administrator | Project manager | Sponsor |
| Acceptance of deliverables | Product owner | Delivery lead | Pilot users | Sponsor |
Check the finished RACI: every row has one A and at least one R, nobody is consulted so often that decisions wait for them, and everyone invited appears in some row. For contested decisions, Atlassian's DACI framework is a useful variant: a driver runs the decision, a single approver makes it, contributors advise and others are informed.
Decision rights and tolerances
A RACI says who decides; decision limits say how far that person can go. UK government guidance on the role of the senior responsible owner expects the appointment of a project's accountable leader to record their decision powers and any limits of authority or tolerances, and defines tolerance as the permitted deviation above and below a plan's target for time and cost. The same discipline works at any size: write the limits on the slide.
| Decision | Who decides | Limit | Beyond the limit |
|---|---|---|---|
| Internal milestone dates | Project manager | [5] working days, if the end date holds | Sponsor |
| Contingency spend | Project manager | Up to [amount] per item and [amount] in total | Sponsor |
| Design within scope | Product owner | Within the acceptance criteria | Project manager |
| Scope, end date, measures | Sponsor | Within the approved budget | Budget holder or steering group |

If reviewers disagree about the deck itself before the meeting, settle who decides first and the wording second; our guide to resolving conflicting presentation feedback sets out that workflow.
Timeline, milestones and the first two weeks
Show five to eight milestones as dated, verifiable events, mark which dates are fixed and which are estimates, and plan the first two weeks in detail with named owners. The milestone slide sets the dates the project will be held to; the first-two-weeks slide makes sure work starts the next morning.
A milestone is an event someone can check, not a bar on a chart: "dry-run migration reconciled" rather than "migration phase". Give each one a date, an owner and the evidence that it happened, and mark dependencies outside the team, such as a security review, because those are the dates the team cannot control. PMI's lexicon describes rolling wave planning as planning near-term work in detail and later work at a higher level; a kickoff deck applies it literally, with the first ten working days as dated tasks and everything after as milestones.

The first-two-weeks slide is a table of day, task, owner and output. It ends the meeting on action rather than on "Questions?", and it gives the first check-in something concrete to review. Our guide to status reports and RAG rules shows how the same milestones carry into status slides.
Risks, assumptions and a 10-minute pre-mortem
A kickoff risk slide shows the top five risks, each with an owner, a response and a trigger, plus the assumptions the plan depends on and the constraints it cannot change. A 10-minute pre-mortem in the meeting is the fastest way to surface risks people know about but would not otherwise raise.
Keep four terms apart, because each needs a different response. The meanings follow PMI's lexicon:
| Term | Meaning | On the kickoff slide |
|---|---|---|
| Risk | An uncertain event or condition that would affect an objective if it occurred | Owner, response and the trigger that shows it is happening |
| Issue | A current condition that may affect objectives | Owner and a decision date; it is already true |
| Assumption | Something the plan treats as true without proof | Who will verify it, and by when |
| Constraint | A limiting factor the project must work within | Stated once, so nobody plans around it by accident |
Gary Klein described the method in Harvard Business Review in 2007: team members assume the project they are planning has just failed and generate plausible reasons. A 10-minute kickoff version:
- Minute 0–1: frame it."It is [end date]. The project has failed. Why?"
- Minutes 1–4: write silently.Each person writes alone, so the first speaker does not set the agenda.
- Minutes 4–8: read round-robin.One reason per person per round; the recorder groups duplicates.
- Minutes 8–10: pick and assign.The three reasons that would hurt most each get an owner before the meeting moves on.
New items go into the register with an owner, but keep the slide to five risks: twenty risks with no owners tell the room that risk management is someone else's paperwork.
Ways of working and what you need from people
The ways-of-working slide records how the team will meet, communicate, report and record decisions; the commitments slide states what each group must give the project in hours and weeks. Both turn good intentions into something that can be checked in week three.
PMI's lexicon calls the behavioral part "ground rules": expectations about acceptable behavior by team members. Atlassian's kickoff play has the group agree a few norms at the start. Keep the slide practical:
| Topic | Agree in the kickoff | Example wording |
|---|---|---|
| Rhythm | Which meetings, how long, who attends | "Weekly 30-minute check-in, Tuesday 09:00; steering every four weeks" |
| Channels | Where questions, files and urgent issues go | "Questions in the project channel; blockers by phone to the project manager" |
| Decisions | Where decisions are written, and how fast | "Decision log updated within 24 hours of any decision" |
| Status | Format and frequency for the sponsor | "One-page status every two weeks, with agreed RAG thresholds" |
| Done | What "done" means for a deliverable | "Acceptance criteria met and signed off by the product owner" |
The commitments slide is the one most kickoffs leave out, and the one line managers need most. "We need your support" cannot be planned; "two 90-minute training sessions and 30 minutes checking your own accounts in week 3" can. State each group's time in hours and weeks, plus any access or data the project needs from them, so managers can protect the time before calendars fill.
Internal kickoff vs client kickoff
An internal kickoff commits your own team and business owners to a plan the organization has approved; a client kickoff confirms a shared reading of a signed contract and starts a working relationship. The client version names approvers on both sides, explains sign-off and change requests, and leaves internal concerns out.
| Aspect | Internal kickoff | Client kickoff |
|---|---|---|
| Starting point | Approved charter or business case | Signed contract and statement of work |
| Scope | The agreed in, out and later lists | The contract scope read back in plain words; anything ambiguous logged as a question |
| Success | Business outcomes the sponsor owns | The client's outcomes, plus acceptance criteria for each deliverable |
| Decision rights | Internal sponsor and limits | Approvers on both sides, who signs off each deliverable, the change-order route |
| Risks | The full internal risk list | Shared risks and client dependencies: access, data, people's time, approvals |
| Keep off the slides | Personal performance issues | Margins, internal staffing concerns, risks about the client's own people |
PMI's lexicon describes a statement of work as a narrative description of what the project will deliver. Clients rarely read it the way the supplier's team does, so the most useful slide in a client kickoff is often the plainest: "Here is what we understand we are delivering, and what is not included." Every difference found there is cheaper to settle in week one than at the first invoice. Run a short internal kickoff a few days earlier, so your team agrees which risks to raise, who answers which questions and what it will not commit to in the room.
Worked example: CRM migration kickoff for a 40-person sales team
This fictional example applies the template to an internal project: moving a 40-person sales team from a partly used legacy CRM, regional spreadsheets and email onto one new CRM in 12 weeks. Every figure is invented for teaching and calculated so you can check it.
Success measures (slide 3)

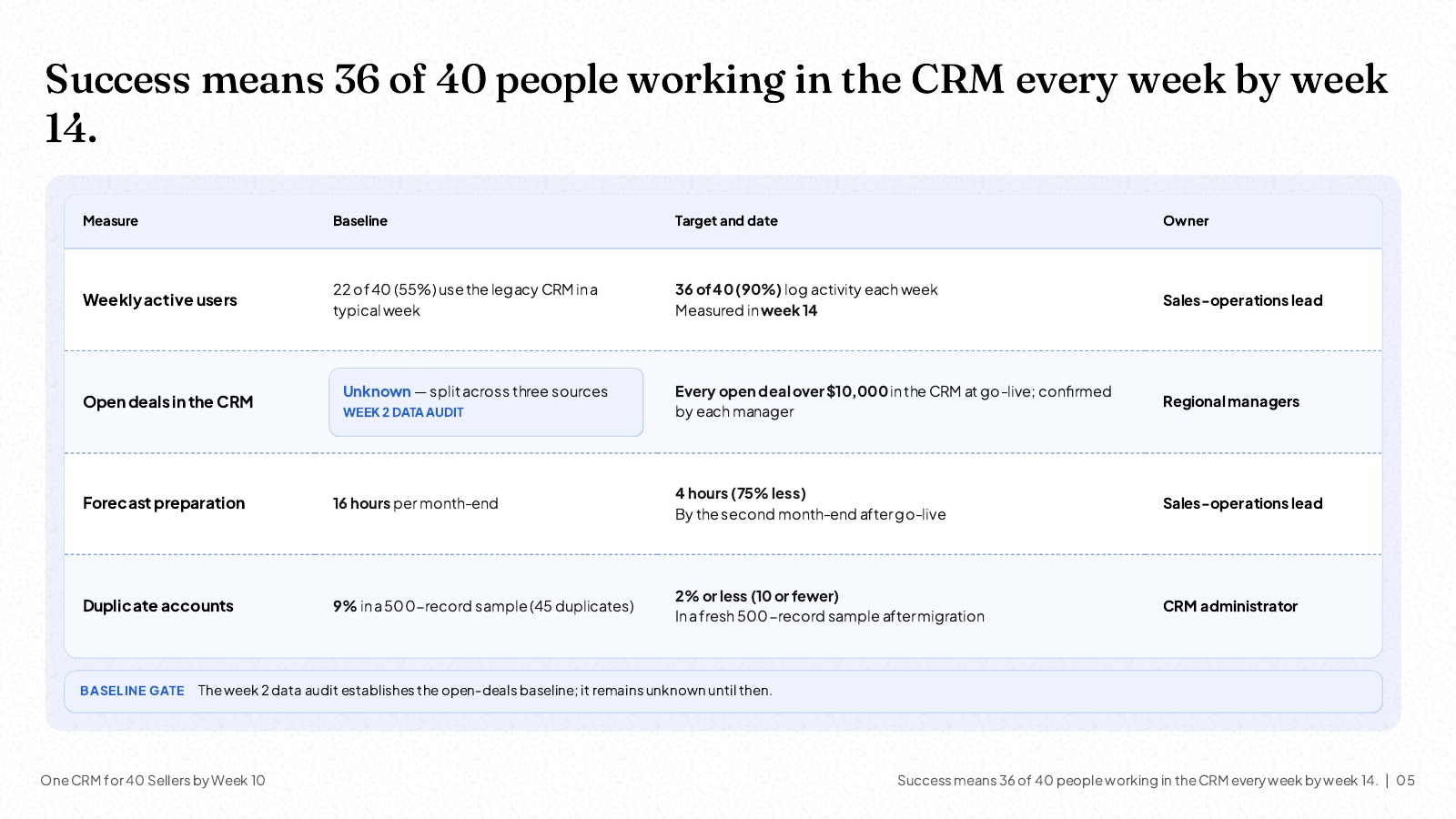

| Measure | Baseline | Target and date | Owner |
|---|---|---|---|
| Weekly active users | 22 of 40 (55%) in the legacy CRM | 36 of 40 (90%) log activity each week, measured in week 14 | Sales-operations lead |
| Open deals in the CRM | Unknown; split across three sources | Every open deal over $10,000 in the CRM at go-live, confirmed by each manager | Regional managers |
| Forecast preparation | 16 hours per month-end | 4 hours (75% less) by the second month-end after go-live | Sales-operations lead |
| Duplicate accounts | 9% in a 500-record sample | 2% or less (10 or fewer) in a fresh 500-record sample after migration | CRM administrator |
The second measure has no baseline, and the slide says so rather than inventing one; counting open deals over $10,000 in each source becomes part of the data audit.
Scope and roles (slides 4 and 5)

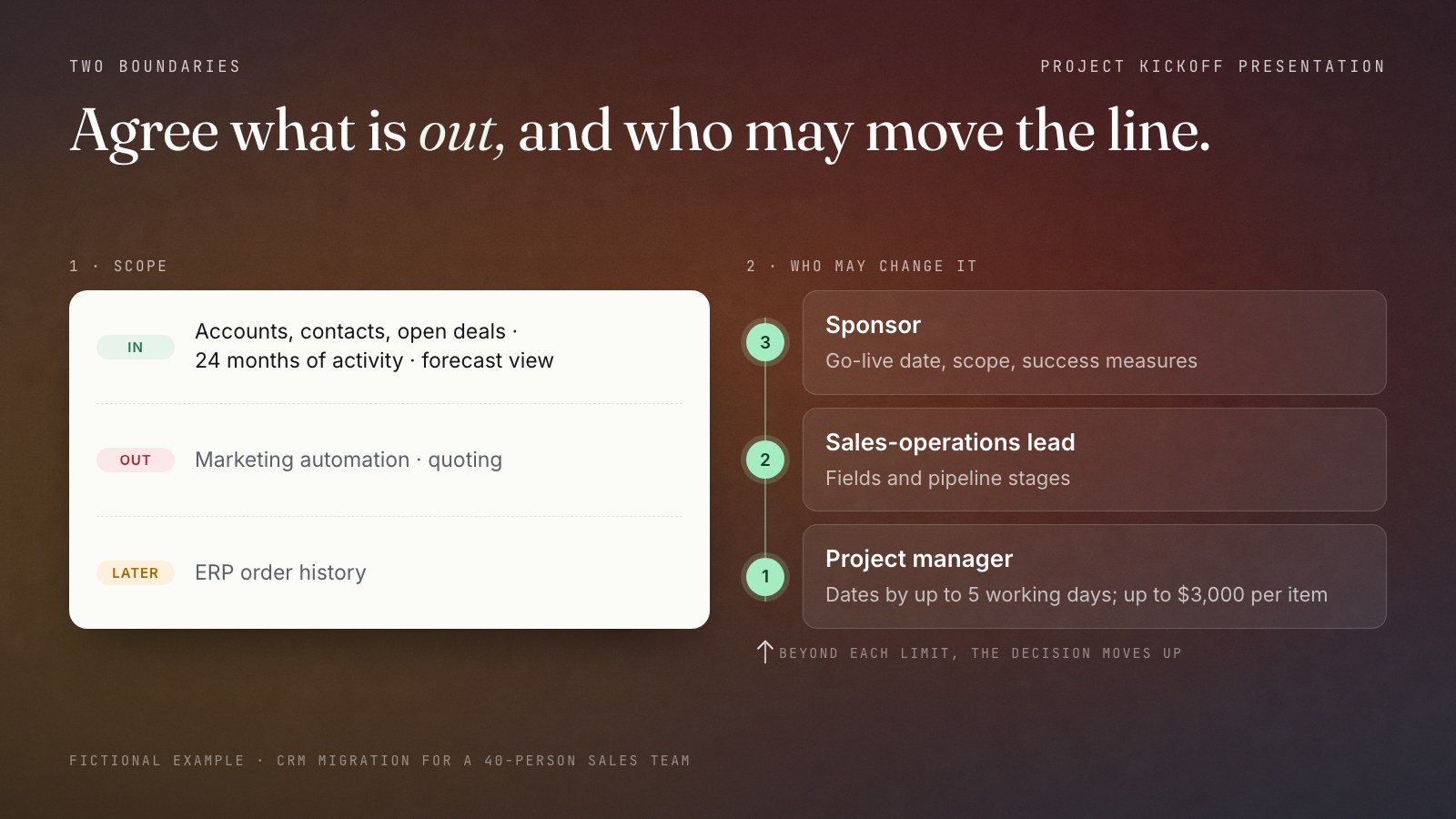

In: accounts, contacts and open opportunities; 24 months of activity history; six redefined pipeline stages; the managers' forecast view; email and calendar sync; mobile access; training for all 40 people. Out: marketing automation, quoting and customer-service cases. Later (phase 2 candidate, separate approval): order history from the ERP system.
| Decision or deliverable | Accountable (one) | Responsible | Consulted | Informed |
|---|---|---|---|---|
| Pipeline stage definitions | Sales-operations lead | CRM administrator | 5 regional managers | Account executives |
| Data migration | Project manager | CRM administrator, data specialist | Sales-operations lead | Sponsor |
| Go/no-go in week 9 | Sponsor | Project manager | Sales-operations lead, IT security, managers | All 40 users, finance |
| Training | Sales-operations lead | Sales-operations analysts | Regional managers | Sponsor |
| Email sync and access | IT security lead | CRM administrator | Project manager | Sponsor |

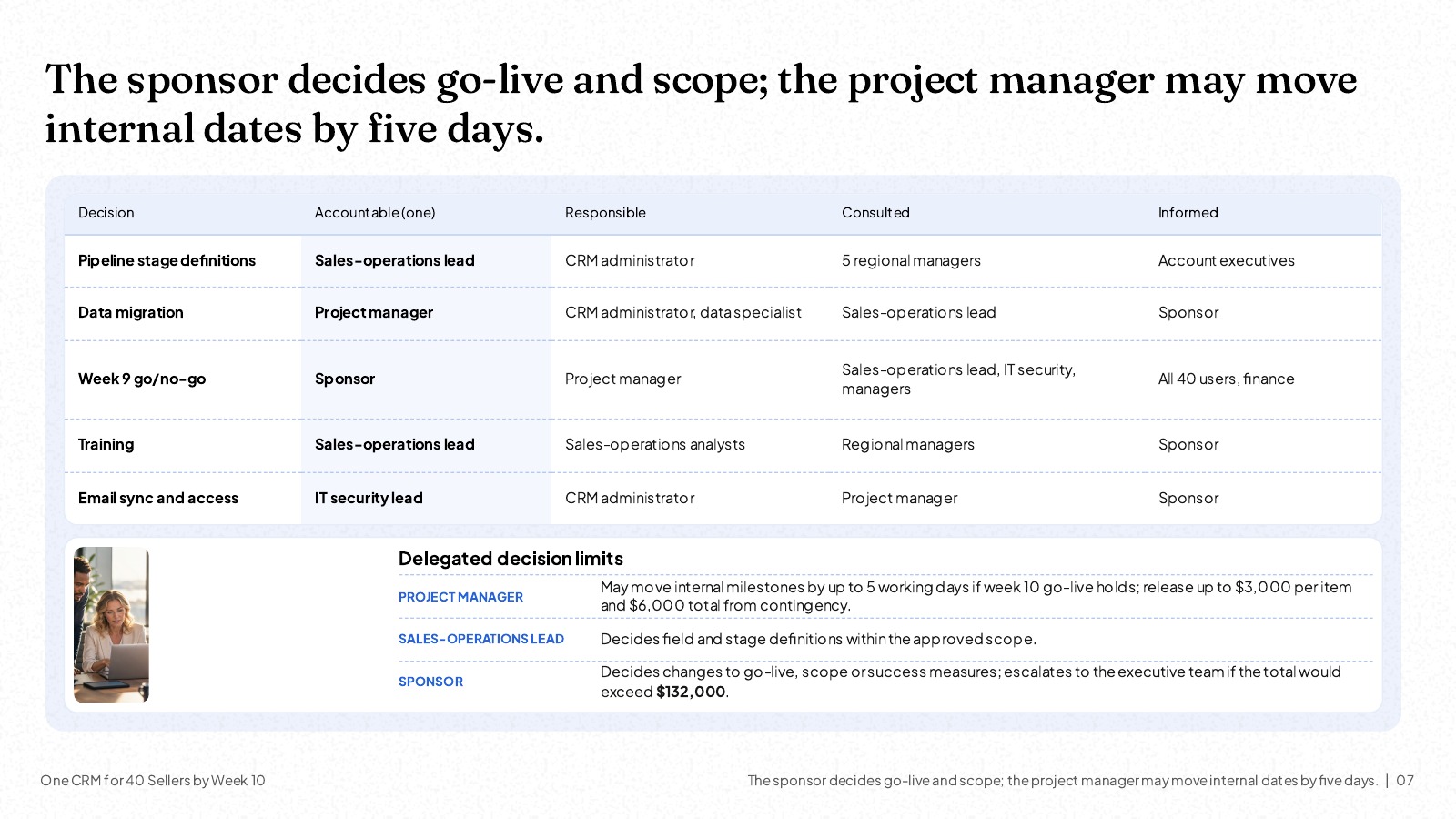

Decision limits: the project manager may move internal milestones by up to 5 working days if go-live stays in week 10, and release up to $3,000 per item and $6,000 in total from contingency. The sales-operations lead decides field and stage definitions within scope. The sponsor decides any change to go-live, scope or success measures, and goes to the executive team if the $132,000 total would be exceeded.
Timeline and risks (slides 6 and 7)
| Week | Milestone | Evidence it happened |
|---|---|---|

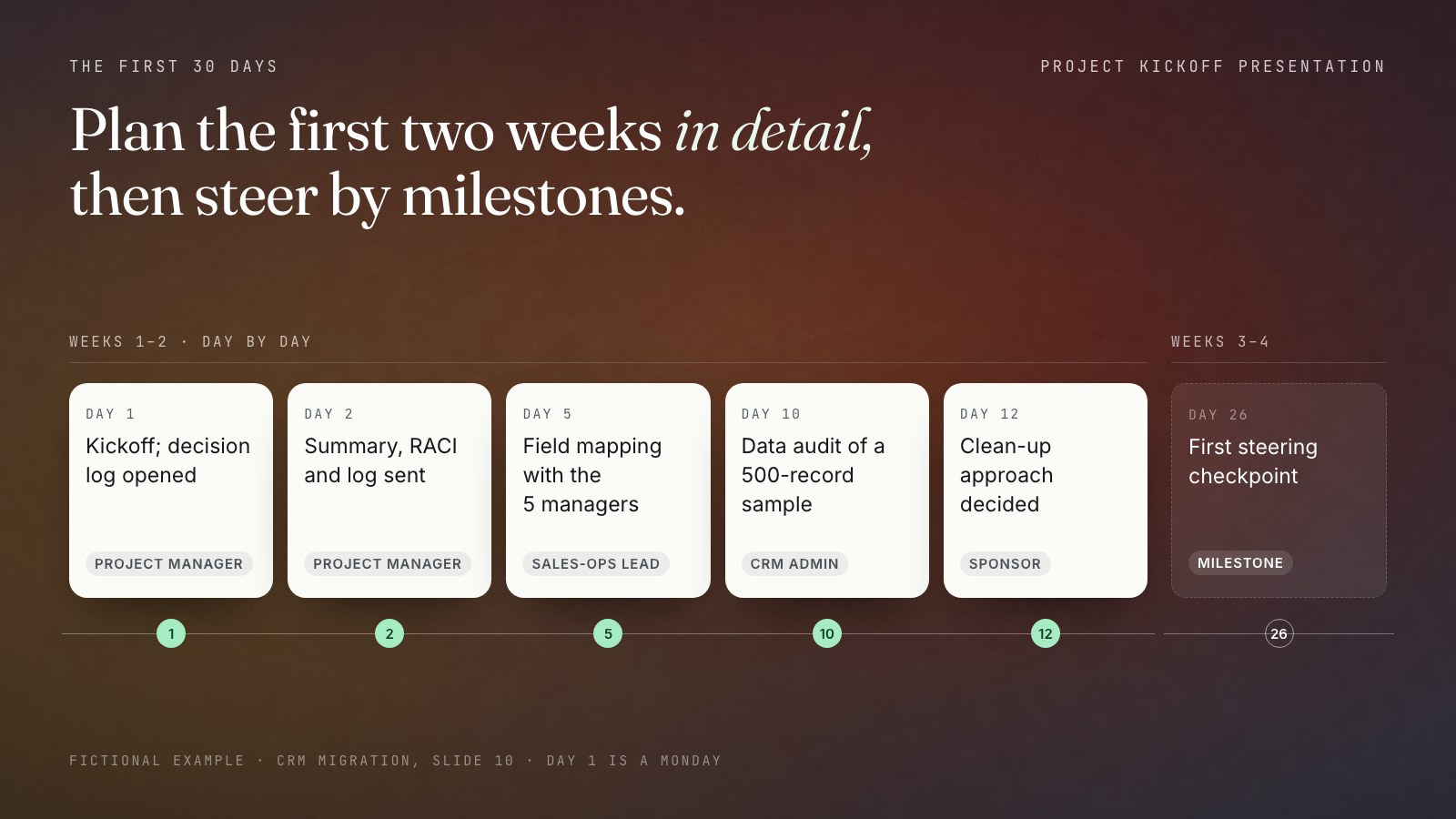

| 1 | Kickoff; decision log opened | Written summary confirmed by attendees |
| 2 | Field map and data audit complete; clean-up approach decided | Signed field map; measured duplicate rate; sponsor decision logged |
| 5 | Configuration complete in the test environment | Sales-operations lead accepts the demonstration |
| 7 | Dry-run migration | Record counts reconcile; duplicates at 2% or less |
| 8 | Acceptance testing by 6 pilot users | Test scripts passed; open defects triaged |
| 9 | Go/no-go; training starts | Sponsor decision recorded; 4 cohorts of 10 trained across weeks 9–10 |
| 10 | Go-live | All 40 users can log in; open deals over $10,000 confirmed |
| 11–12 | Hypercare | Daily support; issue log closed or handed over |
| 14 | Success-measure check | Weekly users, forecast hours, fresh duplicate sample |
Steering checkpoints fall in weeks 4, 8 and 12. Because the plan starts with the quarter, go-live in week 10 leaves one clear week before the blocked weeks 12 and 13, so a failed dry run must move go-live by a decision at the week-9 go/no-go, not by drift.
| Risk | Owner | Response | Trigger |
|---|---|---|---|
| Duplicate and stale accounts | CRM administrator | Merge rules before migration; account executives check their own accounts in week 3 | Dry-run duplicate rate above 2% |
| Low adoption among the 18 non-users | Regional managers | Weekly pipeline reviews run only from the CRM from week 11 | Fewer than 36 weekly users in week 12 |
| Go-live slips toward quarter-end | Sponsor | Week-9 go/no-go with a fallback date agreed at the kickoff | Dry run in week 7 fails reconciliation |
| One CRM administrator | Project manager | Contracted backup for weeks 6–12, paid from contingency | Administrator unavailable for more than 2 days |
| Email sync held in security review | IT security lead | Request submitted on day 3; manual activity logging as a fallback | No security decision by day 15 |
Assumptions to verify: licenses are available by the end of week 1; the legacy CRM exports to CSV with record IDs intact; managers can give one hour a week.
What we need from you (slide 9)
| Group | What the project needs | Hours |
|---|---|---|
| 32 account executives | Two 90-minute training sessions; 30 minutes checking their own accounts in week 3 | 3.5 each; 112 in total |
| 5 regional managers | Training (3 hours); one hour a week for field mapping and testing in weeks 1–8 | 11 each; 55 in total |
| 6 pilot users | Acceptance testing in week 8 (5 account executives and 1 manager, on top of the rows above) | 4 each; 24 in total |
| 3 sales-operations analysts | Training (3 hours), besides their project roles | 3 each; 9 in total |
Training alone is 40 people × 2 sessions × 1.5 hours = 120 person-hours, which the rows reconcile: 32 × 3 + 5 × 3 + 3 × 3 = 96 + 15 + 9 = 120.
The ten titles, read as a story
| # | Action title |
|---|---|
| 1 | We will move all 40 sellers onto one CRM by week 10, and today we agree how |
| 2 | Our pipeline lives in three places, so the month-end forecast takes 16 hours |
| 3 | Success means 36 of 40 people working in the CRM every week by week 14 |
| 4 | Accounts, deals and two years of activity move; quoting and marketing do not |
| 5 | The sponsor decides go-live and scope; the project manager may move internal dates by five days |
| 6 | Go-live in week 10 follows a dry run in week 7 and pilot testing in week 8 |
| 7 | Duplicate accounts are the biggest risk: about 1,650 of 18,400 records |
| 8 | One weekly 30-minute check-in, one channel and one decision log |
| 9 | We need 112 hours from account executives, 55 from managers and 24 from pilot users |
| 10 | In the first two weeks we map the fields and audit the data, with named owners |
Slide 10 carries the days shown in the 30-day figure above, plus day 3: test-environment access (CRM administrator) and the email-sync security request (IT security lead).
To see the template as finished slides, we generated this worked example as a deck in NOXI from the ten slide titles and contents above and exported it to PDF without edits. Two of its twelve slides (the deck adds a cover and an agenda):


Project kickoff checklist: before, during and after
Most of a kickoff's value comes from the work before and after the hour: the meeting should start from agreed facts and end in a written record. Use this checklist to make sure both happen.
Before
- The charter or statement of work is approved.Otherwise call it a planning workshop.
- The sponsor has seen the deck and will open the meeting.Agree the three to five outcomes the hour must reach.
- Every measure has a baseline, target, date and owner.Unknown baselines are labelled and assigned.
- The RACI has one A per row and covers everyone invited.Decision limits are written as numbers.
- The pre-read went out two working days ahead.For a client kickoff, the internal kickoff has happened.
During
- The out-of-scope list is read aloud.Objections go into the log with an owner.
- Each key decision is confirmed by its accountable person.Ask that person to say yes aloud.
- The pre-mortem names the top three risks and owners.Silent writing first.
- Decisions are read back before people leave.The recorder reads; the room corrects.
After
- Summary sent within 24 hours.Decisions, open questions with owners and dates, first-two-weeks plan.
- Attendees confirm or correct it in writing.Treat silence as agreement only if you said so.
- Absent stakeholders are briefed with the same deck.Their objections go through the change route.
- The first status report uses the kickoff baseline.Same measures, milestones and RAG thresholds.
If the project later needs a board or executive decision, the kickoff's measures and decision limits are its starting point; our board presentation guide covers that format, and the product roadmap guide covers projects that sit inside a larger product plan.
3 AI prompts for the kickoff deck
Use them in NOXI after attaching your charter and plan, or in any AI tool that has them. Replace the brackets.
Create a [10]-slide project kickoff presentation for [project name] from the attached [charter or statement of work] and [project plan], for a [60]-minute meeting with [sponsor, core team, key stakeholders]. Slides in this order: purpose and today's outcomes; why now, with the baseline; goal and success measures; scope in, out and later; roles and decision rights; timeline and milestones; risks, assumptions and constraints; ways of working; what we need from each group, in hours; first two weeks and decisions. Write every title as a full-sentence statement. Give each success measure a baseline, target, date and owner. Use only names, numbers and dates from the attached files and mark anything missing as [to confirm].
Rebuild slide [5] as a roles and decision-rights slide using these roles: [role: name]. Show one row per key decision or deliverable: [list five to eight], with the columns Accountable (exactly one role), Responsible, Consulted and Informed. Below it, add a decision-limits table (decision, who decides, limit, beyond the limit) using [up to 5 working days; up to $3,000 per item]. Flag any row with more than one accountable role or no responsible role, and anyone invited who appears in no row.
Make a client kickoff version of this deck for [client name]. Keep every date, milestone and success measure unchanged. Replace the internal scope wording with the scope from the attached [statement of work] in plain language, and list each unclear item as an open question. Add the client's approvers, who signs off each deliverable and the change-request route. Remove margins, internal staffing notes and any risk that concerns the client's own people. Keep it to [12] slides.
How to build the kickoff deck in NOXI, in your template
NOXI drafts the deck from your charter and plan in the style of your own template. It is free, with no card and no watermark; uploading files needs a free account, and a full deck uses about 25 of the 1,000 monthly credits.
Step 1: Gather the charter and plan
Save the approved charter or statement of work as a Word document or PDF, and the plan, budget or roles list as an Excel or CSV file. NOXI accepts PDF, Word, PowerPoint, Excel, CSV, text and image files up to 200 MB each.
Step 2: Match your template
Choose Match reference and attach your company PowerPoint template, a previous kickoff deck as PPTX or PDF, or a screenshot of one slide. NOXI builds the new deck in that style: colors, typography, layouts and visual rhythm.
Step 3: Review the outline first
Attach the files with Prompt 1 and choose Plan mode to review the outline before generation. Check that the ten titles state agreements rather than topics and that every success measure has a baseline and a date, then generate and watch each slide being built.
Step 4: Refine slides with AI
Ask for changes to one slide or the whole deck in plain English or Arabic; Prompt 2 rebuilds the RACI and decision-rights slide. Click any element and tell the AI what to change; on desktop, sketch on the slide and the AI follows your drawing. Text, tables and chart numbers are editable on the slide.
Step 5: Review with the sponsor
Invite the sponsor and the core team leads by email as editors to correct the deck with you in real time, or share a view-only link as the pre-read. Version history restores an earlier version or makes a copy, which becomes the client version with Prompt 3.
Step 6: Export and present
Download an editable PowerPoint (.pptx) with real text boxes and embedded fonts, and a PDF for the pre-read, free and with no watermark. Present full-screen from NOXI in the kickoff. For a bilingual team, Translate a deck creates a separate Arabic or English version.
Frequently asked questions
- What should be included in a project kickoff presentation?
- Eight agreements: the goal, scope in and out, success measures, roles and decision rights, timeline and milestones, risks and assumptions, ways of working, and the first two weeks of work. A ten-slide deck adds an opening slide with the purpose, a why-now slide with the baseline, and a slide stating what each group must contribute in hours. The full RACI, risk register and detailed plan go in an appendix.
- How many slides should a project kickoff presentation have?
- Ten main slides suit a 60-minute kickoff with one sponsor and one core team, at about six minutes per slide. A small internal project can run five slides in 30 minutes. A client or multi-team kickoff may need ten to fifteen plus an appendix. Count by the agreements the meeting must reach, not by the material you have.
- How long should a project kickoff meeting be?
- Sixty minutes is enough for most projects when a pre-read goes out two working days before. Spend about 28 of the 60 minutes on goal and scope, decision rights and a short pre-mortem, because those are the parts people disagree about. Allow 30 minutes for a small internal project and up to 90 for a new team or several organizations; Atlassian's kickoff play, for example, runs 90 minutes for 3 to 14 people.
- Who should attend and who runs a project kickoff meeting?
- The sponsor, the project manager, the core team that will do the work, and the stakeholders whose input or approval the project needs. The sponsor opens with why the project matters, the project manager presents the plan, a facilitator keeps time and calls for objections, and a recorder writes each decision down. Brief a wider group separately with the same deck.
- What is the difference between a project charter and a kickoff presentation?
- The charter authorizes the project: the sponsor issues it, and it gives the project manager authority to use resources. The kickoff presentation comes after it and turns the charter's decisions into working agreements with the people doing the work: how success is measured, who decides what, what is out of scope, how the team works and what happens first. Without an approved charter, hold a planning workshop instead.
- How is a client kickoff different from an internal kickoff?
- A client kickoff starts from the signed contract and statement of work, names approvers on both sides, explains who signs off each deliverable and how change requests work, and lists the client's dependencies, such as access, data and approvals. It leaves out margins, internal staffing concerns and risks about the client's own people. Run a short internal kickoff first so your team presents one consistent plan.
- How do you make a RACI slide for a kickoff?
- List the five to eight decisions and deliverables that matter most, one per row, and give each exactly one accountable person, at least one responsible person, the people consulted before and the people informed after. On a slide, the letters as columns and role names in the cells read better than a full grid. Add the decision limits underneath.
- What should happen after the kickoff meeting?
- Within 24 hours, send a written summary with the decisions taken, open questions with owners and dates, the updated RACI and the first-two-weeks plan, and ask attendees to confirm or correct it. Open the decision log the same day, hold the first check-in in week one, and use the kickoff's measures and milestones as the baseline for every status report that follows.
Sources & methodology
How this guide was made: it applies published project-management definitions and kickoff practices to presentation work; the ten-slide template, 60-minute agenda, decision limits and checklists are editorial recommendations, not a standard. Kestrin Packaging and its people, figures and dates are fictional. All sources were checked on 9 October 2026.
- [1] Definitions of kickoff meeting, project charter, scope creep, RACI matrix, risk, issue, assumption, constraint, ground rules, rolling wave planning, statement of work, acceptance criteria and project success — Project Management Institute, PMI Lexicon of Project Management Terms, Version 5.0 (January 2026).
- [2] Kickoff roles (sponsor, project leader, facilitator, core team, stakeholders), a 90-minute run time for 3 to 14 people, agreed norms and a closing recap of next steps — Atlassian Team Playbook, Project Kickoff (no date displayed).
- [3] The project poster as a living alternative to a formal charter — Atlassian Team Playbook, Project Poster (no date displayed).
- [4] Driver, a single approver, contributors and informed parties for contested decisions — Atlassian Team Playbook, DACI decision-making framework (no date displayed).
- [5] One accountable person per item; the responsible person may also be accountable; support roles for additional helpers — IT@Cornell, RACI and RASCI Definitions (no date displayed).
- [6] Recording decision powers, limits of authority and tolerances; tolerance as the permitted deviation from a plan's time and cost target — Government Project Delivery (UK), The role of the senior responsible owner (13 August 2025, last modified 21 September 2025).
- [7] The premortem: team members assume the planned project has failed and generate reasons — Gary Klein, Performing a Project Premortem, Harvard Business Review (September 2007).
Build your next kickoff deck in NOXI, free: attach the charter and plan, match your company template, refine the scope and decision-rights slides with AI, and export an editable PowerPoint or PDF for the meeting.
