Annual Plan and Budget Presentation 2027: Template and AI Prompts

Between October and December, most companies turn next year's strategy into a funded plan and ask leadership to approve it. Here is the storyline approvers expect, a 16-slide annual plan and budget template, how to present the budget so it gets approved, a fully worked illustrative example, eight copy-ready prompts and a way to build the whole deck from your planning doc and budget spreadsheet.

Listen to article 2:27 Try NOXI free
Annual plan and budget presentation template — a strategy house, a budget bridge from FY2026 to FY2027 and a quarterly roadmap

TL;DR — the annual plan and budget presentation in one screen

  • The storyline: where we are → where we're going → how we'll get there → what it costs → when → how we'll know → what could go wrong → what we need you to decide.
  • The deck: 16 core slides plus an appendix. Look-back, strategy on a page, 3–5 priorities with OKRs, initiatives and owners, the budget (summary, year-over-year bridge, allocation, headcount, scenarios), a quarterly roadmap, KPIs, risks and the asks.
  • What gets a budget approved: every dollar of new spend tied to a priority and a measurable outcome, a bridge chart from this year's spend to next year's, stated assumptions, a downside scenario with triggers, and a specific decision on the last slide.
  • Timing: for a calendar fiscal year, the plan is drafted in October, argued over in November and approved in December, so start the deck now.
  • Fastest way to build it: upload your planning doc and budget spreadsheet to NOXI, which lays them out as strategy houses, bridges, Gantt roadmaps and scorecards, lets you edit by chat and exports an editable PowerPoint. It's free.

Quick answer: an annual plan and budget presentation answers five questions in order: where we are, where we're going, how we'll get there, what it costs and what leadership must approve. Use about 16 slides: look-back, strategy on a page, 3–5 priorities with OKRs, owners, the budget bridge, headcount, scenarios, a quarterly roadmap, KPIs, risks and asks.

Disclosure: NOXI publishes this guide, and NOXI is one of the tools described in it. The worked example is fictional and labelled as illustrative. We ran no hands-on tests of other tools. Facts about Copilot, Gemini, ChatGPT and Claude come from their vendors' help pages and announcements, checked in September 2026.

Definition What is an annual plan presentation? An annual plan presentation (often called an annual operating plan or AOP deck) is the slide deck in which a company, department or nonprofit presents next year's goals, priorities, initiatives, budget, headcount, roadmap, KPIs and risks to leadership or the board, and asks them to approve the plan and the spending that goes with it.

What is an annual plan and budget presentation, and who is it for?

It is the one deck that turns strategy into a funded, owned, dated plan for the next 12 months. Whoever owns a budget presents one: the CEO or CFO to the board, a department head to the executive team, a marketing or sales leader to the CEO, an executive director to a nonprofit board.

Three documents are often mixed up. Being clear about which one you're presenting prevents half the questions in the room:

DocumentHorizonAnswersTypical owner
Strategic plan3–5 yearsWhere we play, how we winCEO, strategy
Annual operating plan12 monthsWhat we'll do, by whom, whenLeadership team
Budget12 monthsWhat it costs, spending limitsFinance

The annual plan presentation combines the last two and points back to the first: the operating plan turns the multi-year strategy into goals, initiatives with owners and metrics, the budget sets the financial limits, and the deck explains why the money is worth spending.

Who it's for: the people who approve the money. A board wants risk, return and consistency with strategy. An executive team wants trade-offs between departments. A CFO wants assumptions that hold up.

The annual plan storyline: eight questions, in this order

Leadership reads an annual plan as a chain of questions. Build the deck so each section answers the next question before anyone asks it:

  1. Where are we? This year against plan: what we hit, what we missed and why.
  2. Where are we going? Strategy on a page: the vision, the 3–5 priorities and the foundations that support them.
  3. How will we get there? Priorities turned into OKRs, then into initiatives with named owners.
  4. What does it cost? The budget: totals, the bridge from this year, allocation by priority, headcount.
  5. What if we're wrong? Scenarios, with the trigger that moves you from one to the other.
  6. When will it happen? The roadmap by quarter, with milestones and review gates.
  7. How will we know? KPIs and quarterly targets that the QBRs will track.
  8. What do you need from us? Risks you want leadership to own with you, and the decisions you want today.

This is the Pyramid Principle applied to planning: put the answer first (the plan, the cost and the ask on one executive-summary slide), then give the supporting evidence in a logical order. Each slide title should be a full-sentence conclusion, not a label. Our guide to consulting-style slides and action titles goes deeper on writing those headlines.

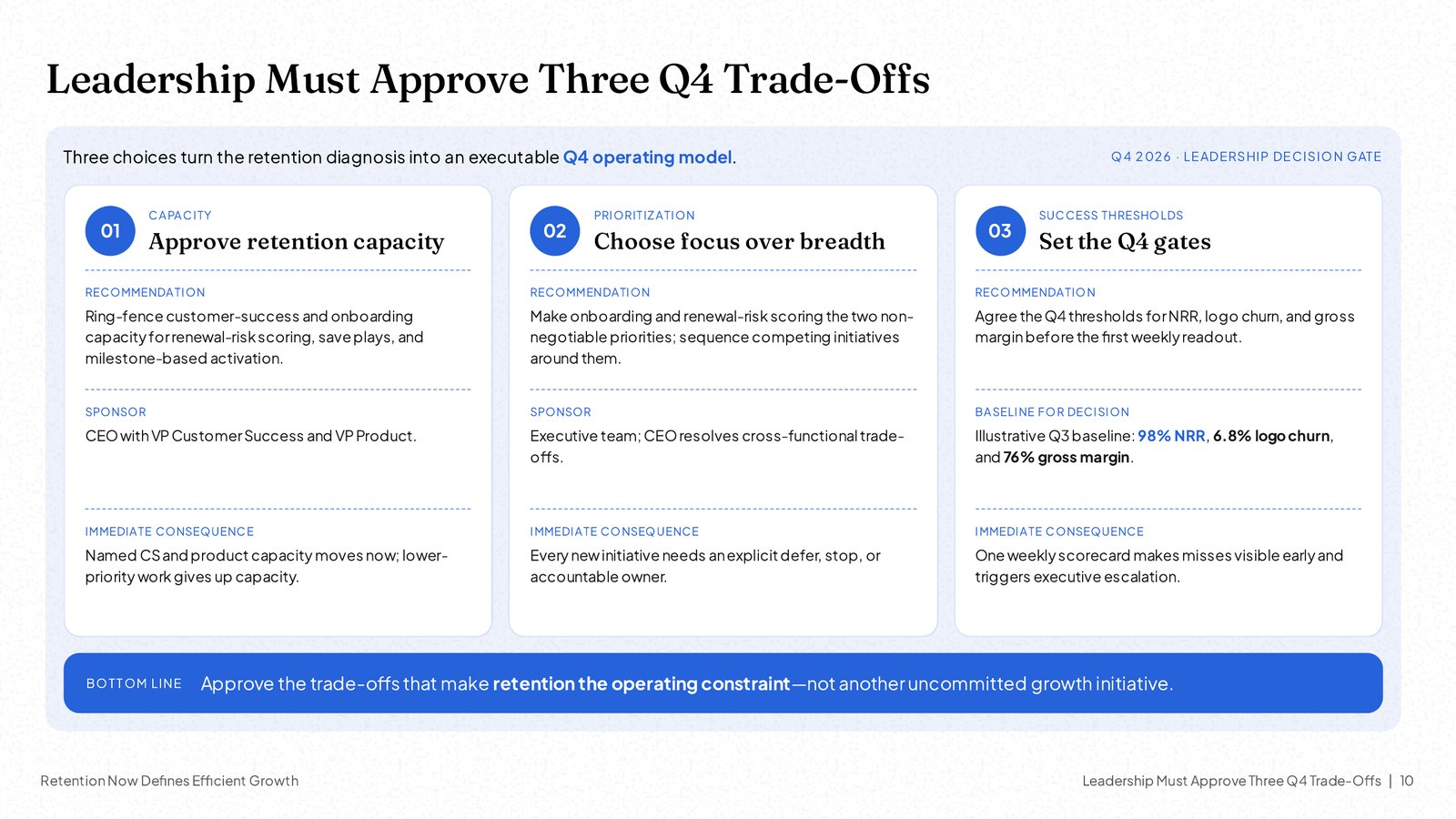

NOXI slide titled
Made in NOXI from a single prompt: the last slide of a planning deck turns the storyline into decisions, each with an owner and a consequence (fictional company).

Annual plan presentation template: slide by slide

Here is the 16-slide skeleton for a company AOP; department plans drop or merge a few slides (see variants).

#SlideWhat goes on itCommon mistake
1TitlePlan name, fiscal year, date, presenterNo fiscal year stated
2Executive summaryThe plan, total spend, top 3 asksSaving the ask for the end
3Look-back scorecardThis year's goals vs actualsHiding the misses
4What we learned3 lessons, market context, sourcesUnsourced market claims
5Strategy on a pageStrategy house: vision, pillars, foundationsTen pillars, no choices
6Priorities & OKRs3–5 objectives, 2–4 key results eachActivities posing as results
7Initiatives & ownersInitiative, owner, budget, milestoneTeams as owners, not people
8Financial summaryRevenue, costs, margin: this year vs planToo many P&L lines
9Budget bridgeWaterfall: this year's spend → next year'sOnly a total, no drivers
10AllocationNew money by priority and functionSpend not tied to priorities
11Headcount planNet hires by team, by quarter, costHires with no start dates
12ScenariosBase, downside, upside; triggersScenarios without triggers
13RoadmapGantt by quarter, milestones, gatesEvery task, no milestones
14KPIs & targets5–8 metrics, quarterly targetsAnnual targets only
15Risks & mitigationsTop 4–6 risks, owner, responseGeneric risks, no owners
16Decisions & asksSpecific approvals, amounts, dates"Questions?" as the last slide

Appendix: line-item budget, department pages, detailed assumptions, hiring plan by role, pricing or capacity models. Keep them out of the main flow and point to them when a question comes up.

Look-back: this year against plan

Start with honesty. A scorecard of last year's goals, each with a status (hit, partly hit, missed) and a one-line reason, earns credibility for the rest of the deck. If you missed a target, say what you learned and how it changed next year's plan. Follow it with one slide of context: market shifts, customer changes, competitor moves, with a source on the slide for every market figure.

Strategy on a page: the strategy house

A strategy house is a one-slide diagram shaped like a building. The roof is the vision or the multi-year ambition. The pillars are the 3–5 priorities for the year. The foundation is the enablers every pillar depends on: people, data, systems, culture, sometimes values. It shows the choices at a glance and gives every later slide a home: each initiative, budget line and KPI sits under one pillar.

Resist adding pillars: trade-offs are what the approvers are there to judge.

Priorities and OKRs

Turn each pillar into an objective and 2–4 key results. In the OKR method, an objective is what you want to achieve, and key results are specific, time-bound, measurable checks that show whether you got there. "Launch the AI module" is an activity; "25% of customers use the AI module by Q4" is a key result. Many teams set annual objectives and review key results quarterly, which ties the plan straight to the QBR cycle.

Initiatives and owners

A table: initiative, the priority it serves, one named owner (a person, not a team), budget and first milestone. Approvers use it to check the plan can be done, and to spot an owner with five initiatives.

The budget section: summary, bridge, allocation, headcount, scenarios

This is the heart of the deck, and the next section covers how to present it. Keep the financial summary to the lines that matter (revenue, costs, operating margin, cash if relevant), and give headcount its own slide, since people are usually the biggest cost line.

Roadmap by quarter

A Gantt with one lane per priority, initiative bars across Q1–Q4, milestone diamonds and marked review gates, for example "Q2 gate: release gated hires if pipeline ≥ plan". Keep it to 8–12 bars.

KPIs and targets

Five to eight metrics, each with a baseline, a year-end target and quarterly targets. Quarterly phasing matters: without it, nobody knows in April whether the plan is on track. This slide becomes the scorecard of every QBR next year. Our QBR presentation guide shows how to report against it each quarter.

Risks and decisions

List 4–6 real risks with likelihood, impact, an owner and a mitigation. Leave out generic ones like "macro uncertainty" unless you say what you'll do about them. End with the asks: each one specific (amount, headcount, date, policy), each one something the room can say yes or no to today.

How to present a budget so it gets approved

Budgets get approved when approvers can see what each dollar buys, what happens if you're wrong, and exactly what they're agreeing to. Six practices do most of the work.

1. Tie every dollar of new spend to a priority and an outcome

Approvers don't fund cost centres. They fund results. For each significant increase, show the priority it serves, the outcome it buys and when that outcome shows up. "Marketing +$600k" invites a haircut. "+$600k in enterprise programmes to generate 120 enterprise opportunities, supporting the $4M enterprise ARR key result" invites a discussion about the target, which is the discussion you want.

2. Show the bridge, not just the total

The single most useful budget slide is a bridge (waterfall) chart. It starts with this year's spend, adds and subtracts each driver (merit increases, full-year cost of this year's hires, new hires, new programmes, savings) and ends at next year's total. It answers "why is it going up?" before anyone asks, and it separates the increases you can't avoid from the choices you're asking approval for. Excel and PowerPoint both have a built-in waterfall chart type.

Tip Split the bridge into run-rate drivers (merit, full-year effect of this year's hires, contractual price rises) and discretionary drivers (new hires, new programmes). Approvers argue about the second group. Show them it's smaller than the total increase suggests.

3. State the assumptions on the slide

Growth rate, win rate, average deal size, churn, hiring start dates, salary inflation, exchange rates. A CFO will test the plan by changing one of them. Put the five that matter most on the financial summary or the scenario slide, and keep the rest in the appendix.

4. Bring a downside scenario with triggers

A base case alone looks optimistic. Base, downside and upside cases, each with revenue, spend and margin, show you've thought about being wrong. What makes it credible is the trigger: "If Q1 enterprise bookings are below $0.8M, we hold the 12 gated hires and cut $0.6M of programme spend." Gating part of the spend behind a mid-year review is often the fastest route to a yes. To keep forecast, target and scenario figures apart and show ranges instead of single points, see how to present forecasts without false precision.

5. Show what you stopped doing

Reallocation is more persuasive than addition. McKinsey research on resource allocation found that a third of companies move only about 1% of their capital between uses from one year to the next, and that companies that reallocate actively deliver higher shareholder returns than those that barely move. A slide of what you're cutting, pausing or consolidating to fund the priorities tells approvers you're managing the money, not just asking for more.

6. Pre-wire the numbers

Walk the CFO or finance partner through the budget before the meeting; surprises in the room turn a strategy discussion into an audit. Many teams send the full deck as a pre-read and present only the summary, bridge, scenarios and asks.

What CFOs and boards ask, and the slide that answers each question

Question in the roomSlide that answers it
Why is spend going up?Budget bridge
What do we get for it?Allocation + OKRs
What did you learn this year?Look-back scorecard
What are you assuming?Financial summary, scenarios
What if revenue comes in low?Scenarios and triggers
Why these hires, and when?Headcount plan
Who is accountable?Initiatives & owners
How will we know it's working?KPIs by quarter
What could go wrong?Risks & mitigations
What exactly are we approving?Decisions & asks

Variants: company AOP, department, marketing, sales and nonprofit plans

The storyline stays the same. What changes is the audience, the depth of the budget section and the one chart that carries the argument.

VariantAudienceMust-have slidesKey chart
Company AOPBoardFull 16 slidesBudget bridge
Department planExec teamOKRs, asks, headcountAllocation by priority
Annual marketing planCEO, CMOFunnel targets, channelsPipeline funnel
Annual sales planCEO, CROQuota, capacity, territoriesCapacity vs target
Nonprofit planBoardProgrammes, funding mixRevenue by source

Company AOP. Presented by the CEO and CFO, usually to the board late in the year. It needs the full financial picture, including cash and, for a startup, runway.

Department plan. It competes for a share of a fixed pool, so the allocation slide and the asks matter most. Show how your OKRs roll up to company priorities and what you'll stop doing. Eight to twelve slides is usually enough.

Annual marketing plan. Work backwards from the revenue target to pipeline, opportunities and leads, then show the channel mix and budget per channel. A funnel with targets at each stage is the centrepiece, followed by a quarterly campaign calendar.

Annual sales plan. The core is capacity: quota per rep, ramp time and attainment, and therefore how many reps you need, and when. A chart of capacity against target by quarter shows the gap immediately.

Nonprofit plan and budget. Programmes replace product lines, and the funding mix (grants, donors, earned revenue) replaces the revenue plan. The National Council of Nonprofits notes that staff usually prepare the budget and the full board typically adopts it, so present it for adoption. Show restricted and unrestricted funds separately.

A worked example: an FY2027 annual plan (illustrative)

Illustrative The company and all figures below are fictional, invented to show how the slides fit together. Replace them with your own numbers.

The company: "Contoso Freight", a fictional B2B logistics-software company with a calendar fiscal year. It expects to close FY2026 at $48.0M revenue, $41.5M total costs and 210 employees. The FY2027 plan goes to the board in December. Here are the slide titles, written as action titles, with the key content:

#Action titleKey content
2FY27: grow 21% to $58M and lift margin to 19%Plan, $46.8M costs, 3 asks
3We hit 4 of 6 FY26 goals; enterprise laggedScorecard, reasons
5Three pillars: enterprise, AI routing, retentionStrategy house
9Costs rise $5.3M; only $4.1M is discretionaryBridge chart
1098% of new discretionary spend funds a pillarAllocation
1124 net hires, half gated to a Q2 reviewHeadcount by team
12Even in the downside, margin still improves3 scenarios
16Three decisions we need todayAsks

Strategy house (slide 5). Roof: "The default platform for mid-market shippers by 2029". Pillars: (1) win mid-market and enterprise accounts, (2) ship AI route optimisation, (3) raise gross revenue retention. Foundation: data platform, sales and customer-success enablement, security certification.

OKRs (slide 6). Objective 1: become a credible enterprise vendor. Key results: enterprise share of new ARR from 30% to 40%; 12 new enterprise logos. Objective 2: make AI routing a reason to buy. Key results: general availability by end of Q3; 25% of customers using it by Q4. Objective 3: keep what we win. Key result: gross revenue retention from 88% to 92%.

The budget bridge (slide 9), from FY2026 costs of $41.5M to the FY2027 plan of $46.8M:

DriverTypeChangePillar
FY2026 total costsStart$41.5M—
Merit and wage increasesRun-rate+$1.2M—
Full-year cost of FY26 hiresRun-rate+$1.4M—
R&D hires (10)Discretionary+$1.2MAI routing
Sales hires (9)Discretionary+$0.9MEnterprise
Customer success hires (4)Discretionary+$0.4MRetention
Finance hire (1)Discretionary+$0.1MFoundation
Enterprise programmesDiscretionary+$0.6MEnterprise
AI cloud and toolingDiscretionary+$0.9MAI routing
Vendor consolidationSaving−$0.8M—
Office consolidationSaving−$0.6M—
FY2027 planEnd$46.8M—

Check the arithmetic the way a CFO would: run-rate +$2.6M, discretionary +$4.1M, savings −$1.4M, net +$5.3M. Of the $4.1M discretionary, $4.0M funds a pillar (98%) and $0.1M funds the foundation. Headcount goes from 210 to 234.

Scenarios (slide 12):

CaseRevenueCostsOp. marginTrigger
Downside$53.5M$44.9M16.1%Q1 enterprise < plan
Base$58.0M$46.8M19.3%—
Upside$61.5M$47.6M22.6%Pipeline ≥ 120%

In the downside, Contoso holds the 12 gated hires (−$1.3M) and trims programmes (−$0.6M). In the upside, it releases $0.8M of extra marketing. FY2026 operating margin is about 13.5%, so even the downside improves on this year, which is exactly what slide 12's title claims.

Roadmap (slide 13): Q1: new enterprise pricing and packaging, first sales hires ramping. Q2: AI routing beta with 20 customers; gate review in May to release or hold the 12 gated hires. Q3: AI routing general availability, security certification. Q4: renewal campaign, FY2028 planning.

Asks (slide 16): (1) approve FY2027 costs of $46.8M, with 12 hires gated to the Q2 review; (2) approve a $0.9M cloud commitment for AI routing; (3) agree the enterprise pricing change for launch on 1 February.

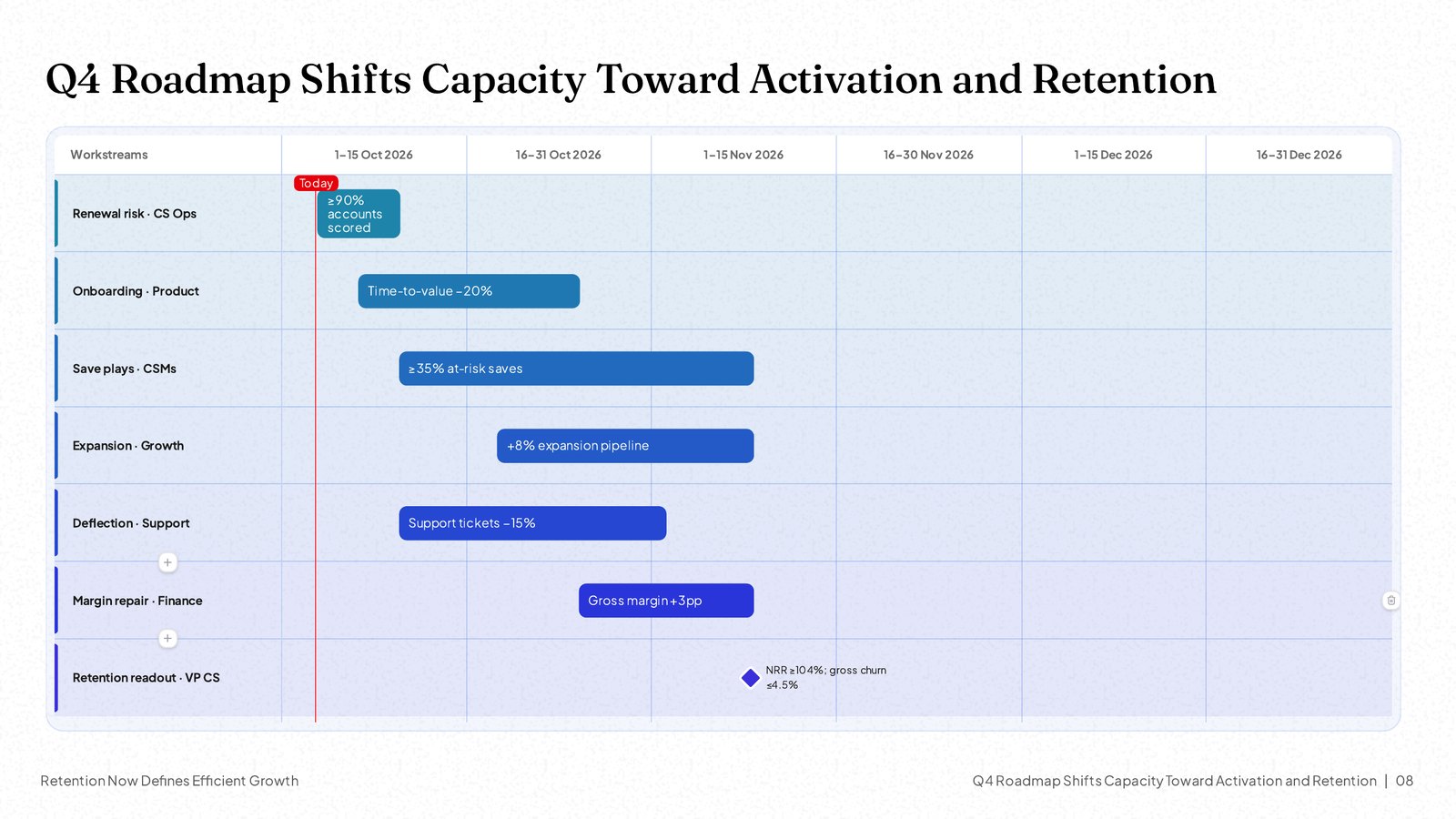

NOXI roadmap slide: a Gantt timeline of seven workstreams from October to December with owners, milestones and a
Made in NOXI from a single prompt: a quarter roadmap as a Gantt timeline, one workstream per owner, with a milestone and a "today" marker (fictional company).

8 copy-ready AI prompts for an annual plan presentation

These work in NOXI and in most capable AI assistants. Replace the brackets and attach your files. More patterns are in our prompts for presentations guide.

Prompt 1 · Full deck

Using the attached [planning doc] and [budget spreadsheet], build a 16-slide FY[2027] annual plan presentation for [the board]. Order: executive summary, look-back scorecard, what we learned, strategy house, priorities with OKRs, initiatives and owners, financial summary, budget bridge from FY[2026] to FY[2027], allocation by priority, headcount plan, scenarios, quarterly roadmap, KPIs with quarterly targets, risks, decisions and asks. Write every title as a full-sentence conclusion. Use only figures from my files; mark anything missing as [TBD].

Prompt 2 · Look-back scorecard

Make slide 3 a scorecard of our FY[2026] goals from the attached sheet: goal, target, actual, status (hit / partly / missed) and a one-line reason. Title it with the honest headline, including the biggest miss.

Prompt 3 · Strategy house and OKRs

Turn our strategy into a strategy house: roof = [vision], pillars = [3–5 priorities], foundation = [enablers]. Then make one slide with an objective and 2–4 measurable key results per pillar, each with a baseline and a year-end target.

Prompt 4 · Budget bridge and allocation

Build a waterfall chart from FY[2026] total costs [$X] to the FY[2027] plan [$Y] using these drivers: [list with amounts]. Colour run-rate, discretionary and savings differently. Then add a slide showing how discretionary spend splits across the pillars, and title it with the share that funds a priority.

Prompt 5 · Headcount and scenarios

From the hiring tab, make a headcount slide with net hires by team and by quarter and their FY cost. Then make a scenario slide with base, downside and upside cases (revenue, costs, operating margin) and one trigger per case. The downside must say which spend we hold.

Prompt 6 · Quarterly roadmap

Make a Gantt roadmap for FY[2027] with one lane per pillar, 8–12 initiative bars across Q1–Q4, milestones as diamonds and a clearly marked review gate in [month]. Put the owner's name on each bar.

Prompt 7 · Executive summary and asks

Write the executive summary as one slide: the plan in one sentence, three numbers (revenue, total costs, margin), the three pillars and the three decisions we need. Then make the final slide list each ask with the amount, the date and what happens if it's not approved.

Prompt 8 · CFO challenge

Act as a sceptical CFO reviewing this deck. List the 10 hardest questions you would ask about assumptions, spend and risk, say which slide should answer each one, and flag every figure that isn't backed by the attached files or a cited source.

How to build an annual plan presentation in NOXI

NOXI builds the deck from your own planning material, then lets you edit it by chat or by hand. It's free: every feature, frontier models (Claude Opus and GPT-5.5 for the content, Nano Banana Pro for images), no watermark and no export paywall. Budget about an hour for a first full draft you'd be happy to pre-wire with finance.

Step 1 — Upload the planning doc and the budget sheet

Upload what you have: the planning document (Word or PDF), the budget export (Excel or CSV), last year's results and notes. For more on building from documents, see our guide to turning a PDF or Word file into a presentation.

Step 2 — Apply your brand template

Add your company's brand template so the deck comes out in your colours, fonts and logo. You can also upload last year's plan or any PDF or PPTX, and NOXI generates the deck in that style, something almost no other AI presentation tool does.

Step 3 — Give the brief: audience, fiscal year, structure

Paste Prompt 1 or write your own: who approves the plan, which fiscal year and the slide order. Ask NOXI to use only your figures and mark gaps as [TBD].

Step 4 — Let NOXI lay out the analytical slides

NOXI chooses consulting-grade layouts for each job: a strategy house for strategy on a page, a scorecard for the look-back and KPIs, data charts for the financial summary and bridge, comparison tables for scenarios and a Gantt timeline for the roadmap. For market-context slides it can research the topic and put the source link for each figure on the slide.

Step 5 — Edit by chat or by hand

Refine in plain language: "make slide 9 a waterfall with run-rate and discretionary in different colours", "shorten every title to two lines", "move the gated hires into a separate bar". Or drag, resize and retype in the editor. You can review a draft on your phone too.

Step 6 — Verify every number

Check each figure against the budget sheet, make sure the bridge adds up, open every cited source and confirm the KPI baselines match last year's scorecard. Then run Prompt 8 to find the CFO's questions before the meeting does.

Step 7 — Export PowerPoint and PDF, and share

Download the .pptx for finance and the board pack, a PDF for the pre-read and a share link for reviewers. The .pptx matches the approved slides, so it's ready to send.

Exporting the plan to PowerPoint: the file finance can keep working in

Annual plans rarely end in the tool that drafted them: finance adds the last numbers and the board pack goes out as PowerPoint or PDF. NOXI builds the .pptx with its own export engine, and the file you download matches the slide you approved.

Why that's rare. Most AI slide tools design in a web or card format and then have to squeeze the result into PowerPoint. The usual shortcuts are generating a PDF and running it through a PDF-to-PowerPoint converter, or exporting pictures of the slides. Either way, text breaks into fragments or gets baked into images, fonts are swapped and layouts drift. NOXI instead rebuilds every slide as real PowerPoint objects on real 16:9 slides:

  • The file matches the slide: same layout, spacing, colours and typography.
  • Text is live: click any title, number label or note and edit it in PowerPoint.
  • Fonts travel inside the file, Arabic included, with letters connected and right-to-left layout kept, so the deck looks the same on a board member's laptop.
  • Images keep their original quality, and the file opens in PowerPoint without a repair prompt.
  • Free, with no watermark, plus PDF and a share link.

Why it matters. Finance and the board get a file that opens looking identical and that anyone can keep editing. Almost no other AI presentation tool produces a pixel-perfect PowerPoint like this.

Other ways to make an annual plan presentation

NOXI isn't the only route. Here is an honest view of the alternatives, based on vendor documentation checked in September 2026.

RouteBest forCostWatch out for
Manual templateFull controlFree–paidDays of layout work
Copilot in PowerPointCompany templateCopilot licenceNo sourced research
Gemini in SlidesWorkspace teamsPaid plansEnglish (US) only
ChatGPT for PowerPointEditing in PowerPointFree tier (beta)Charts limited
Claude SlidesReasoning-heavy draftsPaid (beta)Rolling out
NOXIDesigned, sourced deck$0—

Manual templates give total control, but strategy houses, bridges and Gantt charts are slow to build by hand. Copilot can start from your organisation's template and reference a Word document. Gemini in Google Slides has built full decks since June 2026, in English (US) only, on eligible paid plans. ChatGPT for PowerPoint (beta since May 2026, Free tier included) works inside PowerPoint from notes, documents or spreadsheets, with chart and template handling still limited. Claude Slides (beta since 16 September 2026, Pro and Max first) downloads as PowerPoint or PDF. For a wider comparison, see the best AI presentation maker for business.

The planning calendar: when to build each version of the deck

Finance-planning guides suggest starting the annual plan three to four months before the fiscal year ends. For a calendar fiscal year, that means the deck goes through several versions between September and January:

WhenPlanning stepDeck version
Sep – early OctStrategy refresh, top-down targetsStrategy house, targets
OctoberDepartment plans, bottom-up budgetsDepartment decks
Early NovemberConsolidation, gap-closingDraft v1, bridge
Mid–late NovemberLeadership review, trade-offsv2 with scenarios
DecemberBoard approvalFinal deck, pre-read
JanuaryCascade to teamsAll-hands version

The October QBR usually feeds the plan: its lessons become the look-back and its asks become budget lines. Expect to rebuild the deck several times as numbers change. If your fiscal year starts in April or July, shift the calendar accordingly.

Annual plan presentation checklist

  1. The executive summary stands alone.Plan, cost and asks on one slide.
  2. Titles tell the story.Read in order, the titles alone make the argument.
  3. The look-back is honest.Misses shown, with what changed because of them.
  4. 3–5 priorities, not ten.Every initiative, budget line and KPI sits under one.
  5. Key results are measurable.Baseline, target and date on each.
  6. One named owner per initiative.A person, not a team.
  7. The bridge adds up.Start + drivers = end, checked by finance.
  8. Discretionary spend is tied to outcomes.Each increase names the result it buys.
  9. Scenarios have triggers.And the downside says which spend you hold.
  10. KPIs are phased by quarter.So QBRs can track them from Q1.
  11. Every external figure has a source.On the slide, not in your head.
  12. The last slide is a decision.Amounts, dates, yes-or-no asks.

8 common annual plan presentation mistakes

1. Leading with history. Ten slides on this year before the plan appears. Put the answer on slide 2.

2. A strategy with no choices. Seven pillars that cover everything leave the budget no trade-offs to show.

3. The budget as a spreadsheet screenshot. Show the summary and the bridge; line items go to the appendix.

4. Last year plus 10%. Budgets without drivers invite across-the-board cuts. Build from drivers.

5. Activities instead of outcomes. "Launch three campaigns" is a task; "120 enterprise opportunities" is a result.

6. No downside plan. A single case signals optimism, not confidence.

7. Unsourced numbers. A market-growth figure with no source becomes the debate. AI drafts make this worse: models can state an invented statistic confidently, so check every figure. Our guide to AI presentations with research citations covers how to verify them.

8. Ending on "Questions?" The last slide should list the decisions, so the meeting ends with approvals rather than a vague "let's take it offline".

Frequently asked questions

What should be included in an annual plan presentation?
An executive summary, a look-back at this year against plan, strategy on a page (a strategy house), 3–5 priorities with OKRs, initiatives with named owners, the budget (financial summary, a bridge from this year to next, allocation, headcount and scenarios), a quarterly roadmap, KPIs with quarterly targets, risks with mitigations, and the decisions you need.
How many slides should an annual plan presentation have?
About 16 core slides for a company annual operating plan, plus an appendix with line-item budgets and department detail. A department, marketing or sales plan usually needs 8–12 slides. If you circulate a pre-read, present only the executive summary, the budget bridge, the scenarios and the asks.
What is the difference between an annual operating plan and a budget?
The annual operating plan says what the organisation will do next year, who owns each initiative, when it happens and how success is measured. The budget says what it will cost and sets the spending limits. The strategic plan above both sets the 3–5-year direction. An annual plan presentation usually presents the operating plan and the budget together.
How do you present a budget to leadership?
Lead with the total and the asks, then show a bridge chart from this year's spend to next year's, split into run-rate and discretionary drivers. Tie every discretionary increase to a priority and a measurable outcome, state your key assumptions, bring a downside scenario with a trigger, show what you stopped funding, and walk finance through the numbers before the meeting.
What chart is best for showing a budget change from one year to the next?
A bridge chart, also called a waterfall chart. It starts at this year's total, adds and subtracts each driver such as merit increases, new hires, new programmes and savings, and ends at next year's total. Excel and PowerPoint both include a built-in waterfall chart type.
How is an annual marketing or sales plan presentation different?
The storyline is the same, but the centre of the deck changes. A marketing plan works backwards from the revenue target to pipeline, opportunities and leads, then shows the channel mix and budget. A sales plan centres on capacity: quota, ramp time and attainment, and therefore how many reps are needed and when.
Can AI make an annual plan presentation from my budget spreadsheet?
Yes. Tools like NOXI build the deck from an uploaded planning document and budget export (Excel or CSV) and lay it out as a strategy house, bridge chart, Gantt roadmap and KPI scorecard. Tell the AI to use only your figures and to mark gaps, then check every number against the spreadsheet before presenting.
Is there a free annual plan presentation template?
Yes. The 16-slide structure in this guide is free to copy into any tool. NOXI is also free with every feature, including brand templates, AI editing and PowerPoint export, with no watermark. Microsoft and Google offer basic business templates, but you still build the strategy house, bridge and roadmap yourself.
Can I export the annual plan deck to PowerPoint and keep editing it?
Yes. NOXI builds the .pptx with its own export engine, and the file matches the approved slides exactly: text stays live and editable, fonts are embedded in the file and images keep their original quality. It opens in PowerPoint without a repair prompt, so finance can keep working in it.
When should annual planning start?
Finance-planning guides suggest starting three to four months before the fiscal year ends. For a calendar fiscal year, that means strategy and targets in September and October, department plans in October, consolidation and leadership review in November, and board approval in December.

Sources & methodology

The structure and advice combine standard finance-planning practice with the sources below. The worked example is fictional. Facts about other tools come from vendor pages and announcements checked on 25 September 2026; we ran no hands-on tests of them.

Try NOXI free: upload your planning doc and budget sheet and get a board-ready annual plan with a strategy house, budget bridge, Gantt roadmap and KPI scorecard, then export an editable PowerPoint with no watermark.

Written by Aidar Akmaev

Founder and designer of NOXI, an AI presentation maker for professional, consulting-grade decks. NOXI is one of the tools discussed here — see the disclosure at the top.
