How to build a business case presentation that gets a clear decision

This guide gives you a twelve-slide business case template, an options comparison with the status quo and a do-minimum, an assumptions register, NPV, payback and IRR worked step by step, a sensitivity table with switching values, a finance reviewer's checklist, three AI prompts and a NOXI workflow.

Listen to article 2:23 Try NOXI free
Business case presentation — NOXI guide cover: one investment decision built from the status quo, the options, NPV, sensitivity and a clear ask

Disclosure: NOXI publishes this guide and is one of the tools it mentions; the method works in any presentation software.

Quick answer: A business case presentation exists to get one approval. Open with the exact ask, show what the status quo costs, and compare three to five options, including the status quo and a do-minimum. Back the recommended option with costs, benefits and stated assumptions, NPV, payback and IRR, then show what would change the decision, the main risks, the delivery plan with benefit owners, and the ask again with its conditions. Twelve slides plus an appendix cover most investment decisions.

The worked example is fictional: Harbourline Supplies, a distributor deciding whether to automate supplier-invoice matching. Its figures are invented for teaching, and every calculation is shown so you can check it or rerun it with your own numbers.

In short

  • One decisionSlide 1 states the option, amount and phasing, conditions, owner and date.
  • BaselineMeasure every option against the status quo, which is rarely free; include a do-minimum, often the real competitor.
  • Cash vs valueOnly cash-releasing benefits go into the NPV; report redeployed time separately; leave sunk costs out.
  • NumbersShow NPV, payback and IRR with the discount rate and horizon, and keep year 0 outside Excel's NPV function.
  • SensitivityName the switching value: the level of an assumption at which the recommendation stops being the best choice.
  • Safe to approveStage gates, benefit owners and review dates let an approver say yes without betting everything on the base case.

What is a business case presentation?

A business case presentation is the slide version of a business case: it asks a named decision-maker to approve one investment and shows why the recommended option beats the alternatives, including carrying on as now. Its purpose is a decision, so every slide either supports the recommendation or tests it.

Definition What is a business case? A business case is the document or presentation that gives a decision-maker the evidence to approve, change or reject a proposed investment: the problem, the options including the status quo, their costs, benefits and risks, the recommended option, and how it will be delivered and measured.

HM Treasury's guidance describes a business case as the information, evidence and options appraisal a decision-maker needs, and stresses that the thinking behind it matters as much as the document (HM Treasury, Guidance on Developing Business Cases, 2026). If the slides could have been written before the options were compared, the analysis is not finished. The business case is easy to confuse with its neighbors:

DocumentWhat it decidesTypical audienceCore question
Business caseWhether to fund one proposal, and which optionSponsor, finance, investment committeeIs this option worth its cost compared with the alternatives?
Business planHow a business or unit will operate and growOwners, lenders, investorsHow will we create value over the next few years?
Project proposalWhat a project will deliver, how and whenSponsor, project teamWhat will we do, by when, with whom?
Budget presentationHow much each area gets for a yearLeadership, boardWhere does next year's money go?
Pitch deckWhether to invest in a companyExternal investorsWill this company return our money?

A business case usually competes for money inside a budget that is already set; our guide to the annual plan and budget presentation covers the deck that sets it.

The 12-slide business case presentation template

A complete business case presentation needs twelve main slides: the ask, problem, objectives, options, comparison, recommendation, assumptions, financials, sensitivity, risks, plan and decision. The financial model, the full assumptions register and the risk log go in an appendix.

#SlideQuestion it answersWhat goes on it
1The askWhat are we being asked to approve?Decision sentence, amount and phasing, NPV, payback and IRR, conditions, decision date
2Problem and status quoWhat happens if we say no?Cost of the current process in money, time and risk; the trend; why now
3ObjectivesWhat must be true when this succeeds?Two to four measurable objectives, each with a baseline, a target and a date
4Options consideredWhat else could we do?The longlist with a reason for each dropped option; the shortlist with status quo and do-minimum
5Options comparisonWhich option gives the best value?One table: cash flows, NPV, payback, IRR and non-financial criteria
6Recommended optionWhat exactly will we do?Scope in and out, how it works, what changes for people and suppliers
7Costs, benefits, assumptionsWhat do the numbers rest on?One-time and running costs, benefits by category, the assumptions that matter with their evidence
8Financial summaryIs it worth it, and can we afford it?Cash-flow profile, NPV, payback, IRR, and this year's cash and budget impact
9SensitivityWhat would change the decision?Tested ranges, a tornado chart, switching values
10Risks and mitigationsWhat could go wrong, and who watches it?Four to six risks with early signals, mitigations, owners and the contingency
11Plan and benefitsHow will we deliver and prove it?Milestones, stage gates, benefit owners, review dates
12DecisionWhat do we decide today?The ask restated with conditions, the next checkpoint, what starts after approval

Write each title as a full-sentence finding ("Automated matching beats the cheaper fix by $87,000 of NPV"), not a label ("Options analysis"). If the twelve titles make the argument on their own, the structure works; our guide to consulting-style slides covers action titles in depth.

How many slides, and how long?

Twelve slides fit a 30-minute decision slot with a pre-read: about 15 minutes of presenting, the rest for questions. For a ten-minute item, merge to six: ask, problem, options, financials with sensitivity, risks and plan, decision. For pacing, see our slides-per-minute guide.

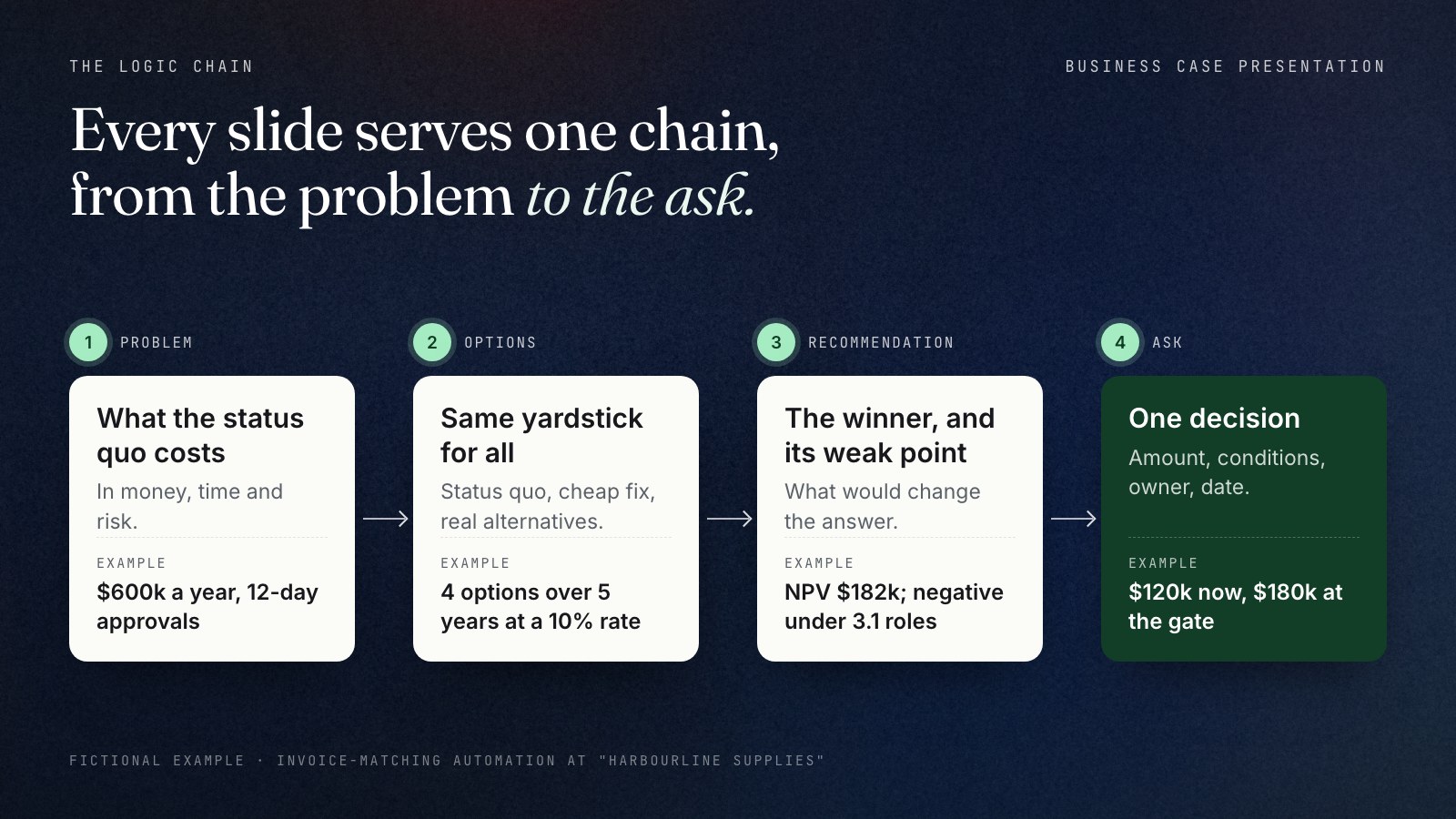

Diagram of the business case logic chain in four linked cards: 1 Problem, what the status quo costs ($600k a year and 12-day approvals in the example); 2 Options on the same yardstick (4 options over 5 years at a 10% rate); 3 Recommendation, the winner and its weak point (NPV $182k, negative under 3.1 roles released); 4 Ask, one decision with amount, conditions, owner and date ($120k now, $180k at the gate).
Each slide must serve the chain from problem to ask; a slide that serves none of the four links belongs in the appendix.

Where the template comes from: the Five Case Model

The Five Case Model is HM Treasury's standard framework for business cases: one proposal examined from five linked perspectives, the strategic, economic, commercial, financial and management cases. Its questions make a good checklist for any business case, public or private.

It is mandatory for significant spending in the UK and Welsh governments and is also used by devolved governments, many local authorities and some charities bidding for public funds (HM Treasury, 2026).

CaseWhat it must showWhere it sits in the 12 slides
StrategicA compelling case for change and fit with the organization's objectivesSlides 2 and 3
EconomicThe option that gives the best value for money, after appraising a shortlistSlides 4, 5, 7 and 9
CommercialA viable deal with suppliers: procurement route, risk allocation, payment termsSlides 6 and 10, contract detail in the appendix
FinancialAffordability: funding, budget and accounting effectsSlide 8
ManagementArrangements for delivery: governance, plan, benefits, risk, evaluationSlides 10 and 11

Two ideas travel well. Value and affordability are separate questions: the guidance keeps the economic case in real, discounted terms and the financial case in nominal budget terms, so slide 8 shows both NPV and this year's cash impact. And the case matures in stages (Strategic Outline, Outline and Full Business Case), much as companies move from concept approval to investment approval to contract.

Write the ask first, then price the status quo

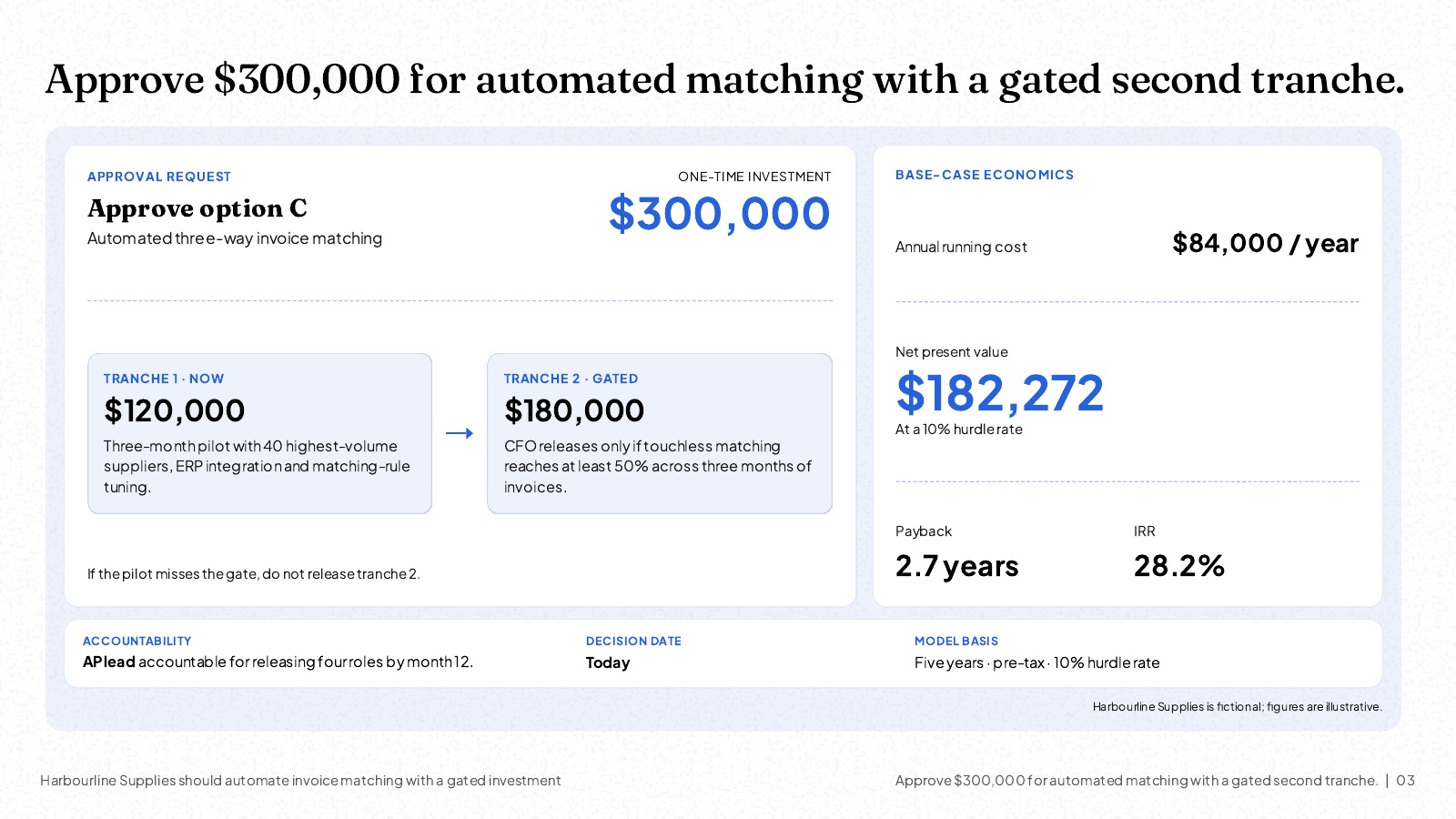

The first slide states the decision you want: the option, the amount and its phasing, the conditions, the accountable owner and the date. The second shows what happens if the answer is no, because the status quo is the baseline every number in the deck is measured against.

Example Harbourline Supplies (fictional) receives 96,000 supplier invoices a year. Ten accounts-payable clerks match each one by hand against its purchase order and goods receipt, a check called a three-way match. At 10 minutes an invoice, that is 16,000 hours a year: ten clerks at 1,600 productive hours each. At a loaded cost of $60,000 per clerk, matching costs $600,000 a year, and approval takes 12 days on average. Finance sets a 10% hurdle rate for IT investments.

Draft the ask before the rest of the deck, then sharpen it until an approver could minute it word for word:

ElementWeakStrong (Harbourline)
Decision"Support for the AP automation initiative""Approve option C: automated three-way matching"
Money"Budget of around $300k""$300,000 one-time in two tranches, plus $84,000 a year from contract start"
ConditionsNone"The $180,000 second tranche is released by the CFO only if the pilot reaches 50% touchless matching"
Owner"Finance team""AP lead accountable for releasing four roles by month 12"
Date"As soon as possible""Decision today; pilot starts in month 1"

The status quo is rarely "do nothing": the Treasury guidance warns that without the proposal the organization would still act, at a cost. Harbourline's keeps spending $600,000 a year and keeps the 12-day cycle; comparing option C with zero would hide both.

Compare options, including the status quo and a do-minimum

A business case should compare three to five options on one yardstick: the status quo, a do-minimum that just meets the objective, the recommended option and at least one more ambitious alternative. Without them, approvers cannot tell whether the recommendation is the best use of the money or simply the first idea.

Definition What are business as usual and do minimum? Business as usual (BAU), or the status quo, is what is expected to happen if the proposal is not approved; it is the baseline against which every option's costs and benefits are measured. A do-minimum option is the least that would meet the proposal's objectives, and nothing more.

The Treasury guidance asks for a shortlist of around five options and requires both business as usual and the do-minimum on it, attractive or not, because they anchor the comparison. Give each dropped longlist option one line of reason on slide 4, so nobody reopens it in the meeting.

Example Harbourline's shortlist, five years at 10%, year-end cash flows. B: tune the ERP's matching rules and run a purchase-order campaign with suppliers; $40,000 one-time, $10,000 a year, one role released from year 2. C: software that matches invoices with no human touch when the documents agree; $300,000 one-time, $84,000 a year, four roles released, half the saving in year 1. D: a full accounts-payable suite with a supplier e-invoicing portal; $650,000 one-time, $150,000 a year, six roles, half in year 1.
OptionNet cash flow: year 0; year 1; years 2–5NPV at 10%PaybackIRR

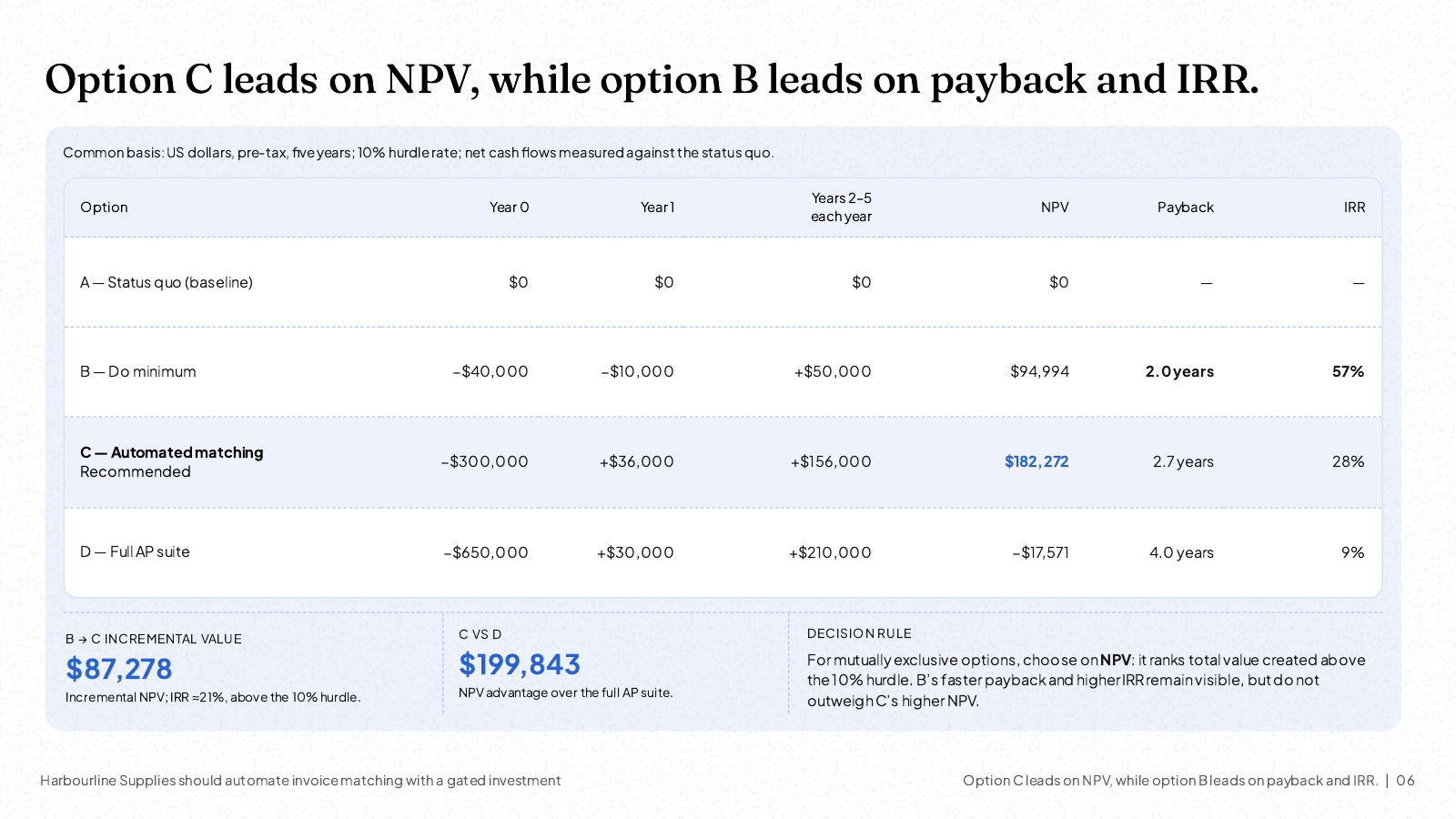

A. Status quoBaseline; still costs $600,000 a year$0——
B. Do minimum−$40,000; −$10,000; +$50,000 a year$94,9942.0 years57%
C. Automate matching−$300,000; +$36,000; +$156,000 a year$182,2722.7 years28%
D. Full AP suite−$650,000; +$30,000; +$210,000 a year−$17,5714.0 years9%

Payback and IRR rank B first; NPV ranks C first. For mutually exclusive options, rank by NPV, which measures the value created in money, while IRR and payback favor small, quick projects. Check with the increment: moving from B to C costs $260,000 more up front and returns $46,000 more in year 1 and $106,000 more in each later year. That increment has an NPV of $87,278 (182,272 − 94,994) and an IRR of about 21%, above the 10% hurdle.

Show non-financial criteria beside the numbers: Harbourline's approval cycle would fall from 12 days to about 10 with B, 4 with C and 3 with D (fictional targets), and D carries the most delivery risk. The real competitor to a proposal is rarely the status quo; it is the cheap fix, so give the do-minimum an honest hearing.

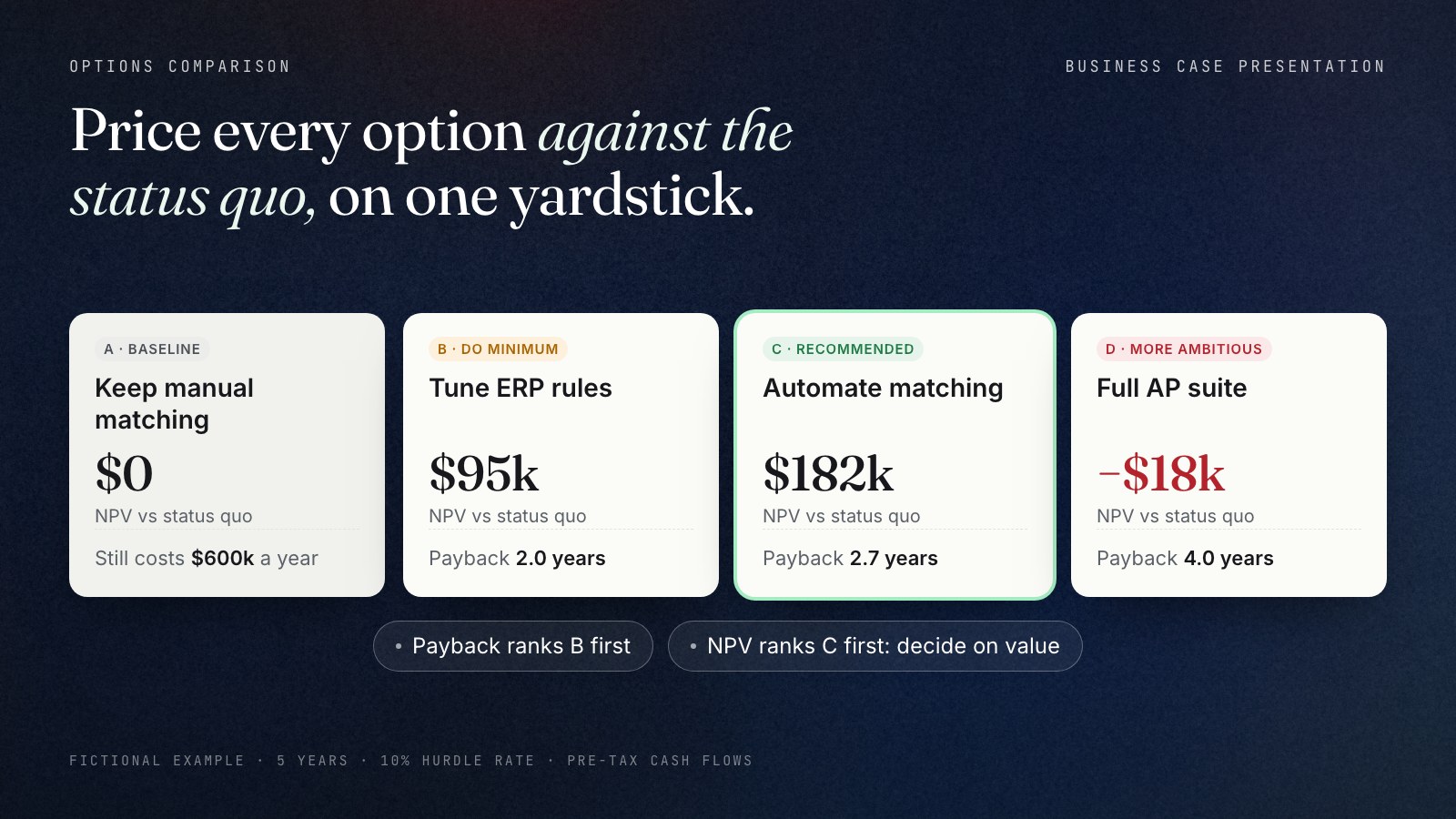

Options comparison for the fictional Harbourline case, all priced against the status quo over five years at a 10% hurdle rate: A, keep manual matching, NPV $0 and still costs $600k a year; B, tune ERP rules, NPV $95k, payback 2.0 years; C, automate matching, recommended, NPV $182k, payback 2.7 years; D, full AP suite, NPV minus $18k, payback 4.0 years. Payback ranks B first, NPV ranks C first.
Every option is measured against the status quo on one yardstick; when payback and NPV disagree, decide on value.

Count costs and benefits against the baseline

Count only the costs and benefits that change because of the decision, measured against the status quo. Only cash-releasing benefits go into the NPV; other benefits are reported beside it; every cost is included, internal time and contingency too; sunk costs stay out.

The Treasury guidance sorts benefits into four categories that work as well in a company:

CategoryWhat it meansHarbourline exampleIn the NPV?
Cash-releasingA budget line changes: spend falls or income risesFour roles released: $240,000 a year at full rateYes
Non-cash-releasingHas a money value, but no budget changes1.8 roles of time moved to supplier-statement reconciliation, worth $108,000 a year at loaded costNo: reported
QuantifiableMeasurable, not in moneyApproval cycle from 12 days to 4No: a target
QualitativeDescribed in wordsA full audit trail for every match decisionNo: described

Saved hours are not saved cash

The most common inflation in a business case is turning hours into dollars. Hours become cash only when a budget line falls: a contract ends, a vacancy stays empty, a planned hire is avoided. Show the arithmetic from hours to roles, then say which roles leave and how.

StepCalculationResult
Hours today96,000 invoices × 10 minutes ÷ 6016,000 hours (10 roles)
Hours after35% exceptions: 96,000 × 0.35 × 12 minutes ÷ 606,720 hours
Hours freed16,000 − 6,7209,280 hours = 5.8 roles at 1,600 hours
Roles released2 contractor roles end at go-live; 2 leavers not replaced4 × $60,000 = $240,000 a year
Redeployed5.8 − 4.01.8 roles, not counted as cash

The model assumes 65% touchless matching and 12 minutes per remaining exception, since only the hard cases are left. Releasing four roles needs 6,400 freed hours, reached only if touchless matching hits 50%: that becomes the pilot gate.

Every cost, and none already spent

Harbourline's $300,000 one-time cost is $160,000 for configuration and ERP integration, $60,000 to backfill the project team, $30,000 for training, and a $50,000 contingency (20% of the $250,000 base). Running costs are $84,000 a year: a $72,000 subscription ($0.75 × 96,000 invoices) and $12,000 for a fifth of an administrator. The $35,000 already spent on a proof of concept stays out: the Green Book says costs already incurred must not be included in an appraisal (HM Treasury, The Green Book, 2026).

Size the contingency with evidence, not habit. The Green Book requires explicit adjustments for optimism bias, the tendency to underestimate costs and durations and overestimate benefits; its supplementary guidance puts the capital-cost upper bound for equipment and development projects, ICT included, at 200% (lower bound 10%) (HM Treasury, optimism bias guidance). A 20% contingency on a software integration is a judgment the sensitivity slide must test.

The assumptions register

An assumptions register lists every input the answer depends on, with its evidence, owner and the range tested. It lives in the appendix; slide 7 shows the few that move the answer most.

IDAssumptionEvidenceOwnerRange tested
A196,000 invoices a year, 10 minutes eachERP extract; two-week time studyAP leadHeld
A265% touchless matching after ramp-upProof of concept on three months of invoicesAP leadGate at 50%
A3Four roles at $60,000; half the saving in year 1HR plan: two contracts end, two leavers not replacedCFO, HR3 to 5 roles
A4$300,000 one-time, with $50,000 contingencyVendor quote plus internal estimateProject lead−10% to +50%
A5$84,000 a year running costSubscription quote plus 0.2 of an administratorIT leadSubscription ±20%
A6Go-live at month 6Vendor plan: pilot, then phased rolloutProject lead6 months late
A710% rate, five years, pre-tax, flat pricesFinance policy for IT investmentsFinance8% to 12%

NPV, payback and IRR: calculate them correctly, say them plainly

Net present value is the value today of a project's future net cash flows, discounted at the required rate, minus the investment; payback is the time until cumulative cash flows recover the investment; IRR is the discount rate at which NPV is zero. Show all three, with the discount rate and horizon on the slide and one plain sentence for each.

Definition What is net present value (NPV)? Net present value is the sum of a project's future net cash flows, each discounted to today's value at a stated rate, minus the initial investment. A positive NPV means the project earns more than the required rate; the NPV is the surplus above that return, in today's money.
Definition What is the payback period? The payback period is the time it takes for a project's cumulative net cash flows to recover the initial investment. It ignores the time value of money and all cash flows after the payback point; the discounted payback period uses discounted cash flows and is always longer.

Finance reviewers expect all three. In Graham and Harvey's survey of 392 chief financial officers, 74.9% always or almost always used NPV and 75.7% IRR; payback came next at 56.7%, despite its known weaknesses (Graham and Harvey, 2002). Here is option C, step by step:

Option C, $Year 0Year 1Year 2Year 3Year 4Year 5
One-time cost−300,000—————
Roles released—4 (half year)4444
Saving at $60,000 a role—120,000240,000240,000240,000240,000
Running cost—−84,000−84,000−84,000−84,000−84,000
Net cash flow−300,00036,000156,000156,000156,000156,000
Discount factor, 10%1.00000.90910.82640.75130.68300.6209
Present value−300,00032,727128,926117,205106,55096,864
Cumulative cash−300,000−264,000−108,00048,000204,000360,000
Cumulative present value−300,000−267,273−138,347−21,14285,408182,272
  1. Discount factor = 1 ÷ 1.10 to the power of the year. Year 2: 1 ÷ 1.21 = 0.8264.
  2. Present value = net cash flow × discount factor. Year 2: 156,000 × 0.8264 = 128,926.
  3. NPV = present values of years 1 to 5 minus the investment: 32,727 + 128,926 + 117,205 + 106,550 + 96,864 = 482,272; 482,272 − 300,000 = $182,272.
  4. Payback: $108,000 is unrecovered after year 2 and year 3 brings $156,000, so 108,000 ÷ 156,000 = 0.69. Payback = 2.7 years, about 2 years and 8 months.
  5. Discounted payback: $21,142 is unrecovered after year 3 and year 4 brings $106,550, so 21,142 ÷ 106,550 = 0.20. Discounted payback = 3.2 years.
  6. IRR: the rate that makes NPV zero, from a spreadsheet's IRR function or by trial: 28.2%, against a 10% hurdle.

The Excel trap that shrinks your NPV

Excel's NPV function treats every value as falling at the end of a period; Microsoft's documentation says a cash flow at the start of the first period must be added to the result, not included in the range (Microsoft Support, NPV function). "=NPV(10%, year 1 to year 5) + year 0" returns $182,272. Putting year 0 inside the range discounts everything one extra year and returns 182,272 ÷ 1.1 = $165,702, an error of $16,570 a careful reviewer will spot.

TrapWhat goes wrongFix
Year 0 inside NPV()Everything is discounted one extra yearAdd year 0 outside the function
Real and nominal mixedInflated cash flows with a real rate, or flat flows with an inflated rate, bias the answerNominal flows with a nominal rate, or real with real, and say which
Your own discount rateA rate chosen by the proposer invites the first challengeUse finance's hurdle rate; public bodies use theirs (3.5% real under the Green Book)
Horizon too longBenefits counted after the software or contract would be replacedMatch the horizon to the asset or contract life

Harbourline holds salaries and the subscription at today's prices and discounts at a 10% nominal rate, which slightly understates the savings if wages rise faster than the subscription; the register says so.

Say each number in one plain sentence

MetricValueSentence for the slide
NPV$182,272"After repaying the $300,000 and earning the 10% we require, option C adds about $182,000 in today's money."
Payback2.7 years"The cash we spend comes back in about two years and eight months."
IRR28.2%"The investment earns about 28% a year, against a 10% hurdle."

Sensitivity: show what would change the decision

A sensitivity slide tests each uncertain assumption across a realistic range, shows how far the NPV moves, and names the switching value: the level at which the recommendation stops being the best choice. Approvers do not need certainty; they need to know which assumption the decision rests on.

Definition What is a switching value? A switching value is the value an assumption would have to reach for the recommended option to stop being the best choice: for example, the point at which its NPV falls to zero, or below the next-best option's NPV.

The Green Book asks, at a minimum, for sensitivity analysis and switching values on the preferred option, with two example questions: what would make it less attractive than another shortlisted option, and what would make its net present value negative (HM Treasury, The Green Book, 2026). Answer both on the slide.

AssumptionBaseTestedNPV of CStill beats B?
Roles released43 / 5−$17,903 / $382,446No / Yes
One-time cost$300,000+50% / −10%$32,272 / $212,272No / Yes
Go-liveMonth 66 months late$73,181No
Subscription$72,000+20% / −20%$127,685 / $236,859Yes / Yes
Discount rate10%12% / 8%$155,202 / $211,752Yes / Yes

Each row changes one input; B's NPV is $94,994 at 10%, $86,667 at 12% and $104,080 at 8%. One role is worth $200,174 of NPV ($60,000 a year, half in year 1, discounted); a six-month slip removes the year-1 saving, 120,000 × 0.9091 = $109,091. The switching values:

  • Roles released: NPV reaches zero at 3.09 roles (a full-rate saving of $185,366, 23% below plan), and C falls behind B at 3.56 roles; in touchless terms, about 42% and 46%.
  • One-time cost: NPV reaches zero at $482,272, 61% over budget; C falls behind B at $387,278, 29% over.
  • Running cost: NPV reaches zero if running costs rise by $48,083 a year, 57% above plan.

Give cost a realistic stress test, not a token +10%. In Flyvbjerg and Budzier's analysis of 1,471 IT projects, the average cost overrun was 27%, and one project in six overran by about 200% on average (Flyvbjerg and Budzier, 2011). At a 27% overrun ($381,000), option C's NPV is $101,272, only $6,278 ahead of B, which is why the ask pairs a fixed-price integration contract with a pilot gate.

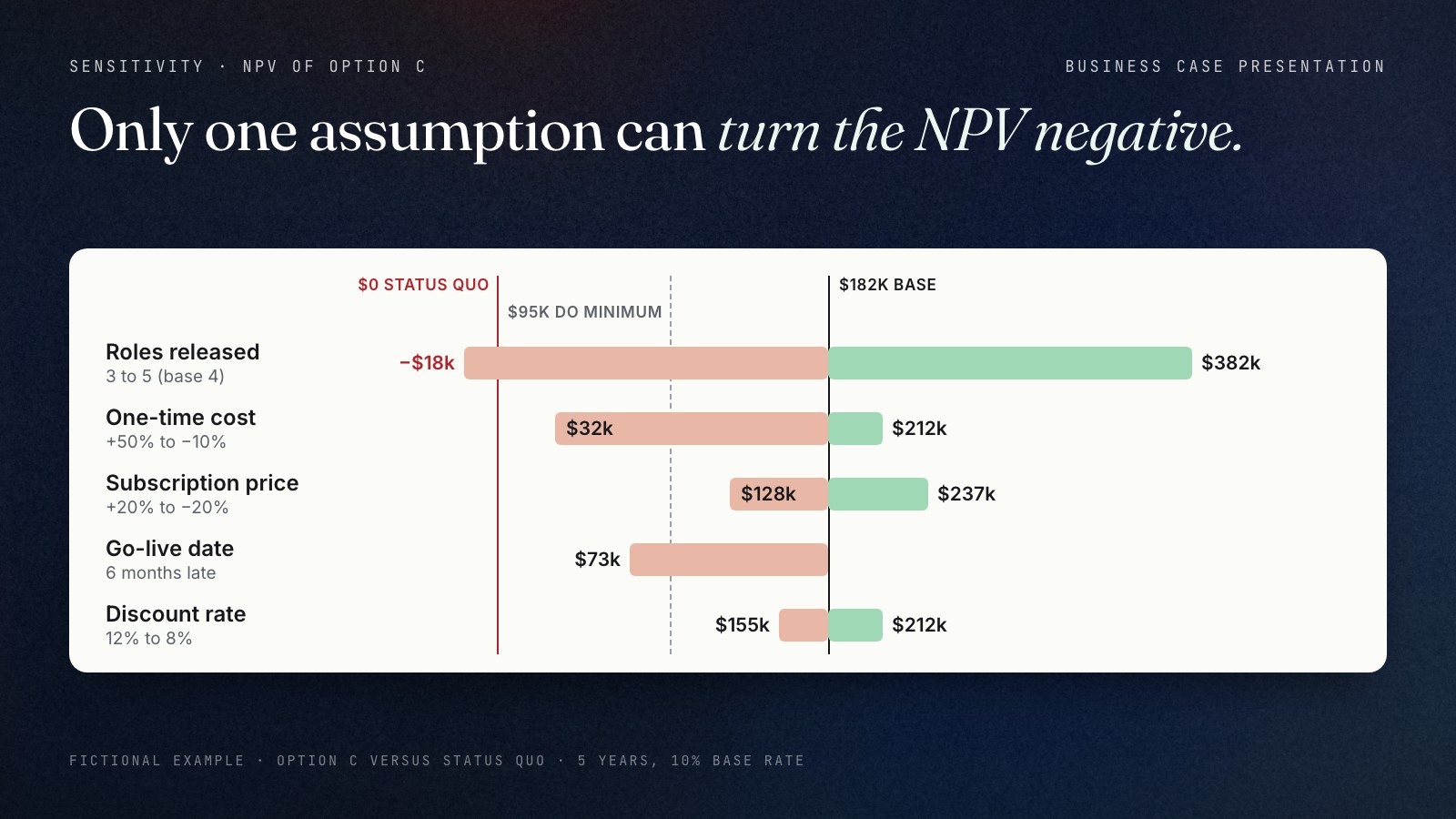

Tornado chart of option C's NPV in the fictional Harbourline case, base $182k, with reference lines at $0 (status quo) and $95k (do minimum). Roles released 3 to 5 moves NPV from minus $18k to $382k and is the only bar that crosses zero; one-time cost +50% to −10% gives $32k to $212k; subscription +20% to −20% gives $128k to $237k; go-live 6 months late gives $73k; discount rate 12% to 8% gives $155k to $212k.
Sort the bars by swing and draw the zero line and the next-best option: the reader sees at once which assumption can flip the decision.

Title the chart with the finding ("Only the number of roles released can turn the NPV negative") and put the switching values in one line beneath it. For ranges and scenario wording, see our guide to presenting forecasts and uncertainty.

Risks and mitigations: tie each risk to the numbers

The risk slide lists the four to six risks that could change the outcome, each with an early signal, a mitigation and an owner, linked to the sensitivity results. A risk that cannot move the numbers or the plan belongs in the appendix log.

RiskEarly signalMitigationOwner
Touchless rate below 50%Pilot match rate by week 8Second tranche only above 50%; otherwise stop and keep the tuned rulesAP lead
Roles not releasedNo signed HR plan at go-liveHR plan signed before tranche 2; monthly benefit report to the CFOCFO
Integration overrunChange requests above $20,000Fixed-price integration contract; contingency held by financeProject lead
Poor supplier dataInvoices without a purchase-order numberSupplier compliance campaign during the pilotProcurement lead
Weaker controlsAuto-approval tolerances wider than policyInternal audit signs off matching tolerances before go-liveFinancial controller

Say who holds the contingency. In Green Book terms it covers the optimism-bias allowance left after mitigation plus unprevented risk, so it shrinks as risks are designed out.

Implementation, governance and benefits tracking

The plan slide shows how the money is released, what is measured and when the decision is revisited. Stage gates, named benefit owners and dated reviews make an approval safe to give, because they limit how much is spent before the key assumption is proven.

WhenMilestoneGate or measure
Month 0Decision; tranche 1 of $120,000 releasedMinuted decision with conditions
Months 1–3Pilot with the 40 highest-volume suppliers; ERP integration; rule tuningWeekly touchless match rate
Month 3Pilot gateAt least 50% touchless on three months of invoices: CFO releases $180,000
Months 4–6Phased rollout; go-live at month 6Contractor roles end at go-live
Months 12, 18Benefits reviewsFour roles out of budget; 65% touchless; 4-day approval

Tranche 1 includes the rule tuning that is option B, so if the pilot misses the gate, Harbourline stops with B's benefits in hand, having spent $80,000 more up front than B plus three months of subscription: a known, bounded downside. Give each benefit an owner, baseline, target and review date; for sequencing several workstreams, see our roadmap presentation guide.

Worked example: the Harbourline deck in 12 titles

A strong business case deck makes its whole argument in its titles, and every number in them traces back to the model. Here is the finished Harbourline storyline.

Example Harbourline Supplies, its figures, staff plans and decisions are fictional. Amounts are pre-tax US dollars over five years at a 10% discount rate, measured against the status quo.
#SlideAction title
1The askApprove $300,000 to automate invoice matching: NPV $182,000, payback 2.7 years, released in two tranches
2ProblemManual matching costs $600,000 a year and takes 12 days per invoice
3ObjectivesSuccess by month 12 means four roles released, 65% touchless matching and 4-day approval
4OptionsWe compared three options with the status quo, from rule tuning to a full AP suite
5ComparisonAutomated matching beats the cheaper fix by $87,000 of NPV and the full suite by $200,000
6RecommendationSoftware matches the 65% of invoices that agree; a smaller team handles exceptions
7AssumptionsOnly cash counts: four released roles are in the model, 1.8 roles of redeployed time are not
8FinancialsAt a 10% hurdle rate, option C returns $182,000 NPV and 28% IRR; cash out peaks at $300,000
9SensitivityOnly one assumption turns NPV negative: releasing fewer than 3.1 roles
10RisksThe match rate, role release and integration cost each have a gate or an owner
11PlanPilot in months 1–3, go-live by month 6, benefits reviewed at months 12 and 18
12DecisionDecide today: $120,000 now, $180,000 if the pilot reaches 50% touchless matching

Slide 5's $200,000 is C's NPV minus D's: 182,272 − (−17,571) = 199,843. The appendix holds the model, the register, the sensitivity workings and the risk log.

To see the method as finished slides, we generated the Harbourline example as a deck in NOXI from these titles and their numbers and exported it to PDF without edits. Two of its slides:

Slide titled 'Approve $300,000 for automated matching with a gated second tranche': the approval request for option C split into a $120,000 tranche now and a $180,000 tranche released only if the pilot reaches 50% touchless matching, with the $84,000 annual running cost, NPV of $182,272 at a 10% hurdle rate, payback of 2.7 years, IRR of 28.2%, the accountable owner and the decision date.
The ask on one slide: amount, tranches, condition, owner and date. Generated in NOXI from this guide's worked example; the company and figures are fictional.
Slide titled 'Option C leads on NPV, while option B leads on payback and IRR': a table of four options against the status quo with year 0, year 1 and years 2 to 5 cash flows, NPV, payback and IRR (A $0, B $94,994, C $182,272, D minus $17,571), plus the B-to-C incremental value of $87,278 and the decision rule to choose on NPV.
Every option priced against the status quo on one yardstick, with the decision rule written on the slide. Same NOXI deck, fictional example.

The finance reviewer's questions: a pre-meeting checklist

Before a business case reaches the committee, a finance business partner will usually test it with questions like these. Answer them in the deck or appendix and the meeting can spend its time on the decision, not the arithmetic.

  1. What exactly are we approving, and what if we say no?Option, amount, phasing, conditions, owner and date; the status quo is priced.
  2. Are the benefits incremental to the status quo?Nothing in the NPV would have happened anyway.
  3. Which benefits release cash, from which budget line, and when?Hours become roles, and roles a named HR plan.
  4. Are all costs in, and sunk costs out?One-time, running, internal time, training, exit and contingency; past spending excluded.
  5. Who set the discount rate and horizon, and is year 0 right?Finance's rate; horizon matches the asset life; year 0 outside Excel's NPV.
  6. Why not the do-minimum, and what would change the decision?Incremental NPV, sensitivity ranges and switching values.
  7. How was the contingency sized?Evidence from comparable projects, not a habitual 10%.
  8. What does it do to this year's budget and cash?Peak cash out; capital and operating split and tax treatment per finance policy.
  9. Who owns each benefit, and when do we check?Owner, baseline, target, measure, review date.
  10. How much is spent before the key assumption is proven?Stage gates and stop criteria.

Presenting the business case in the room

Send the deck and model as a pre-read, present for no more than half the slot, and spend the rest on questions and the decision. Answer challenges with the switching value: "that changes the answer only if fewer than 3.1 roles are released" persuades more than defending the base case.

MinutesSlidesPurpose
0–21State the ask and the headline numbers
2–42–3Agree the problem and what success means
4–74–6Show the options and why the recommended one wins
7–127–9Walk the assumptions, financials and sensitivity
12–1510–11Cover the risks and the plan
15–3012Questions, then the decision in words, slide 12 on screen

For approvers outside finance, explain mechanisms as cause and effect (see explaining a technical project to executives); at board level the case becomes one agenda item with a resolution (see our board meeting presentation guide). Minute the decision exactly as slide 12 states it, conditions included.

3 AI prompts for the business case deck

Use them in NOXI after attaching your approved model and assumptions register, or in any AI tool that has them. Replace the brackets.

Prompt 1 · Draft the deck from the approved model

Create a [12]-slide business case presentation from the attached [financial model] and [assumptions register and memo]. Follow this order: ask, problem, objectives, options, comparison, recommendation, assumptions, financials, sensitivity, risks, plan, decision. Write every title as a full-sentence finding. Use the model's figures exactly: [NPV, payback, IRR, discount rate, horizon]. Count only cash-releasing benefits on the financial slides and show redeployed time separately. Invent no figures; mark missing information for review.

Prompt 2 · Options and sensitivity slides

Rebuild slides [5] and [9]. Slide 5: one table comparing [A status quo, B do minimum, C recommended, D more ambitious] with year-0 cost, yearly net cash flow, NPV at [10%], payback and IRR; highlight C and state in the title why it wins. Slide 9: a horizontal bar chart of C's NPV for each tested assumption [assumption, low and high values, NPV at each], sorted by swing, marking $0 and B's NPV [$94,994]. Title it with the assumption that can turn NPV negative; put its switching value beneath.

Prompt 3 · Pre-read version on a copy

On a copy of this deck, write a [four]-slide pre-read for [the CFO and the investment committee]: the ask with its conditions, options and financial summary, sensitivity with switching values, and risks and plan. Keep every number, range and label unchanged. Add the assumptions register [IDs A1–A7] as an appendix slide and state the decision needed by [date].

How to build the business case deck in NOXI

NOXI drafts the deck from your approved model in the style of your own template. It is free, with no card and no watermark; uploading files needs a free account, and a full deck uses about 25 of the 1,000 monthly credits.

Step 1: Prepare the inputs

Save the approved model as an Excel or CSV file and the assumptions register and memo as a Word document or PDF, including only material your organization permits for this use. NOXI accepts PDF, Word, PowerPoint, Excel, CSV, text and image files up to 200 MB each.

Step 2: Match your template

Choose Match reference and attach your company PowerPoint template, a previously approved business case as PPTX or PDF, or a screenshot of one slide. NOXI builds the new deck in that style: colours, typography, layouts and visual rhythm.

Step 3: Review the outline first

Attach the files with Prompt 1 and choose Plan mode to review the outline before generation. Check that the twelve titles state findings and carry the ask, the NPV and the switching value, then generate and watch each slide being built.

Step 4: Refine the number slides

Use Prompt 2 for the options and sensitivity slides, or ask for changes in plain English or Arabic. Click any element and tell the AI what to change; on desktop, sketch on the slide and the AI follows your drawing. Text, tables and chart numbers stay editable, across twelve chart types including waterfall and horizontal bar.

Step 5: Review with finance

Invite your finance business partner by email as an editor to check the deck with you in real time, or share a view-only link with reviewers. Version history restores an earlier version or makes a copy, which becomes the pre-read with Prompt 3.

Step 6: Export and present

Download an editable PowerPoint (.pptx) with real text boxes and embedded fonts, and a PDF for the pre-read, free and with no watermark. Present full-screen from NOXI in the meeting. For a regional committee, Translate a deck creates a separate Arabic or English version.

Frequently asked questions

What should a business case presentation include?
It should include the decision you are asking for, the cost of the status quo, the options considered (including the status quo and a do-minimum), costs and benefits with stated assumptions, NPV, payback and IRR, a sensitivity analysis showing what would change the decision, risks with mitigations, a delivery plan with benefit owners, and the exact ask. Twelve slides plus an appendix with the model and assumptions register cover most investment decisions.
How many slides should a business case presentation have?
Ten to twelve main slides suit a 30-minute decision slot, with the financial model, the full assumptions register and the risk log in an appendix. For a short steering-committee item, six slides work: the ask, the problem, the options, the numbers with sensitivity, risks and plan, and the decision. Count slides by the questions the approver must settle, not by the amount of analysis you did.
How do you present NPV and payback to non-finance executives?
Give each number one plain sentence. NPV: "after repaying the investment and earning the 10% we require, the project adds about $182,000 in today's money." Payback: "the cash comes back in about two years and eight months." State the discount rate and horizon on the slide, keep the cash-flow table in the appendix, and show which assumption would turn the NPV negative.
Why include a do-nothing option in a business case?
Because every cost and benefit is measured against what happens without the proposal. HM Treasury guidance requires business as usual on every shortlist as the benchmark, and notes that it is rarely "do nothing": the current process keeps costing money and carrying risk. Leaving it out lets a deck compare its proposal with zero. Add a do-minimum option too, because the cheap fix is often the real competitor.
What is the Five Case Model?
It is HM Treasury's standard framework for business cases. A proposal is examined from five linked perspectives: strategic (the case for change), economic (best value for money across a shortlist of options), commercial (a viable deal with suppliers), financial (affordability and funding) and management (arrangements for successful delivery). It is mandatory for significant spending in the UK and Welsh governments and widely used beyond them.
Can AI help build a business case presentation?
Yes, for structuring and drafting slides from an approved model and assumptions register, not for producing the numbers. Give the tool the finished model, tell it to keep every figure, label and range unchanged and to invent no benefits, then check each number against the model, confirm that non-cash benefits have not crept into the NPV, and review the exported file before it circulates.

Sources & methodology

How this guide was made: it applies HM Treasury's business case and appraisal guidance and standard capital-budgeting practice to presentation work; the twelve-slide structure, meeting timings and checklists are editorial recommendations, not a standard. Harbourline Supplies and all its figures are fictional; every calculation was checked in a spreadsheet model. All sources were checked on 9 October 2026.

Build your next business case deck in NOXI, free: attach the approved model and assumptions register, match your company template, review the outline in Plan mode, and export an editable PowerPoint or PDF for the pre-read.
