Disclosure: NOXI publishes this guide and is one of the tools it mentions; the method works in any presentation software.
Quick answer: A change management presentation is two decks, not one. The sponsor deck wins approval in seven slides: case for change, what changes, who is affected, plan and timeline, risks and resistance, how you will measure, and the ask. The employee deck answers "what changes for me, and when" by slide three, then covers support and where to ask.
Most change management templates are one deck of models and arrows. They serve nobody, because the steering committee wants to know whether the change is worth the cost, and the people whose work changes want to know what happens to their Monday. This guide builds both decks from one set of facts: an impact table, a dated timeline and a readiness pulse mapped to Prosci's ADKAR® Model. A fictional insurer, Calder Mutual, runs through every step with the arithmetic shown.
In short
- Two decksA sponsor approval deck (7 slides, about 20 minutes) and an employee announcement (6 to 8 slides, about 15 minutes plus questions), built from the same facts.
- The ruleAnswer "what changes for me, and when" by slide three of the employee deck. People can't hear the why until they know the what.
- Impact tableEach group, what changes, degree 1 to 5, headcount and training hours. Calder Mutual: 420 people, 2,872 training hours.
- ADKAR slideAwareness, Desire, Knowledge, Ability, Reinforcement, each with a message, the slide that carries it and a measure. Fix the earliest gap first.
- Capacity mathA 20% dip for 20 working days at 6,120 claims a day is 24,480 claims; 68 temporary handlers at 15 a day clear it in 24 working days.
- The data pointProsci's 12th-edition benchmark (2023): 88% with excellent change management met or exceeded objectives, against 13% with poor. A correlation from self-rated data, not proof of cause.
What is a change management presentation?
A change management presentation explains an organisational change (a new system, a reorganisation, a new policy) to the people who must approve it or live with it. In practice it is a sponsor deck that asks for decisions and an employee deck that tells people what changes for them.
Project managers, HR business partners and change leads build it for a system go-live, a restructure or a policy change, often in November and December for a January start. MBA and HR students can use the worked example as their case, and consultants can use the sponsor deck as their proposal.
It is not the project's business case: that argues the change is worth funding, while the change deck asks for what it takes to make people adopt it. If you still need the investment decision, our business case presentation guide covers payback and options first.

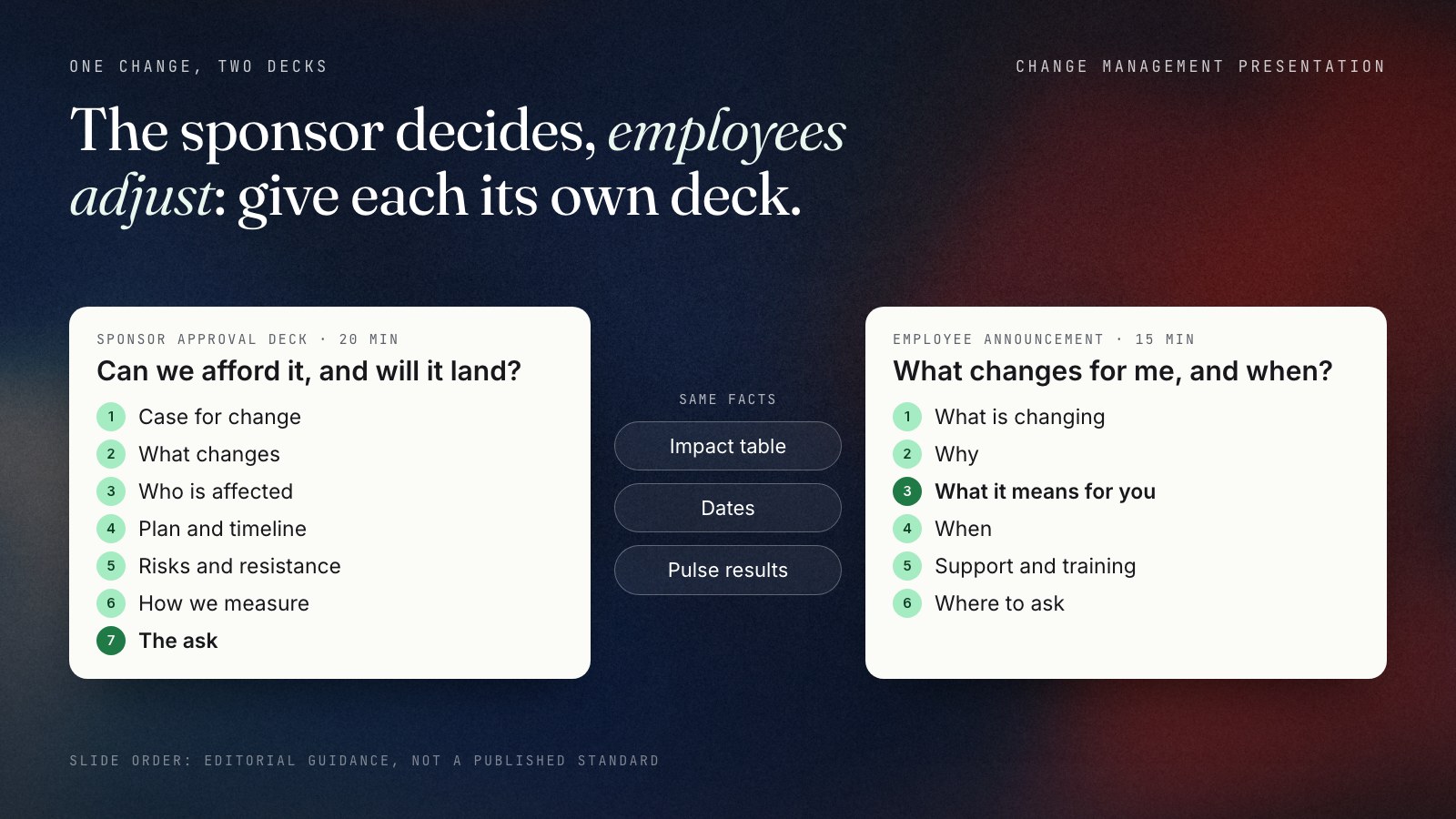

Two audiences, two decks: the sponsor deck and the employee announcement
One change needs two decks because the sponsor and the employees ask different questions. The sponsor asks "is this worth it, and will it land?"; employees ask "what changes for me, and when?". A single deck answers neither well: it buries the ask under reassurance, or buries the personal news under budget lines.
| Deck | Audience and setting | The question it answers | Length |
|---|---|---|---|
| Sponsor approval deck | Executive sponsor and steering committee, before any announcement | Is the change worth the cost, will people adopt it, and what do you need from us? | 7 slides plus appendix, about 20 minutes |
| Employee announcement | Everyone affected, at an all-hands or town hall, after approval | What changes for me, why, when, and how will I be supported? | 6 to 8 slides, about 15 minutes plus 15 of questions |
| Manager toolkit | Each team lead with their own team, within 72 hours of the announcement | What does it mean for our team, and what are my dates? | 3 slides, about 10 minutes in a team meeting |
The three decks share one fact base: the impact table, the dated timeline and the pulse results. Build it first, in a spreadsheet, so every deck quotes the same numbers.

The sponsor deck, slide by slide
The sponsor deck has seven slides: the case for change, what changes, who is affected, the plan and timeline, risks and resistance, how you will measure adoption, and the ask. Write each title as a finding, so a sponsor who reads only the titles still knows what you need.
| # | Slide | What goes on it | Calder Mutual title (fictional) |
|---|---|---|---|
| 1 | Case for change | One number for the cost of the current state and one consequence of doing nothing | Re-keying costs $3.44 million a year, and the old platform loses support in December 2027 |
| 2 | What changes | The change in one sentence per group, with the go-live date | From 1 March 2027, every claim runs in one system |
| 3 | Who is affected | The impact table: groups, degree, headcount, training hours | 420 people change how they work; 340 claims handlers change the most |
| 4 | Plan and timeline | Announce, train, go live, stabilise, reinforce, with dates and owners | Announce 12 January, train in February, go live 1 March |
| 5 | Risks and resistance | Readiness pulse, top concerns, the capacity dip and the cover for it | Desire is the gap: 61% support the change, and handlers fear targets during go-live |
| 6 | How we measure | ADKAR measures with targets and dates | Five measures tell us by day 30 whether the change is landing |
| 7 | The ask | Every decision you need, each with an amount or a date | Approve $830,473 and pause individual targets for 20 working days |
The case for change: one number, one consequence
The case for change slide needs one cost of the current state, calculated in front of the reader, and one dated consequence of doing nothing. Calder Mutual's handlers re-key each claim into three systems, about 3 minutes a claim. At 6,120 claims a day that is 6,120 × 3 = 18,360 minutes, or 306 hours a day; over 250 working days, 306 × 250 = 76,500 hours, and at a loaded cost of $45 an hour, 76,500 × 45 = $3,442,500 a year. The consequence: the vendor ends support for the old claims platform on 31 December 2027. Keep the software's own business case out of this deck: it was approved earlier, and reopening it buries the change budget in the licence discussion.
The ask: decisions with amounts and dates
The last slide lists every decision you need, each with an amount, a date or a name, so the sponsor can say yes line by line. "Your support" is not an ask. Calder Mutual's four asks are: approve a change budget of $830,473; pause individual claims-per-day targets for working days 1 to 20 after go-live; have the chief executive present the employee announcement on 12 January 2027; and approve making the old system read-only on 12 April 2027. Each traces back to a number earlier in the deck. For the closing slide and the handover to questions, see how to end a presentation; if the committee is far from the operational detail, our guide to explaining a technical project to executives translates system terms into business effects.
The employee announcement: what changes for me, by slide three
The employee announcement deck follows six beats: what is changing, why, what it means for you, when, how you will be supported, and where to ask. "What it means for you" must arrive by slide three, because people can't hear the why until they know the what.
That rule is our guidance from practice, not a published standard. An announcement triggers one private question in every listener: does this affect my job, my targets, my team? Until a slide answers it, people listen for clues rather than reasons, and a long case for change sounds like a warm-up for bad news.
| # | Slide | Say | Leave for the FAQ page |
|---|---|---|---|
| 1 | What is changing | One sentence and the go-live date | The vendor selection history |
| 2 | Why | One or two reasons in plain words, with one number | The full business case |
| 3 | What it means for you | By role: what changes, training hours, what stays the same, honest costs | Screen-by-screen detail |
| 4 | When | Four or five dates on one line | The project plan |
| 5 | Support and training | Training slots, practice environment, floor support, help line | Course outlines |
| 6 | Where to ask | A named channel, a weekly Q&A time, the manager's role | The full question log |
Two optional slides earn their place: "what you told us", showing the pulse and what you changed because of it, and how performance will be judged during the transition, the question nobody asks out loud. Calder Mutual uses both, for eight slides.
Say the honest cost early, on slide three or four. A new system means slower work for a few weeks, and people know it. "Handling will be slower for about four weeks; individual targets are paused for the first 20 working days" is believed; "a seamless transition" is not. For the run of show and handling hard questions live, our all-hands meeting presentation guide covers the meeting around the deck.

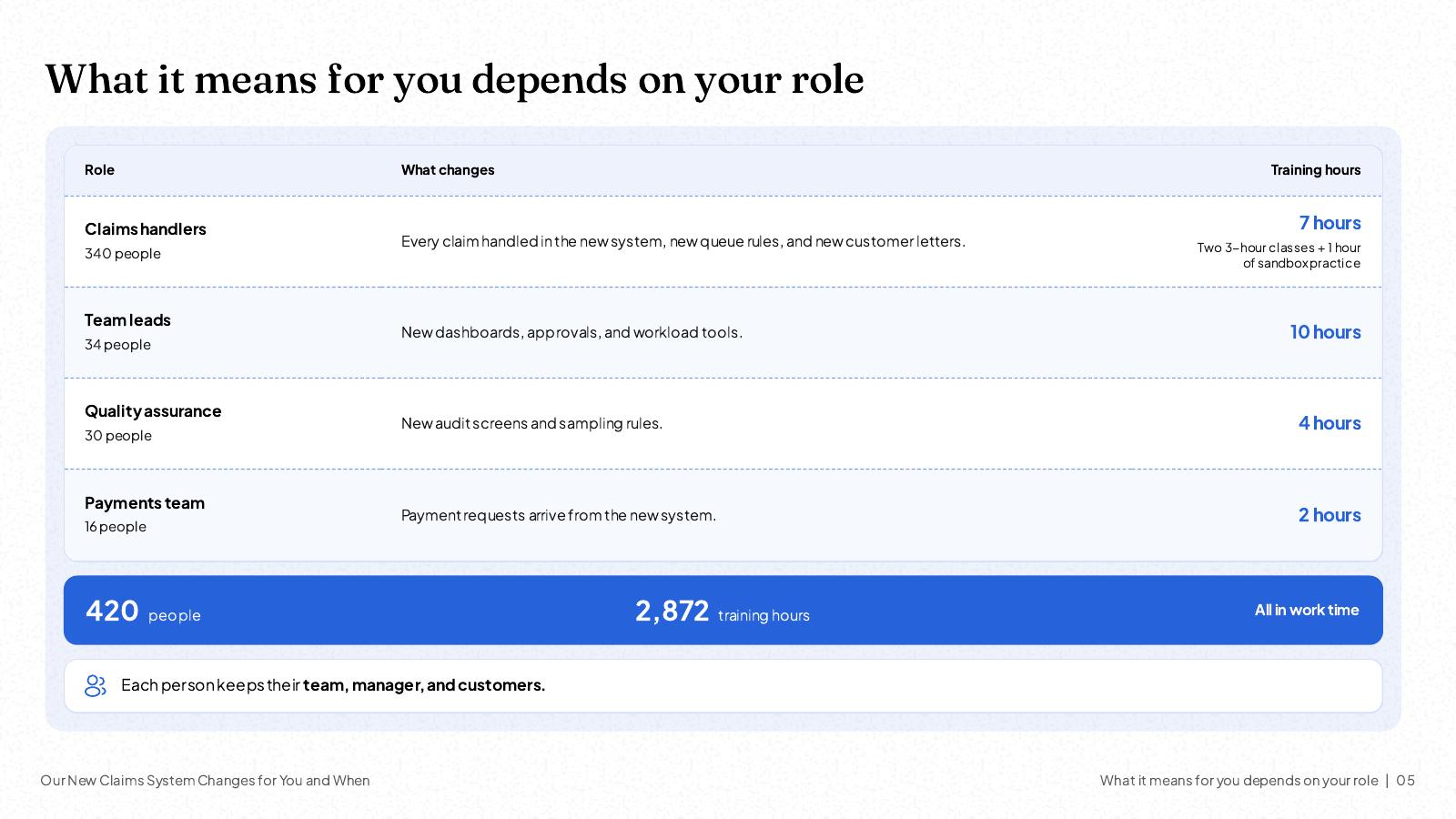

The change impact table: who changes, how much, and the hours it takes
A change impact table lists each affected group with what changes for it, the degree of change on a 1 to 5 scale, the headcount and the training hours. It is the one table both decks share: the sponsor sees the totals, each employee finds their own row.
Score the degree with a written rule so two people score the same group the same way: 5 = how every task is done changes; 4 = most daily tasks change; 3 = some tasks or tools change; 2 = an input or output changes but the job does not; 1 = awareness only. Then add headcount and training hours, and let the arithmetic do the rest.
| Group | What changes | Degree | People × hours each | Training hours |
|---|---|---|---|---|
| Claims handlers | Every claim handled in the new system; new queue rules; new customer letters | 5 | 340 × 7 | 2,380 |
| Team leads | New dashboards, approvals and workload tools | 4 | 34 × 10 | 340 |
| Quality assurance | New audit screens and sampling rules | 3 | 30 × 4 | 120 |
| Payments team | Payment requests arrive from the new system | 2 | 16 × 2 | 32 |
| Total | Four groups | 340 + 34 + 30 + 16 = 420 people | 2,380 + 340 + 120 + 32 = 2,872 |
The handlers' 7 hours are two 3-hour classes plus 1 hour of sandbox practice. At a loaded cost of $45 an hour, training time is 2,872 × 45 = $129,240 for the sponsor's budget; the per-role hours go on slide three of the employee deck.
Read the table for priorities: the handlers are 340 of 420 people (81%) and score 5, so they get the most training and floor support. A degree-2 group like payments needs a clear email and a named contact, not a workshop.
The change timeline: announce, train, go live, stabilise, reinforce
A change timeline has five phases (announce, train, go live, stabilise, reinforce), each with dates, an owner and the deck or message that marks it. Put it on one slide in the sponsor deck and as four or five dates on one line in the employee deck.
| Date | Milestone | Owner | Deck or message |
|---|---|---|---|
| 16 Nov 2026 | Chief executive's town hall: decision to replace the claims systems, and why | Chief executive | Short case for change |
| 30 Nov–4 Dec 2026 | Readiness pulse (ADKAR questions) | Change lead | Survey, 5 working days |
| 15 Dec 2026 | Steering committee approves the change plan | Executive sponsor | Sponsor approval deck |
| 12 Jan 2027 | Employee announcement at the claims all-hands | Chief executive and claims director | Employee announcement deck |
| 13–15 Jan 2027 | Team briefings | 34 team leads | Manager toolkit (3 slides) |
| 1–26 Feb 2027 | Sandbox opens; training for all 420 people over 20 working days | Training lead | Training plan and job aids |
| 24–25 Feb 2027 | Training for 68 temporary handlers | Training lead | Same course |
| 1 Mar 2027 | Go-live; floor champions on every floor; targets paused for 20 working days | Claims director | Go-live note |
| 31 Mar, 30 Apr, 28 May 2027 | Reviews at 30, 60 and 90 days; old system read-only from 12 April | Executive sponsor | 30/60/90-day review deck |
Two dates carry most of the risk. The sponsor deck must land before the announcement, because the announcement makes promises (paused targets, training hours) that need approval first. And training must end before go-live: Calder Mutual's last class is on Friday 26 February, before the Monday go-live. Put these milestones in your weekly status deck so slippage shows early; our project status report guide has the RAG rules, and the project kickoff guide covers the programme's first meeting.
Choosing a change model: Prosci's ADKAR or Kotter's 8 steps
Use Prosci's ADKAR® Model when the deck must show whether individuals are ready, and Kotter's 8 steps when it must show what leaders will do. ADKAR describes the change each person goes through; Kotter's steps describe the sequence of actions that leaders take to lead the change.
Prosci's ADKAR Model. Prosci describes ADKAR as a model for understanding and supporting individual change, with five elements (defined below). It says the elements are sequential but not linear, and advises focusing support on the earliest element a person has not yet reached (Prosci, The Prosci ADKAR® Model). The model was developed by Jeff Hiatt (Prosci, The ADKAR Model: A Structured Approach). ADKAR is Prosci's registered mark, so name it as Prosci's model on your slides.
Kotter's 8 steps. Kotter Inc. lists eight steps for leading change: create a sense of urgency, build a guiding coalition, form a strategic vision, enlist a volunteer army, enable action by removing barriers, generate short-term wins, sustain acceleration, and institute change. The firm says the steps grew out of the linear process in John Kotter's book Leading Change and were later developed into "8 Accelerators" in Accelerate (2014) (Kotter Inc., The 8-Step Process for Leading Change).
The two models are not rivals: Kotter's steps organise the leaders' plan (the sponsor deck), ADKAR the employees' journey and measures (the employee deck and the pulse). The table shows where each Kotter step appears.
| Kotter step | Where it shows up | Calder Mutual (fictional) |
|---|---|---|
| 1. Create a sense of urgency | Sponsor slide 1; employee slide 2 | $3.44 million a year of re-keying; old platform unsupported after December 2027 |
| 2. Build a guiding coalition | Sponsor slide 4 (owners) | Sponsor, claims director, change lead, training lead, 17 floor champions |
| 3. Form a strategic vision | Employee slide 1 | One system for every claim, with status visible to customers online |
| 4. Enlist a volunteer army | Employee slide 5 | 17 handlers volunteer as floor champions |
| 5. Enable action by removing barriers | Sponsor slide 7 (the ask) | Targets paused for 20 working days; temporary cover for the dip |
| 6. Generate short-term wins | Day-30 review deck | First teams back to 18 claims a day; backlog on course to clear on working day 24 (1 April) |
| 7. Sustain acceleration | Day-60 review deck | Second wave: customer self-service claim status |
| 8. Institute change | Day-90 review deck | Old system read-only from 12 April; new procedures in the handbook |
For a course assignment that asks you to "apply a change model", this table is a ready structure: one row per step, your case's evidence in the last column.
The ADKAR slide: one message, one slide and one measure for each stage
The ADKAR slide turns the model into a plan: for each of the five stages it names what a person should be able to say, the slide or support that carries the message, the measure and the target. The stage names and their order are Prosci's; the messages, slides and measures below are our method.
| Stage | The person can say | Slide or support that carries it | Measure and target |
|---|---|---|---|
| Awareness | "I know why we're changing." | Case for change (employee slide 2) | Pulse: % agree "I understand why we are changing"; 80% before training |
| Desire | "I want this to work." | What it means for you, with the honest costs (slide 3); how performance is judged | Pulse: % agree "I want this change to work"; 80% before training |
| Knowledge | "I know how." | Training plan, sandbox, job aids | Training completion 100%; end-of-course check passed by 90% |
| Ability | "I can do it on a real claim." | Floor champions, help line, paused targets | Claims per handler a day back to 18 by working day 20; first-pass error rate |
| Reinforcement | "It sticks." | 30/60/90-day reviews, recognition | Logins to the old system: zero after 12 April; second pulse |
The 80% targets are our choice, not a Prosci threshold; set yours before the pulse runs. Ask each question on a 5-point agreement scale and report the share who agree or strongly agree, with the number of responses.
Reading the pulse: fix the earliest gap first

Calder Mutual's readiness pulse ran from 30 November to 4 December 2026, after the chief executive's town hall and before the sponsor meeting. 336 of 420 people answered: 336 ÷ 420 = 80.0%.
| Stage | Agree | Share | Against the 80% target |
|---|---|---|---|
| Awareness | 282 of 336 | 282 ÷ 336 = 83.9%, shown as 84% | Met |
| Desire | 205 of 336 | 205 ÷ 336 = 61.0% | Gap of 19 points: the earliest gap |
| Knowledge | 158 of 336 | 158 ÷ 336 = 47.0% | Expected: training has not started |
Knowledge is the lowest number, but it is not the problem yet: nobody has been trained. Desire is the earliest stage below target, so it is where support goes first, which matches Prosci's advice to focus on the earliest unmet element. The split by group shows where: 150 of 272 handlers who answered agree (55.1%), against 26 of 30 team leads (86.7%), 18 of 22 in quality assurance (81.8%) and 11 of 12 in payments (91.7%). The four groups add up: 272 + 30 + 22 + 12 = 336 responses and 150 + 26 + 18 + 11 = 205 who agree.
The comments say why. Of the 181 handlers who wrote a comment, 96 (53.0%) mentioned being measured on claims per day while learning the new system. That fear is fixable, and it became the sponsor deck's second ask: pause individual targets for 20 working days. The pulse and the impact table point at the same group, the 340 handlers.

One caution: the 84 people who did not answer may feel differently from the 336 who did. Show the response rate and repeat the same questions later, so the trend counts more than any single reading.
Resistance to change: name it, plan for it, measure it
A resistance slide names the two or three concerns you actually heard, says what you will do about each, and says how you will know it worked. Present resistance as evidence about the plan, not as an attitude problem.
| Concern heard | Usually signals | Response on the slides | Measure |
|---|---|---|---|
| "I'll miss my targets" | Fear of being judged during the dip (Desire) | Pause individual targets for a fixed period; say the date they return | Desire score in the second pulse |
| "The old system works fine" | The reason isn't personal yet (Awareness) | One concrete pain the person feels today, such as re-keying | Awareness score; questions at the Q&A |
| "I won't have time to learn it" | Workload during training (Knowledge) | Training in work time, with cover and named slots | Attendance per session; overtime used |
| "Nobody asked us" | Lost trust in the process | A "what you told us" slide; floor champions from the teams | Comment themes in the second pulse |
| "Is my job safe?" | Fear of a hidden headcount cut | Say clearly what the change does and does not mean for roles, only what is decided | Questions on the anonymous channel |
The last row needs care. If roles are changing, say so plainly and through the proper process; a deck that promises "no impact on jobs" and is later proved wrong poisons every change after it. If nothing is decided, say what is known and when people will hear more.
Capacity math for a system change: the dip, the training draw and the cover
A system change costs output twice: once while people are in training and again while they are slow on the new system. The sponsor deck should show both draws in units of work, the cover planned for each, and the day the backlog clears.

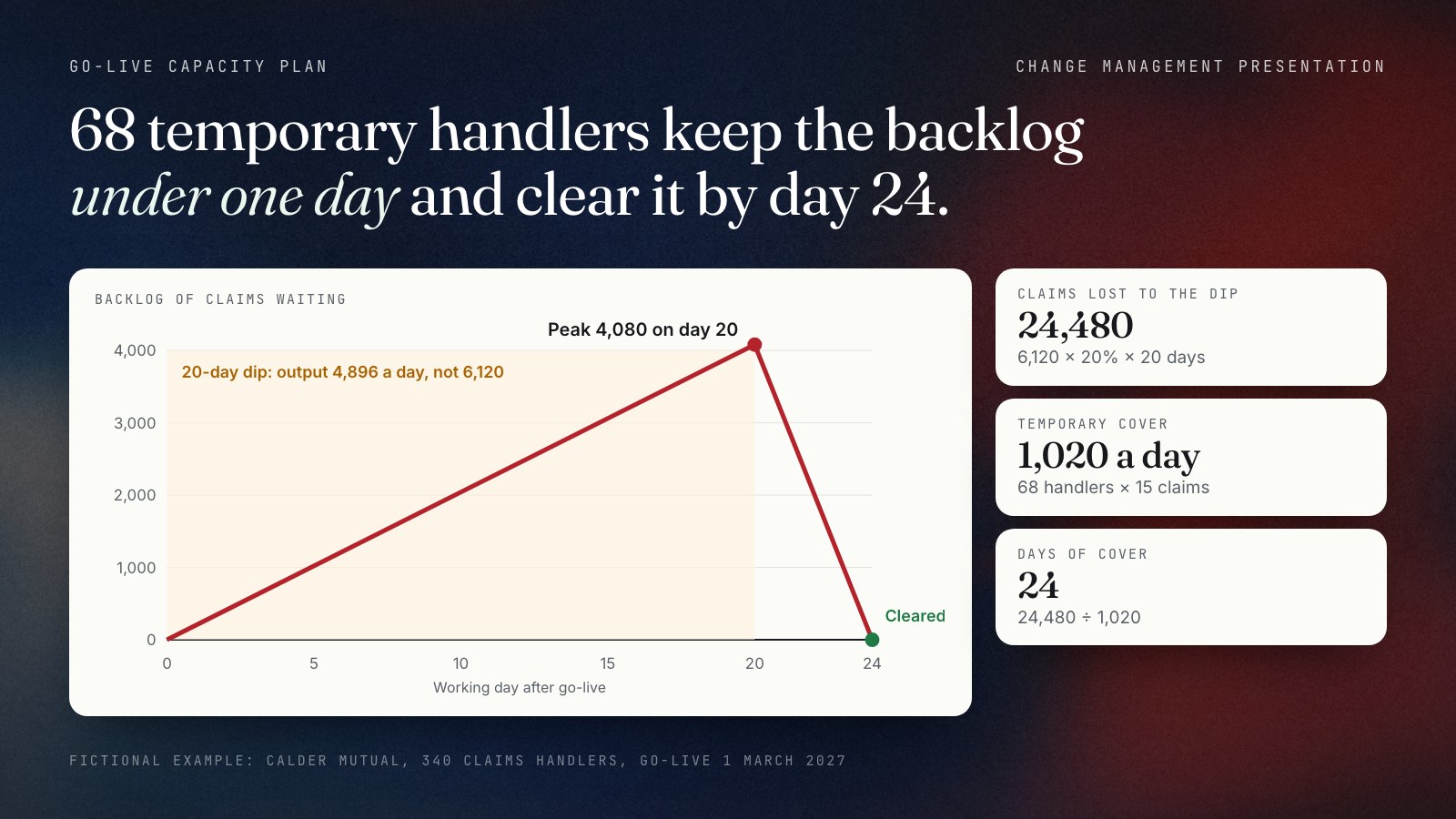

Draw 1: the go-live dip
| Figure | Arithmetic | Result |
|---|---|---|
| Normal output | 340 handlers × 18 claims | 6,120 claims a day |
| Output during the dip | 6,120 × (1 − 0.20) | 4,896 claims a day |
| Claims lost to the dip | 6,120 × 0.20 = 1,224 a day × 20 working days | 24,480 claims |
| Temporary cover | 68 temporary handlers × 15 claims a day | 1,020 claims a day |
| Days of cover needed | 24,480 ÷ 1,020 | 24 working days |
| Peak backlog | (1,224 − 1,020) × 20 | 4,080 claims on working day 20 |
| Backlog cleared | 4,080 ÷ 1,020 after the dip ends | 4 more days: working day 24 |
Temporary handlers close 15 claims a day, not 18, because they are new to Calder Mutual. The backlog grows by 204 a day and peaks at 4,080, which is 4,080 ÷ 6,120 = 67% of one normal day's output: customers wait at most about two-thirds of a day longer, and the queue is normal again by working day 24.

Draw 2: the training itself
Training is also lost output, and most plans forget it: 340 handlers × 7 hours = 2,380 hours off the queue in February. At 18 claims per 7.5 hours, a handler closes 2.4 claims an hour, so training costs 2,380 × 2.4 = 5,712 claims across 20 working days, about 286 a day. Calder Mutual covers it with paid overtime at time and a half: 2,380 hours × $67.50 = $160,650.
The change budget on one slide
| Line | Arithmetic | Cost |
|---|---|---|
| Staff training time | 2,872 hours × $45 | $129,240 |
| Overtime to cover handler training | 2,380 hours × $67.50 | $160,650 |
| Temporary handlers | 68 × 24 days × 7.5 hours × $38 | $465,120 |
| Training for temporary handlers | 68 × 7 hours × $38 | $18,088 |
| Floor champions | 17 handlers × 20 days × 3.75 hours (half their day) × $45 | $57,375 |
| Total change budget | 129,240 + 160,650 + 465,120 + 18,088 + 57,375 | $830,473 |
Set against the $3,442,500 a year of re-keying, the change budget is 830,473 ÷ 3,442,500 = 24% of one year's waste. That ratio belongs on the ask slide. It is not the project's payback (the software has its own business case); it is the price of making sure the software is used.
Worked example: Calder Mutual's employee announcement, slide by slide
Calder Mutual's employee announcement runs eight slides in 15 minutes, presented by the chief executive and the claims director on 12 January 2027, with "what it means for you" on slide three.
- From 1 March 2027, every claim runs in one new claims system (1:00): one sentence, the date, the four groups affected.
- One system instead of three ends re-keying, and customers see their claim status online (1:30): about 3 minutes saved on every claim.
- What it means for you depends on your role (3:00): training of 7 hours for handlers, 10 for team leads, 4 for quality assurance, 2 for payments; your team, manager and customers stay the same.
- Your individual targets are paused for the first 20 working days (1:30): handling will be slower for about four weeks; 68 temporary handlers cover the queue.
- Four dates to know (1:30): sandbox opens 1 February; training 1 to 26 February; go-live 1 March; 30-day review 31 March.
- You won't be on your own on day one (2:00): 17 floor champions, one for every two teams; help desk extension 5200; job aids at every desk.

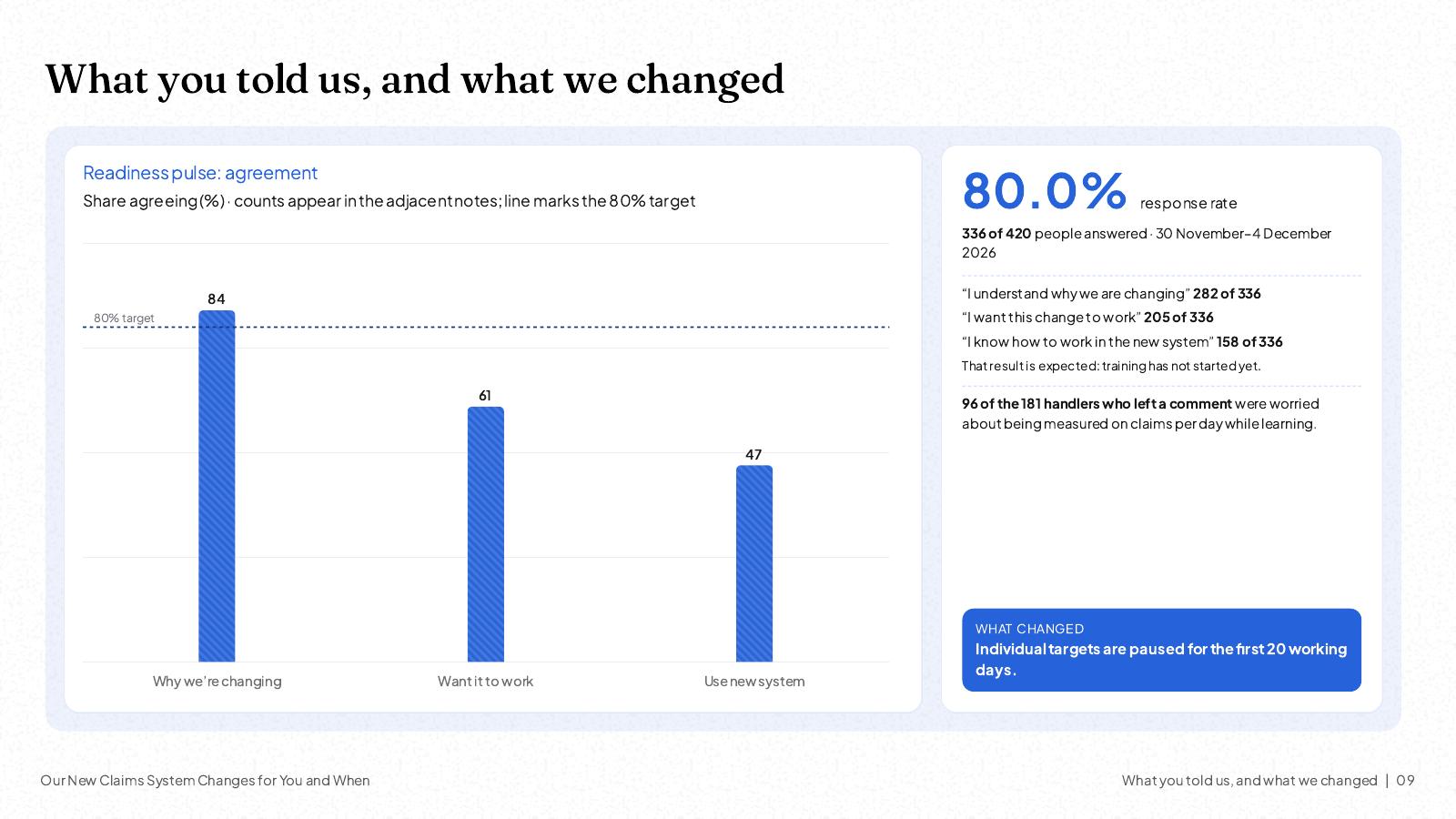

- What you told us, and what we changed (1:30): 336 of 420 answered; 84% understand why, 61% want the change to work, 47% know how so far; targets paused because of your comments.
- Where to ask (3:00): Q&A every Thursday at 15:00 in February; the intranet change page; your team lead. Then questions.
The times add up: 1 + 1.5 + 3 + 1.5 + 1.5 + 2 + 1.5 + 3 = 15 minutes. Slide three gets the most time because it holds the news each person came for; the vendor and the architecture go on the intranet change page.
Here are two slides from this article's worked example, as NOXI built them, unedited.

Manager toolkit: the three slides every team lead presents
After the announcement, each team lead presents three slides to their own team within three working days: what changes for our team, our dates, and what I need from you and where to ask. People hear the business reasons from senior leaders, but they take the personal meaning from their own manager.
Prosci's 12th-edition benchmark report found that front-line employees still prefer to hear about the business impact of a change from the chief executive, and that people managers remain the preferred senders of personal messages about it (Prosci, Best Practices in Change Management, 12th Edition Executive Summary). That is why the announcement is the chief executive's and the toolkit is the team lead's.
| Slide | What the team lead fills in | Example for a handler team |
|---|---|---|
| 1. What changes for our team | Your rows of the impact table, in your team's words | All 10 of us handle every claim in the new system; our customers and manager stay the same |
| 2. Our dates | Each person's two training slots, the go-live day, who our floor champion is | Classes on Tuesdays and Thursdays in weeks 2 and 3 of February; Amira is our champion |
| 3. What I need from you, and where to ask | One action, one channel, one date for the next check-in | Try the sandbox before your first class; next check-in 9 February |
Give team leads the slides pre-filled, leaving only their team's rows and names. Brief them the day before the announcement so they don't hear the news with their teams, and ask each for their team's top three questions.
After go-live: reinforcement measures and the 30/60/90-day review
Change management doesn't end at go-live. Plan three short reviews at 30, 60 and 90 days, each showing the same five measures against target and one decision for the sponsor.
| Measure | Target | Day 30 (31 Mar) | Day 60 and 90 (30 Apr, 28 May) |
|---|---|---|---|
| Backlog of claims waiting | Back to normal by working day 24 (1 April) | Size of the backlog and the forecast clearing day | Stays at normal level |
| Claims per handler a day | 18 by working day 20 | Share of teams at 18 or more | Every team at 18 or more |
| First-pass error rate | At or below the old system's rate | Weekly trend since go-live | Stable |
| Logins to the old system | Zero after it turns read-only on 12 April | Count by team | Zero |
| Second pulse (Desire, Ability) | 80% agree | Fielded 22–26 March, shown beside the first | Third pulse at day 90 |
Name the teams that reached 18 claims a day first and the champions who carried them. When every measure is on target at 90 days, close the change formally; our project closure presentation guide has the lessons-learned template. Add the new process to your onboarding presentation and retire the old slides.
The data point for the sponsor deck: Prosci's 88% against 13%
In Prosci's benchmark study, 88% of participants who rated their change management as excellent said their project met or exceeded its objectives, against 13% of those who rated it poor. It is a correlation from self-reported data, so present it as one.
The figures are reported in Prosci's Best Practices in Change Management, 12th edition (2023), whose executive summary credits the chart to benchmarking research with more than 10,800 respondents in 101 countries; the 12th-edition study itself drew 2,668 respondents (Prosci, 12th Edition Executive Summary). Prosci's article on the result gives the full ladder by rated effectiveness (Prosci, The Correlation Between Change Management and Project Success).
| Rated effectiveness | Met or exceeded objectives | Against "poor" |
|---|---|---|
| Excellent | 88% | 88 ÷ 13 = 6.8 times, which Prosci rounds to "seven times" |
| Good | 73% | 73 ÷ 13 = 5.6 times |
| Fair | 39% | 39 ÷ 13 = 3.0 times |
| Poor | 13% | Baseline |
Three cautions keep the slide honest. First, both measures are self-reported, so a team that felt successful may rate both highly. Second, it is an association, not an experiment; better-run organisations may simply do both well. Third, Prosci sells change management methodology, which is worth a footnote. A fair slide line reads: "Prosci benchmark (12th edition, 2023, self-reported): 88% of projects with excellent change management met or exceeded objectives, against 13% with poor. Correlation, not proof of cause." Put it on the case-for-change or the ask slide, once, and let your own numbers do the rest.
Pass/fail checklist before you present a change
Run this check before the sponsor meeting and again before the announcement. Each line passes only if the stated condition is true.
- Two decks exist, from one fact base.Sponsor and employee decks quote the same impact table, dates and pulse figures.
- The case for change has a number.One cost of the current state with its arithmetic, and one dated consequence of doing nothing.
- The impact table is complete.Every affected group with what changes, degree on a written 1 to 5 rule, headcount and training hours, with totals that add up.
- "What it means for you" is on slide three or earlier.By role, with training hours, what stays the same and the honest costs.
- The ask is specific.Every decision has an amount, a date or a name; none says only "support".
- The capacity plan covers both draws.Training hours and the go-live dip in units of work, the cover for each, and the day the backlog clears.
- The pulse is read by stage.Response rate shown; the earliest stage below target named; the response to it on a slide.
- Resistance is presented as evidence.The concerns actually heard, with a response and a measure for each.
- Managers are briefed first.Team leads get the toolkit before the announcement and present it within three working days.
- Benchmarks are labelled.Any outside figure carries its source, year and "correlation" where it is one.
3 AI prompts for a change management presentation
Use them in NOXI after attaching your project plan and impact spreadsheet, or in any AI tool that accepts files. Replace the brackets; an AI tool should arrange your facts, never supply them.
Create a 7-slide change management presentation for the [steering committee] from the attached [project plan] and [impact table, budget and pulse results (Excel)]. Change: [new claims system for 420 people, go-live 1 March 2027]. Slides: case for change with one cost [$3,442,500 a year of re-keying] and one consequence [old platform unsupported after 31 December 2027]; what changes by group; the impact table with totals; timeline with dates and owners; risks, the pulse and the capacity plan; how we measure; the ask [$830,473; targets paused for 20 working days; CEO presents on 12 January 2027]. Use every number exactly as in the files. Titles as full-sentence findings.
From the same attached files, create an 8-slide employee announcement for [all 420 claims staff], 15 minutes. Slide 1: what is changing and the date. Slide 2: why, with one number. Slide 3: what it means for you, by role, with training hours [handlers 7, team leads 10, quality assurance 4, payments 2] and what stays the same. Then: [targets paused for 20 working days], four dates, support [17 floor champions], what you told us [pulse results] and where to ask. Plain, calm language; state the honest costs.
On the ADKAR slide, add the results of the attached [second pulse (Excel)] beside the first, each stage with its number of responses. Keep the 80% target line, mark any stage still below it, and retitle the slide to name the earliest stage below target and what we will do about it. Change nothing else.
How to build a change management presentation in NOXI
NOXI turns the files behind a change into structured decks with charts from your data. It is free, with no card and no watermark; uploading files needs a free account, and a full deck uses about 25 of the 1,000 monthly credits.
Step 1: Attach your plan and your impact table
Choose Create from file and attach your project plan as Word or PDF and your impact table, budget and pulse results as an Excel or CSV file, up to 200 MB each. Paste Prompt 1 so NOXI builds the sponsor deck from your own numbers.
Step 2: Review the outline first
Choose Plan mode to review the outline before generation. Check that the seven titles read as findings, that the ask is the last slide and that every decision in it carries an amount or a date, then generate and watch each slide being built.
Step 3: Check every number against the fact base
Compare each headcount, training hour, date and pulse figure with your spreadsheet. Edit text on the slide, edit table cells and chart numbers in NOXI, or ask the AI in plain English or Arabic to correct a figure on one slide or across the whole deck.
Step 4: Add your logo and brand colour
Add your logo and brand colour to the deck so it looks like your company's own. Click any element and tell the AI what to change, for example to move the totals row of the impact table to the top or to enlarge the ask.
Step 5: Create the employee announcement from the same files
Choose Create from file again, attach the same plan and spreadsheet, and paste Prompt 2. Check that "what it means for you" is on slide three and that the training hours match the sponsor deck row for row.
Step 6: Share, export and present
Share a view-only link with the sponsor before the meeting, or invite the change team by email to edit together in real time. Download an editable PowerPoint (.pptx) with real text boxes and embedded fonts, or a PDF, or present full-screen from NOXI.
Frequently asked questions
- What should a change management presentation include?
- A change management presentation should include the case for change with one number, what changes for each group, an impact table with headcounts and training hours, a dated timeline, the risks and resistance you expect, how you will measure adoption, and a specific ask. Build it as two decks: a sponsor deck for approval and an employee announcement that says what changes for each person and when.
- How do you present a change to employees?
- Present a change to employees in six beats: what is changing, why, what it means for you, when, how you will be supported and where to ask. Reach "what it means for you" by slide three, by role, with training hours, what stays the same and the honest costs. Have the most senior leader give the business reasons and each team lead follow up with their own team within three working days.
- What is the ADKAR model?
- The Prosci ADKAR® Model is a model of individual change developed by Jeff Hiatt of Prosci. Its five elements are Awareness of why the change is needed, Desire to support it, Knowledge of how to change, Ability to apply new skills and behaviours, and Reinforcement to sustain the change. Prosci advises focusing support on the earliest element a person has not yet reached.
- How do you handle resistance to change in a presentation?
- Treat resistance as evidence about the plan. Name the two or three concerns you actually heard in the pulse survey, comments and team briefings, say what you will do about each, and say how you will measure whether it worked. A "what you told us" slide that shows a concrete response, such as pausing individual targets during go-live, builds more trust than any reassurance.
- What is a change management plan?
- A change management plan sets out how an organisation will help people adopt a change: the impact assessment, communication, training, go-live support, how resistance will be handled, how adoption will be measured and who owns each part. The sponsor deck presents it for approval; the employee deck presents the parts each person acts on.
- How do you communicate organisational change?
- Communicate organisational change in a fixed sequence: get the sponsor's approval, brief managers, announce to everyone affected, then hold team briefings within three working days and a regular Q&A. Prosci's 2023 benchmark found employees prefer business-impact messages from the chief executive and personal messages from their own manager. Repeat the key dates in every message.
- How long should a change management presentation be?
- A sponsor approval deck needs about 7 slides and 20 minutes, with an appendix for detail. An employee announcement needs 6 to 8 slides and about 15 minutes, followed by 15 minutes of questions. A team lead's follow-up needs 3 slides and about 10 minutes in a team meeting. For a class assignment, follow the brief; five slides fit a 10-minute slot.
- Can AI make a change management presentation?
- Yes. AI presentation tools can turn a project plan, an impact spreadsheet and survey results into a sponsor deck and an employee announcement, write action titles and lay out the tables and charts. Give the tool your own numbers and tell it to invent none, then check every headcount, date and percentage against your fact base before anyone sees the deck.
Sources & methodology
How this guide was made: the ADKAR and Kotter descriptions and the benchmark figures come from the owners' own pages and Prosci's executive summary. The two-deck structure, slide orders, "slide three" rule, degree rule, ADKAR messages, measures and targets, capacity method, manager toolkit and checklist are editorial recommendations, not published standards. Calder Mutual and all its figures are fictional; every calculation was checked. All sources were checked on 19 October 2026.
- [1] ADKAR as a model for understanding and supporting individual change; the five elements and their descriptions; the elements are sequential but not linear; focus support on the earliest unmet element — Prosci, The Prosci ADKAR® Model.
- [2] The ADKAR Model was developed by Jeff Hiatt; a framework for managing individual change in an organisation — Prosci, The ADKAR Model: A Structured Approach (updated 25 September 2026).
- [3] 88% (excellent), 73% (good), 39% (fair) and 13% (poor) of participants met or exceeded objectives; "approximately seven times more likely"; framed by Prosci as a correlation — Prosci, The Correlation Between Change Management and Project Success (updated 7 August 2026).
- [4] 12th edition, a 2023 study; 2,668 respondents, 38 industries, 101 countries; "Excellent Change Management Drives 7X Success", credited to benchmarking research from 10,800+ respondents in 101 countries; front-line employees prefer business-impact messages from the CEO, and people managers remain the preferred senders of personal messages — Prosci, Best Practices in Change Management, 12th Edition Executive Summary (2023).
- [5] The eight steps, their names and order; the model grew out of the linear process in Leading Change and became "8 Accelerators" in Accelerate (2014) — Kotter Inc., The 8-Step Process for Leading Change.
Build your change management presentation in NOXI, free: attach your project plan and impact table, review the sponsor deck's titles in Plan mode, create the employee announcement from the same files, and export an editable PowerPoint or a PDF.
