Risk management presentation: the 10-slide template, the 5×5 risk matrix and the register slide, with a worked example

The 10-slide template timed to 10 minutes, how to calculate a risk score, the 5×5 matrix and its 14 possible scores, 3×3 vs 5×5, the register slide, inherent vs residual risk, expected loss, risk appetite, board, project and HSE workplace versions, and a fully worked example.

Listen to article 2:15 Try NOXI free
Risk management presentation — NOXI guide cover: score every risk as likelihood times impact, show the top five before and after controls, then ask for one decision each

Disclosure: NOXI publishes this guide and is one of the tools it mentions; the method works in any presentation software.

Quick answer: A risk management presentation shows the risks that could stop an organisation reaching its objectives and asks for a decision on each. Score every risk as likelihood × impact on the same 1–5 scales, show the top five before and after controls, price the top risk, and ask the room to accept, reduce, transfer or avoid.

Most risk decks are a red-amber-green grid and a 40-row register pasted onto a slide. The committee sees colour, not choices. A useful one scores every risk with one written rule, shows what controls change, and ends with owned, dated decisions. Below: the 10-slide template, the 5×5 scoring rule, the before-and-after and money slides, three versions, and a fictional food plant, Kestrel Foods, worked through in full.

In short

  • The ruleScore every risk as likelihood × impact on the same 1–5 scales, show the top five before and after controls, and ask for one decision per risk: accept, reduce, transfer or avoid.
  • Length10 slides in 10 minutes, plus 5 minutes of questions. The full register stays in the spreadsheet and the appendix.
  • The matrixA 5×5 matrix produces only 14 distinct scores (1, 2, 3, 4, 5, 6, 8, 9, 10, 12, 15, 16, 20, 25), so set band thresholds on those values deliberately.
  • Before and afterInherent risk is the score before controls; residual risk is the score after them. Show both on one slide, with the control in between.
  • MoneyFor the top risk, expected loss = annual probability × loss if it happens. Compare the cut in expected loss with the cost of the control.
  • Worked exampleKestrel Foods (fictional) cuts its top-five score total from 51 to 30; a $28,000 second supplier cuts expected loss by $67,500, a net $39,500 a year.

Key numbers

5 steps
HSE's steps to manage workplace risk: identify hazards, assess, control, record, review (UK; page updated 16 Oct 2026) [1]
5+
Employees at which a UK employer must record the significant findings of its risk assessment, HSE [1]
5 levels
NIST SP 800-30 Rev. 1 scale for likelihood, impact and level of risk: very low, low, moderate, high, very high [2]
96–100
NIST's semi-quantitative range for very high risk (high 80–95, moderate 21–79, low 5–20, very low 0–4), Table I-3 [2]
1,300+
Experts surveyed for WEF's Global Risks Report 2026, the 21st edition, published 14 January 2026 [3]
Dec 2027
When the EU AI Act's rules for high-risk uses in Annex III apply (2 December 2027), extended under the AI Omnibus, in force since 27 July 2026 [4]

The first four are the official anchors for the method below; the last two are 2026 context for a January risk review.

What is a risk management presentation?

A risk management presentation is a short slide talk that tells a decision-making group which risks matter most, how they were scored, what the controls change and what decisions are needed now. It is the meeting version of a risk register: five risks and their decisions on screen, the full list in the file.

Four groups give this talk: project managers with a steering group, risk and audit teams with a board, safety coordinators with a site, and students on MBA, engineering and PMP courses. The spine is the same; the scales change.

Risk management presentation vs risk assessment presentation

A risk assessment presentation reports one assessment: the risks found, who they affect, their scores and the controls needed. A risk management presentation reports the cycle over time: controls in place, what changed since the last review and the decisions due.

The 10-slide risk management presentation template

The 10-slide risk management presentation template runs 10 minutes: context and appetite, method and scales, the matrix, the top five risks, the register, inherent vs residual, the expected loss of the top risk, actions and owners, what changed since the last review, and decisions needed. The matrix and the top five get the most time.

#SlideWhat goes on itMinutes
1Context and appetiteThe objective at risk, the period, who decides, and the appetite in one sentence per category1
2Method and scalesLikelihood 1–5 and impact 1–5 with their definitions; the score bands1
3The matrixThe top risks placed on a 5×5 grid by their scores, banded1.5
4Top five risksFive rows: risk, owner, inherent score, trend since the last review1.5
5Register extractCause, event, effect and control for the same five; the rest in the appendix1
6Inherent vs residualScore before controls, the control, score after controls1
7Expected lossThe top risk in money, with and without the proposed control, and the control's cost1
8Actions and ownersEach open action with an owner and a due date1
9What changedNew, closed and re-scored risks since the last review0.5
10Decisions neededAccept, reduce, transfer or avoid, per risk, and the next review date0.5
Total10 slides1 + 1 + 1.5 + 1.5 + 1 + 1 + 1 + 1 + 0.5 + 0.510

These timings are our planning guidance, not a standard, for a 15-minute slot with 5 minutes of questions.

Risk management presentation PPT and PDF

To build a risk management presentation PPT, make ten slides, rewrite each slide name above as a finding ("Ransomware is still high after controls"), and give each slide one table or chart. Send the PDF as a pre-read two working days before the meeting.

How many slides for a risk presentation?

A risk presentation needs about 10 slides for a 10-minute slot. With more than five risks to discuss, show the top five and put the rest in an appendix table.

What risk management is: HSE's five steps and the ISO 31000 process

Risk management is the routine of finding what could harm your objectives, judging how likely and how serious it is, controlling it, and checking the controls work. The UK's HSE puts it in five steps for workplaces; ISO 31000:2018 describes a general process of identifying, analysing, evaluating, treating, monitoring and communicating risk.

The UK government's Orange Book, the risk guidance for government departments and arm's length public bodies, defines risk as the effect of uncertainty on objectives (Orange Book, 2023 edition). That is why slide 1 names the objective.

HSE five steps (UK workplaces)ISO 31000 process (any organisation)Slide it feeds
1. Identify hazardsIdentify risksRegister extract (slide 5)
2. Assess the risksAnalyse and evaluate risksMethod, matrix, top five (slides 2 to 4)
3. Control the risksTreat risksInherent vs residual, actions (slides 6 and 8)
4. Record your findingsRecord and report; communicateThe deck and the register itself
5. Review the controlsMonitor and reviewWhat changed (slide 9)

HSE says controls must be reviewed to make sure they are working (HSE). On iso.org, ISO 31000:2018 is listed as edition 2, published February 2018, last reviewed and confirmed in 2023, with a revision under development; ISO says it provides guidelines and is not a certifiable standard (ISO).

How to calculate a risk score: likelihood × impact

To calculate a risk score, rate the likelihood that the risk happens on a 1–5 scale, rate its impact if it happens on a 1–5 scale, and multiply the two: score = likelihood × impact, from 1 to 25. Write the scales down with definitions.

NIST's guide for risk assessments describes risk as typically a function of the adverse impact if an event occurs and the likelihood that it occurs (NIST SP 800-30 Rev. 1, September 2012). It adds that assessments are more repeatable when each value is annotated with its reasons, so keep a one-line reason per score in the register.

The likelihood scale

Define likelihood as a probability per year, so a "4" means the same for every owner. These bands are our example.

ScoreLabelChance of happening in the next 12 months
5Almost certain50% or more
4Likely20% to under 50%
3Possible10% to under 20%
2Unlikely2% to under 10%
1RareUnder 2%

The impact scale

Define impact in the unit your committee uses, usually money, plus people and regulation. Size the money bands to the organisation; these fit a single plant.

ScoreLabelFinancial lossPeople and regulation
5Severe$1,000,000 or moreSerious injury; prosecution or licence at risk
4Major$300,000 to under $1,000,000Lost-time injury; formal regulator action
3Moderate$100,000 to under $300,000Medical treatment; regulator enquiry
2Minor$25,000 to under $100,000First aid; internal finding
1MinimalUnder $25,000No injury; no finding

Likelihood and impact matrix

A likelihood and impact matrix is the grid made by the two scales: likelihood on one axis, impact on the other, each cell holding the product. Keep the two separate: a risk is not "high" because it is frightening.

Risk score formula with velocity

Some teams add velocity, how fast the impact arrives, as a third factor. Show it as its own column ("hours", "weeks") rather than multiplying it in; a third multiplier stretches the range to 125.

What is a 5×5 risk matrix? Bands, the 14 possible scores and colours

A 5×5 risk matrix is a grid of five likelihood levels by five impact levels, where each of the 25 cells holds a score from 1 to 25 and a band such as low, medium, high or very high. Because the score is a product of two whole numbers from 1 to 5, only 14 different scores can ever appear.

Definition What is a risk matrix? A risk matrix is a table that ranks risks by combining a likelihood rating and an impact rating, usually on 3, 4 or 5 levels each. Every cell is assigned a risk level or score, often colour-coded, and organisations set which levels need a decision, a mitigation plan, monitoring or simple acceptance.

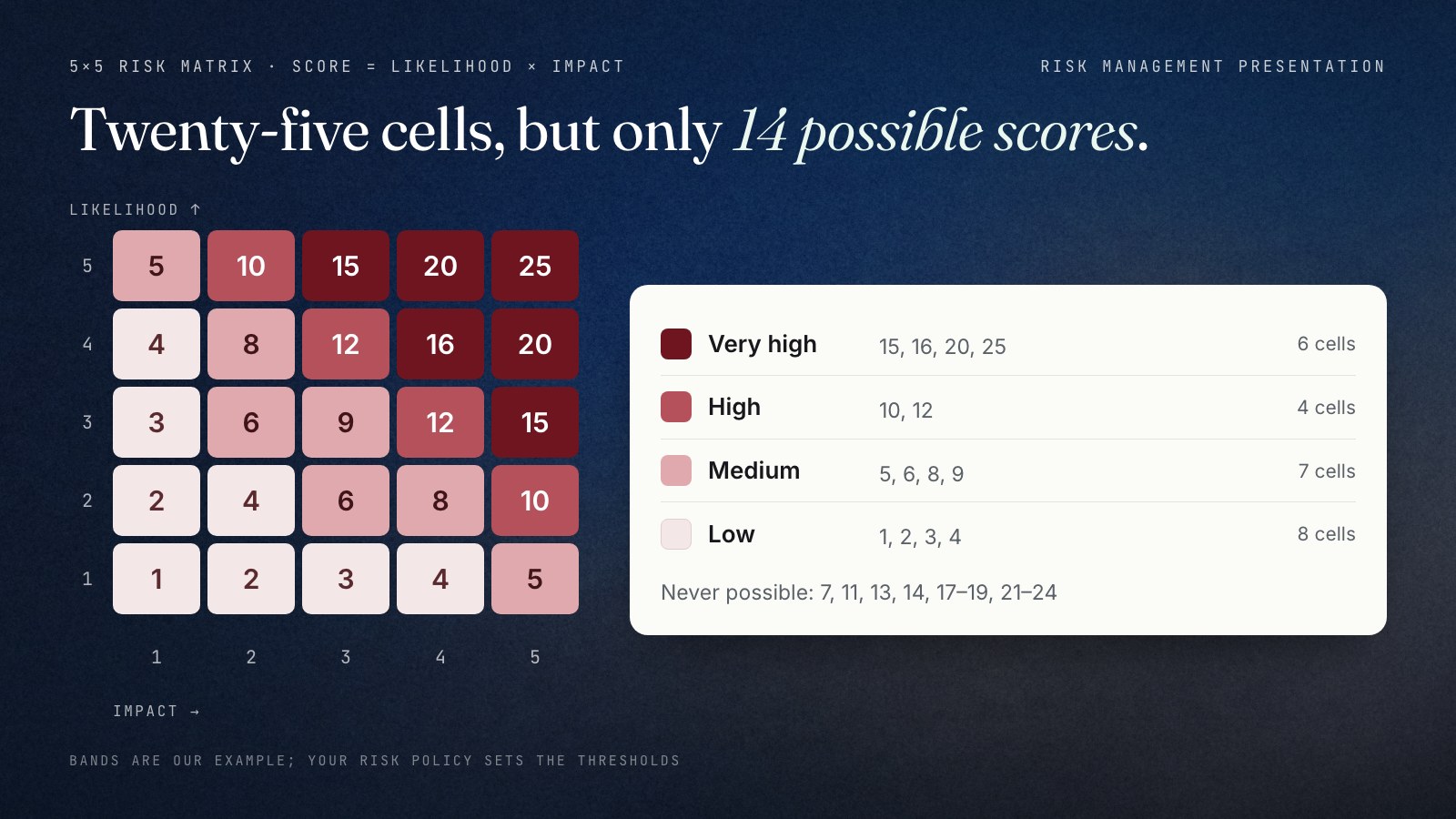

We counted every cell of a 5×5 grid. The 25 cells produce these scores, and no others: 1, 2, 3, 4, 5, 6, 8, 9, 10, 12, 15, 16, 20 and 25. There is no 7, 11, 13, 14, 17, 18, 19, 21, 22, 23 or 24. So a band written as "10–14" really means 10 or 12, and "15–25" means 15, 16, 20 or 25. Write the bands on those real values.

Score (L × I)BandScores that can occurCells of 25What the slide asks for
15–25Very high15, 16, 20, 256A decision today and a named owner
10–14High10, 124A mitigation plan with a due date
5–9Medium5, 6, 8, 97Monitor monthly with a named owner
1–4Low1, 2, 3, 48Accept and record
Total4 bands14 distinct scores6 + 4 + 7 + 8 = 25Our example; your policy sets the bands
A 5×5 risk matrix with likelihood 1 to 5 on the vertical axis and impact 1 to 5 on the horizontal axis. Each cell shows its score, likelihood times impact, and is shaded by band: low 1 to 4 in 8 cells, medium 5 to 9 in 7 cells, high 10 or 12 in 4 cells, very high 15 to 25 in 6 cells. Only 14 distinct scores appear: 1, 2, 3, 4, 5, 6, 8, 9, 10, 12, 15, 16, 20 and 25.
Twenty-five cells, fourteen possible scores: set band thresholds on the values that can actually occur.

The rare catastrophe problem

Multiplication treats a rare catastrophe (1 × 5 = 5) the same as a near-certain nuisance (5 × 1 = 5). Add one rule: any risk with impact 5 goes to the committee whatever its score. NIST's own Table I-2 avoids the problem a different way: it combines likelihood and impact with a lookup table rather than multiplication, so a very high likelihood with a very low impact stays very low risk, while a very low likelihood with a very high impact is rated low (NIST SP 800-30 Rev. 1, Table I-2).

Risk heat map: colours that still work in black and white

A risk heat map is the matrix with cells coloured by band, and its red and green fail in greyscale and for colour-blind readers. Print the score in every cell, use four shades of one colour, darker as the band rises, and name the bands in a legend.

Semi-quantitative scales: NIST's 0–100 ranges

If your organisation reports on 0–100, use NIST's published ranges (Table I-3, in Key numbers above) and say so on the method slide, rather than inventing a new set.

3×3 vs 5×5 risk matrix: when the simple version is better

A 3×3 risk matrix has three levels each for likelihood and impact (low, medium, high) and produces only six distinct scores: 1, 2, 3, 4, 6 and 9. It is better for a first assessment, a small team or a site toolbox talk; a 5×5 is better when you must rank more than a dozen risks or show movement after controls.

Question3×3 matrix5×5 matrix
Distinct scores6 (1, 2, 3, 4, 6, 9)14 (1 to 25, with gaps)
Time to score one riskSeconds; easy to agreeLonger; needs written scale definitions
Shows the effect of a controlOften not: one step down is a big jumpYes: one step down is visible
Best forWorkplace checks, small projects, studentsEnterprise registers, projects with 15+ risks, boards

Use the same matrix for every risk and every review, or the trend column means nothing.

The risk register slide: what to show and what stays in the spreadsheet

A risk register is the list of all identified risks with, for each one, a cause, the risk event, its effect, an owner, its scores, its controls and its actions. The register slide shows only the top five rows and five columns.

ColumnOn the slideIn the spreadsheet only
RiskOne line: cause, event, effect ("A single packaging supplier fails, so lines stop")Full description, category, ID
OwnerA role, not a departmentContact and deputy
ScoresInherent and residual, as L × I = scoreReasons for each rating, score history
ControlThe one control that moves the scoreAll controls, test dates and results
TrendUp, down or flat since the last reviewEvery past review

"Supplier risk" is a topic; "our only packaging supplier fails, so the lines stop for three weeks" is a risk the committee can score.

Risk register vs risk management plan

A risk management plan is the rulebook: the scales, the bands, the appetite, who owns what, and how often risks are reviewed. A risk register is the list the rulebook produces: every risk with its scores and actions. In project management, a RAID log combines risks with assumptions, issues and dependencies; present its risk rows the same way.

Inherent vs residual risk: one slide with the control in between

Inherent risk is a risk's score before any controls; residual risk is the score that remains after the controls in place or planned. Showing both tells the committee what each control buys.

Definition What is inherent risk? Inherent risk is the level of a risk assessed as if no controls were in place: its likelihood and impact in the raw state of the activity. It shows how much depends on the controls, so a high inherent score with a low residual score marks a control that must be tested and kept.
Definition What is residual risk? Residual risk is the level of a risk that remains after controls are applied. It is compared with the organisation's risk appetite: if the residual score is within appetite, the risk can be accepted; if not, the slide asks for a further control, a transfer, or a decision to stop the activity.
Example Kestrel Foods, Riverside plant (fictional). A food manufacturer's single plant, January 2027 review. Risk lead: Hana Okoye. Scales and bands as above.

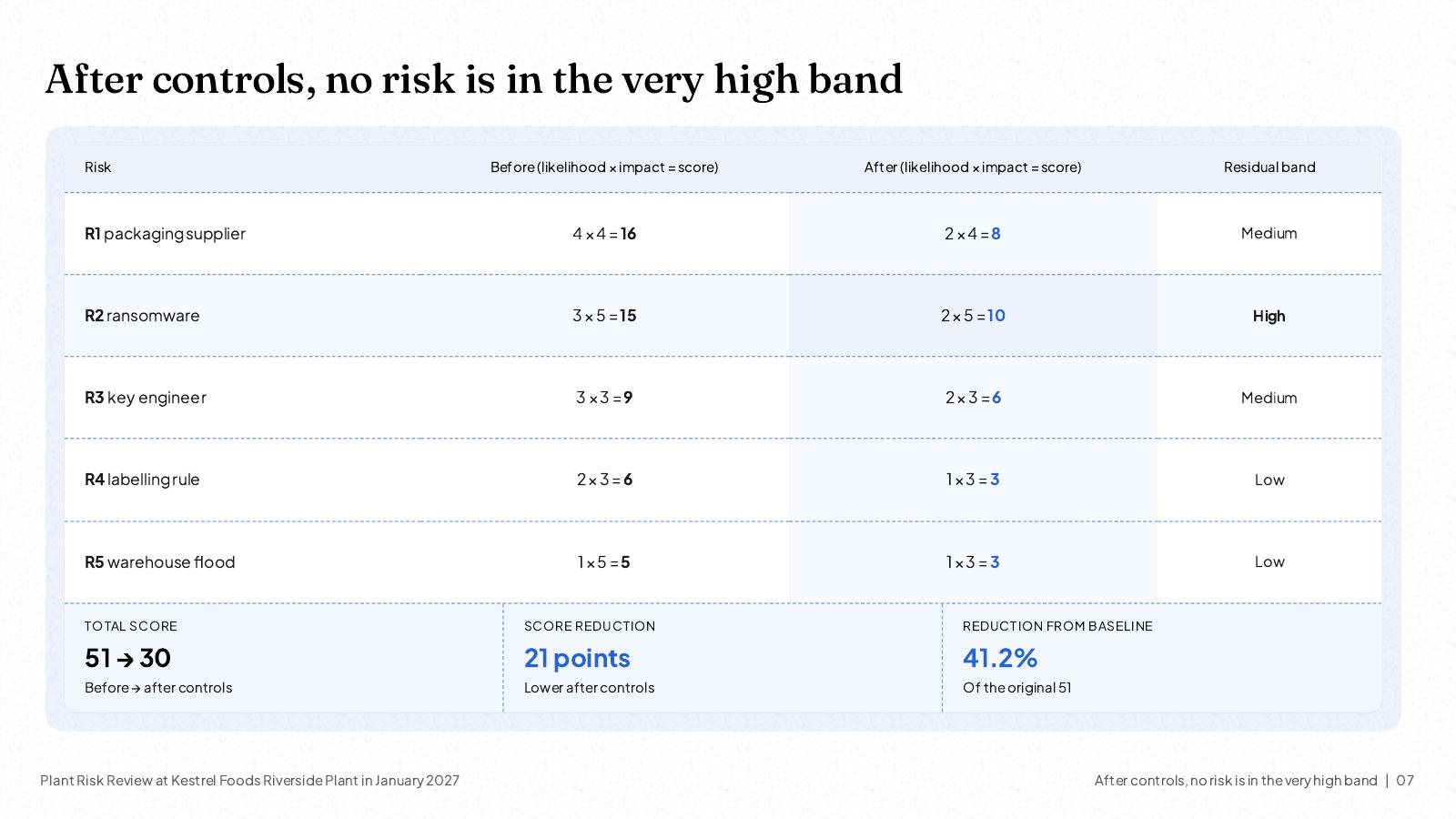

RiskInherent L × IControlResidual L × I
R1 Single packaging supplier fails4 × 4 = 16 (very high)Second supplier qualified2 × 4 = 8 (medium)
R2 Ransomware stops plant systems3 × 5 = 15 (very high)Patching plus offline backups, tested monthly2 × 5 = 10 (high)
R3 Key maintenance engineer leaves3 × 3 = 9 (medium)Two technicians cross-trained2 × 3 = 6 (medium)
R4 New labelling rule needs repackaging2 × 3 = 6 (medium)Regulatory watch; label template ready1 × 3 = 3 (low)
R5 Warehouse flood1 × 5 = 5 (medium)Insurance and raised racking1 × 3 = 3 (low)
Total score16 + 15 + 9 + 6 + 5 = 51Five controls8 + 10 + 6 + 3 + 3 = 30

The total falls by 51 − 30 = 21, and 21 ÷ 51 = 41.2%. Scores are ordinal (a 10 is not "twice as bad" as a 5), so use that percentage only as a one-line summary, never as money. Four controls lower likelihood (R1 from 4 to 2, R2 from 3 to 2, R3 from 3 to 2, R4 from 2 to 1) and one lowers impact (R5 from 5 to 3). R2's impact stays at 5 because a successful attack would still stop production until systems are restored. Say which factor each control moves; it is the question a good committee asks.

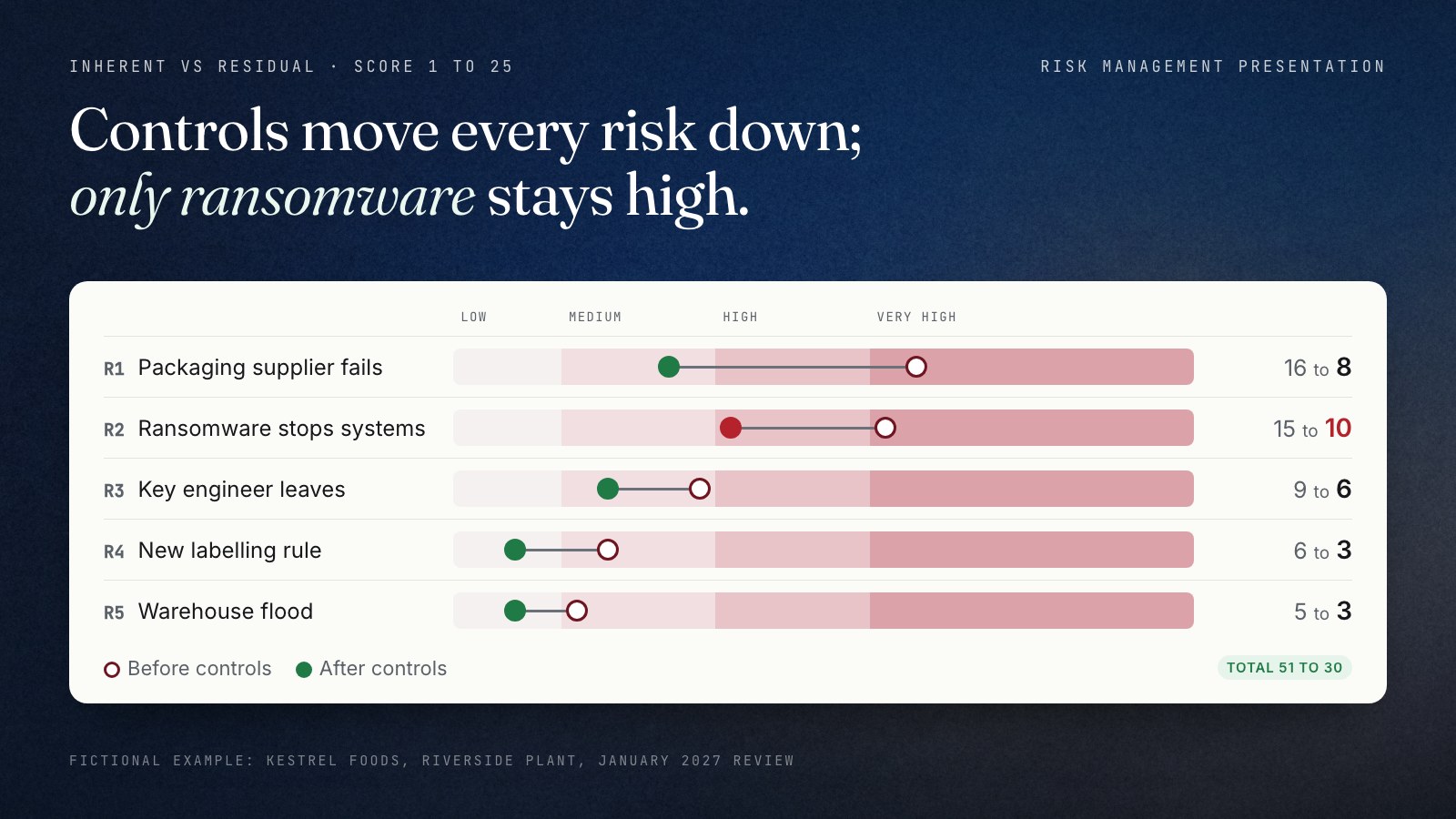

Before-and-after chart for five fictional Kestrel Foods risks: packaging supplier failure from 16 to 8, ransomware from 15 to 10, key engineer leaving from 9 to 6, labelling rule from 6 to 3, warehouse flood from 5 to 3. Total score falls from 51 to 30, and ransomware is the only risk still in the high band.
Every risk moves down after controls; only ransomware stays in the high band, so it gets the next action.

R5 shows why the impact-5 rule matters: at 1 × 5 = 5 it would sit with routine risks. R2 is still high at 10 after controls, so the example's slide 9 asks for a recovery drill. Backups and drills cover recovery; for the staff habits that make an attack less likely, our cybersecurity awareness presentation guide has the employee session.

Expected loss and the cost of mitigation: the money slide

Expected loss is the annual probability of a risk happening multiplied by the loss if it happens. For the top risk, compare the expected loss with and without the proposed control, then subtract the control's annual cost; the result tells the committee whether the control pays for itself.

Kestrel's R1, the single packaging supplier, works like this. If the supplier fails, the plant loses three weeks of output, valued at $450,000. Without a second supplier, the chance in the next 12 months is 20% (likelihood 4 on the scale above):

LineArithmeticPer year
Expected loss, today0.20 × $450,000$90,000

Expected loss, with a second supplier0.05 × $450,000 (likelihood 2)$22,500
Reduction in expected loss90,000 − 22,500$67,500
Cost of the second supplierQualification, audits and higher unit price$28,000
Net benefit67,500 − 28,000$39,500

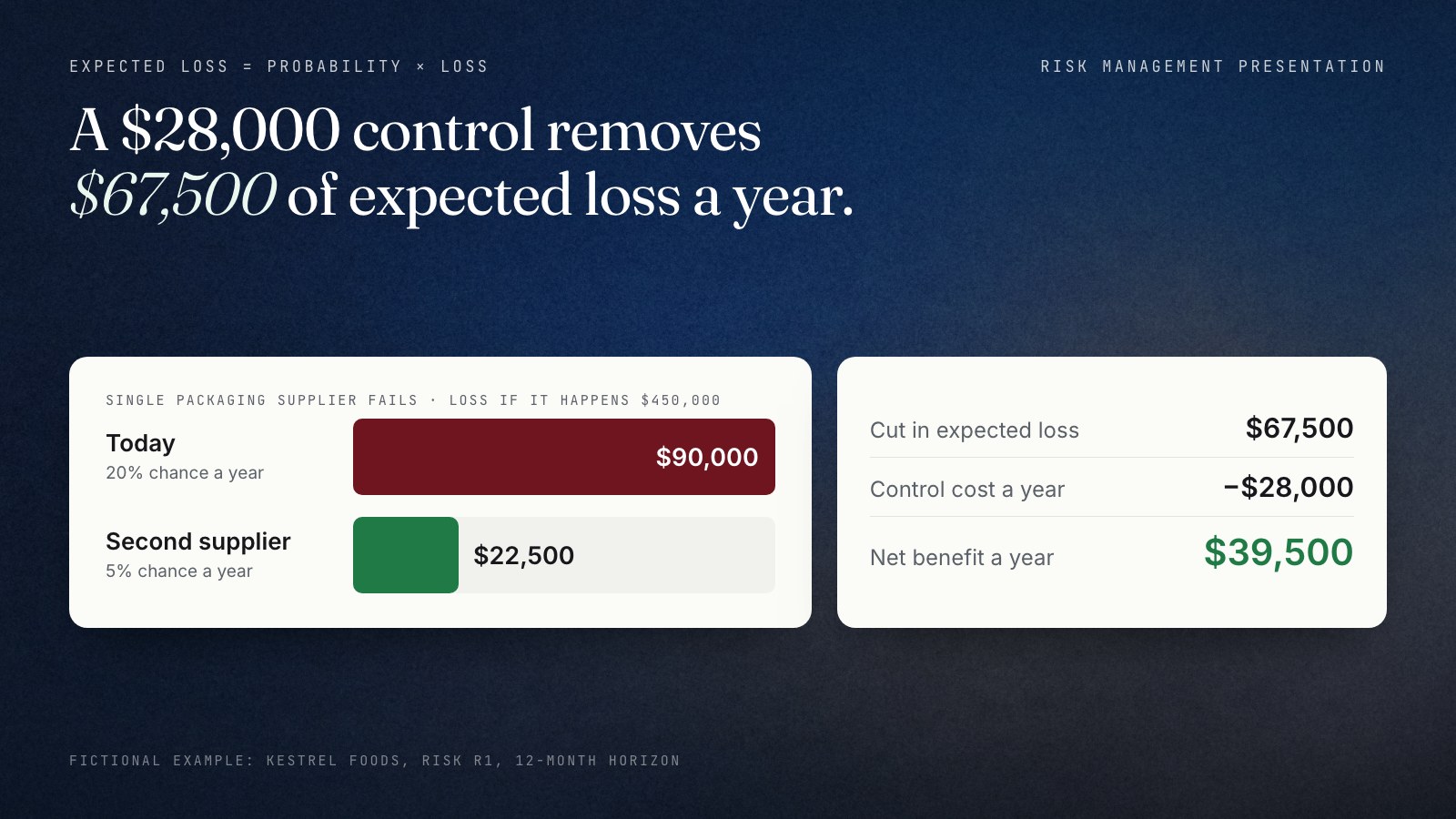

Bar chart for the fictional Kestrel Foods packaging supplier risk: expected loss of $90,000 a year at a 20% chance, falling to $22,500 a year at 5% with a second supplier. The reduction is $67,500; minus the second supplier's $28,000 annual cost, the net benefit is $39,500 a year.
The control costs $28,000 a year and removes $67,500 of expected loss: the decision is in the subtraction.

The break-even probability

Add one line that answers the sceptic: how wrong could the 20% be before the control stops paying? The control pays while the cut in probability × $450,000 exceeds $28,000, so the cut must exceed 28,000 ÷ 450,000 = 0.062, or 6.2 percentage points. If the true chance today is about 11.2% or more (5% + 6.2 points) and the second supplier brings it to 5%, the control still pays.

Risk appetite statements: one sentence per category

A risk appetite statement says how much risk an organisation is willing to take, in each category, to reach its objectives. On the slide it is one sentence per category with a threshold the scores can be checked against, such as "no residual risk above 4 for food safety".

Definition What is risk appetite? Risk appetite is the nature and extent of risk an organisation is willing to take to achieve its objectives, set by its board or leadership. A risk appetite statement turns it into limits per category, so residual risk scores can be compared with the limit and anything above it is escalated for a decision.

The Orange Book makes setting it a board task: the board should determine and continuously assess the nature and extent of the principal risks the organisation is exposed to and willing to take, which is its risk appetite (Orange Book, section A3).

CategoryAppetiteStatement for the slide
Food safety and worker safetyAverseWe accept no residual risk above 4; anything higher is treated before production continues.
SupplyCautiousWe accept residual supply risks up to 8; above that, we qualify a second source.
TechnologyCautiousWe accept residual risks up to 9 and test recovery for anything above.
GrowthOpenWe accept residual risks up to 12 for new products, with a stop rule at each launch gate.

With these on slide 1, R2's residual 10 is visibly above Kestrel's technology limit of 9.

How to present risks and mitigation: four decisions

To present risks and mitigation, give each top risk one line of cause and effect, its score before and after the control, the control's cost and owner, and one of four decisions: accept, reduce, transfer or avoid. Without a decision, it is a status report.

DecisionWhat it meansWhen to ask for it
AcceptKeep the risk, record the decision and watch itResidual score within appetite
ReduceAdd a control that lowers likelihood, impact or bothResidual above appetite and a control costs less than it saves
TransferShare the loss with an insurer or a contract partnerHigh impact, low likelihood, insurable
AvoidStop or do not start the activity that creates the riskNo control brings the risk within appetite

The Orange Book's list is a little longer: avoiding the risk, taking or increasing it to pursue an opportunity, retaining it by informed decision, changing the likelihood, changing the consequences, and sharing it, for example through contracts (Orange Book, section D6). The four words above fit on a slide.

Write the mitigation as a dated action

"Improve cyber resilience" is an intention. "Recovery drill on 18 February 2027; owner: IT manager; pass if production is back within 24 hours" is a mitigation.

Enterprise risk management presentation to the board: top five, trend, decisions

An enterprise risk management presentation to a board shows the top five principal risks with their residual scores against appetite, the trend since the last meeting, and the decisions only the board can take. Boards read the pack in advance, so lead with changes, not method.

  • Lead with what changed: new risks, risks that crossed an appetite line, closed risks.
  • Show trend: an up, down or flat marker beside each residual score.
  • Move method to the appendix: the board approved the scales once.
  • Name the decision per risk, with its cost, and end with the next review date.

For the rest of the board pack, our board meeting presentation guide covers the full deck. If the board is weighing risks alongside strengths and opportunities in a strategy review, the SWOT analysis presentation shows where the threats quadrant ends and the risk register begins.

Project risk management presentation: the probability and impact matrix

A project risk management presentation shows the project's top risks to the sponsor or steering group, scored on a probability and impact matrix, with a response, an owner and a trigger for each.

In PMP exam preparation the grid is called a probability and impact matrix; it is the same likelihood × impact grid. Project decks differ in three ways:

  • Impact in project units: weeks of delay and budget overrun.
  • A trigger per risk: the event that says the risk is happening ("vendor misses the pilot date").
  • Contingency linked to risks: the budget reserve sized to the top risks' expected cost.

Put the top three to five project risks on your status report, not a separate deck: our project status report presentation guide has the one-slide format and RAG rules. When the risks sit inside a funding request, the business case presentation guide shows how to carry them into the options appraisal.

In some regulated sectors, risk management is a legal requirement. For US medical device makers, FDA's Quality Management System Regulation took effect on 2 February 2026 and incorporates ISO 13485:2016 by reference; FDA says this now makes risk management a specific requirement (FDA, QMSR).

Risk assessment presentation for the workplace: HSE's five steps (UK)

A workplace risk assessment presentation walks through HSE's five steps for one site or task: the hazards found, who might be harmed and how, the controls in place and the further actions needed, what is recorded, and when it will be reviewed. In the UK, an employer with 5 or more employees must record the significant findings.

HSE's wording is short: "If you employ 5 or more people, you must record your significant findings" (HSE). The findings it lists are the hazards, who might be harmed and how, and what you are doing to control the risks. That gives the slide order.

  1. Hazards: what may cause harm, found by walking the site with the workers.
  2. Who and how: the groups at risk (new starters, night shift, contractors, visitors) and the way each could be harmed.
  3. Assessment: how likely harm is and how serious, scored on your matrix, often a 3×3 at site level.
  4. Controls: HSE's first question is whether you can get rid of the hazard altogether; if not, how to control the risk so harm is unlikely. Protective equipment comes last in its list of controls.
  5. Actions: who does what by when.
  6. Record and review: where the record lives and the review date, plus early-review triggers: changes to staff, a process, or the substances or equipment used, or an accident or near miss.

This is a UK rule; other countries set their own duties, and this guide is not legal or safety advice. The same six-slide order works for a health and safety course presentation built on the five steps.

To brief a shift on one hazard before the full assessment, our safety moment ideas with a 5-minute format give a topic for every week. When an accident or near miss triggers the review, find the cause before you re-score: the root cause analysis presentation guide compares seven methods, from 5 Whys to fishbone.

The January risk review: using the world's risks as context

A January risk review re-scores every risk, closes what is gone, adds what is new and resets the appetite. One context slide on the outside world helps find blind spots, if it leads back to your own register.

Global Risks Report 2026: what to take from it

The World Economic Forum published the Global Risks Report 2026, its 21st edition, on 14 January 2026, built on a survey of over 1,300 experts (WEF, Global Risks Report 2026). Three findings suit a context slide:

  • Most likely trigger of a global crisis in 2026: geoeconomic confrontation, chosen by 18% of respondents, followed by state-based armed conflict at 14%.
  • Two-year outlook (to 2028): geoeconomic confrontation ranked first and misinformation and disinformation second.
  • Ten-year outlook (to 2036): extreme weather events ranked first, and half of the top 10 risks are environmental.

WEF also found 50% of respondents expect a turbulent or stormy outlook over the next two years, rising to 57% over ten years. Use it to ask which of these touches your supply chain, customers or systems, and show the answer as rows in your register; a global ranking is not a score for your plant. Check WEF's site for the 2027 edition before your review.

A risk-tier law as an example: the EU AI Act

The EU AI Act sorts AI systems into four risk levels: unacceptable, high, transparency and minimal or no risk. It entered into force on 1 August 2024 and became applicable on 2 August 2026, with some exceptions. The AI Omnibus, in force since 27 July 2026, extended the rules for high-risk uses in Annex III to 2 December 2027, and the rules for high-risk AI in Annex I products have a transition period until 2 August 2028 (European Commission, page updated 19 October 2026). An EU company using AI in hiring would add a compliance row with the 2027 date.

For the plan and budget that the risk review feeds, our annual plan and budget presentation guide shows how the risks-and-decisions slide sits in the annual plan.

Risk management presentation example: Kestrel Foods, slide by slide

Kestrel's plant risk review is 10 slides in 10 minutes, presented by Hana Okoye to the operations committee on 14 January 2027. Every number comes from the register.

  1. Plant risk review: five risks, three decisions for the operations committee (1:00): Kestrel Foods, Riverside plant; 14 January 2027.
  2. We score every risk as likelihood 1–5 × impact 1–5 (1:00): very high 15–25, high 10–14, medium 5–9, low 1–4; any impact-5 risk comes to this committee.
  3. Two risks start in the very high band (1:30): packaging supplier failure 16; ransomware 15; key engineer leaves 9; labelling rule 6; warehouse flood 5.
  4. One control for each of the five risks (1:30): second packaging supplier; patching plus offline backups tested monthly; two technicians cross-trained; label template ready; insurance and raised racking.
  5. After controls, no risk is in the very high band (1:00): supplier failure 8; ransomware 10; key engineer 6; labelling rule 3; flood 3.
  6. The total score falls from 51 to 30 after controls (1:00): a 41.2% reduction, used as a summary only.
  7. A packaging supplier failure would cost $450,000; expected loss is $90,000 a year (1:00): 20% chance today; $22,500 a year at 5% with a second supplier.
  8. A $28,000 second supplier saves a net $39,500 a year (1:00): expected loss cut by $67,500; break-even if it cuts the chance by 6.2 points.
  9. Ransomware is still high at 10, above our technology limit of 9 (0:30): recovery drill on 18 February 2027; owner: IT manager.
  10. Three decisions today (0:30): approve the second supplier; approve the recovery drill; accept the other three risks at their residual scores; next review 15 April 2027.

The times add up: 1 + 1 + 1.5 + 1.5 + 1 + 1 + 1 + 1 + 0.5 + 0.5 = 10 minutes. The appendix holds the full register of 23 risks.

Here are two slides from this article's worked example, as NOXI built them, unedited.

NOXI slide: five risks scored likelihood × impact before and after controls, packaging supplier 16 to 8, ransomware 15 to 10, key engineer 9 to 6, labelling rule 6 to 3 and warehouse flood 5 to 3, total 51 to 30, a 41.2% reduction.
The before-and-after slide: every risk with its arithmetic, its residual band and the total movement.
NOXI slide: expected loss of $90,000 a year falls to $22,500 with a second supplier, $67,500 avoided minus the $28,000 cost gives a net benefit of $39,500, with a break-even of 6.2 percentage points.
The money slide: the expected-loss bridge, the net benefit and the break-even point.

Pass/fail checklist before you present your risks

Run this check before you send the pre-read: each line passes only if its condition is true.

  1. The objective is named.Slide 1 says what the risks threaten, the period and who decides.
  2. The scales are written down.Likelihood as a probability per year; impact in money, people and regulation.
  3. The bands use real scores.Thresholds set on the 14 values a 5×5 can produce, plus an impact-5 rule.
  4. Every risk is cause, event, effect.No one-word topics such as "supplier risk".
  5. Before and after are on one slide.Inherent L × I, control, residual L × I for each top risk.
  6. The top risk is in money.Expected loss with and without the control, the control's cost and the net.
  7. Appetite is visible.Each residual score can be compared with a written limit.
  8. Every action has an owner, a date and a pass condition.No "improve" or "review" without a date.
  9. The colours survive greyscale.The score is printed in every cell of the matrix.
  10. It ends with decisions.Accept, reduce, transfer or avoid, per risk, and the next review date.

3 AI prompts for a risk management presentation

Use them in NOXI after attaching your risk register, or in any AI tool that accepts files. Replace the brackets; the tool should arrange your scores, never invent them.

Prompt 1 · The 10-slide risk review from your register

Create a 10-slide risk management presentation for the [operations committee], 10 minutes, from the attached [risk register (Excel)]. Slide order: context and appetite; how we score [likelihood 1–5 × impact 1–5; very high 15–25, high 10–14, medium 5–9, low 1–4]; the top five risks before controls as a table with likelihood, impact and score; the five controls; the same five after controls; total score before and after; expected loss of [R1] in money; the control's cost and net benefit; the risk still above appetite with its next action, owner and date; decisions needed and the next review date. Use every score and amount exactly as in the file and invent none. Titles as full-sentence findings.

Prompt 2 · Add the money slide for the top risk

After the inherent vs residual slide, add one slide for [R1 single packaging supplier fails]: loss if it happens [$450,000]; chance today [20% a year], expected loss [$90,000]; chance with the control [5%], expected loss [$22,500]; reduction [$67,500]; control cost [$28,000 a year]; net [$39,500 a year]. Show it as a bar chart of the two expected-loss values with the cost beside it, and add one line with the break-even: the control pays if it cuts the chance by at least [6.2] percentage points. Change nothing else.

Prompt 3 · Board version in five slides

Make a 5-slide board version of this deck: 1) what changed since the last review; 2) top five residual risks against our appetite limits [food safety 4, supply 8, technology 9, growth 12], each with a trend; 3) the risk above appetite and its action; 4) the top risk in money; 5) decisions and the next review date. Move the method to the appendix. Keep every number.

How to build a risk management presentation in NOXI

NOXI builds the slides from your risk table: the register becomes the tables and charts on the slides, and you edit any slide by chat. It is free, with no card and no watermark; uploading files needs a free account, and a full deck uses about 25 of the 1,000 monthly credits.

Step 1: Attach your risk register

Choose Create from file and attach your risk register as an Excel or CSV file, up to 200 MB, with columns for risk, owner, inherent likelihood and impact, control, and residual likelihood and impact. Paste Prompt 1 so NOXI builds the 10 slides from your own scores.

Step 2: Review the outline first

Choose Plan mode to review the outline before generation. Check that slide 2 states your scales and bands, that the titles read as findings, and that the deck ends with decisions, then generate and watch each slide being built. With an attached file, web research is off by default, so the slides use your figures.

Step 3: Check every score against the register

Compare each likelihood, impact, score and amount with your spreadsheet. Edit table cells and chart numbers in NOXI, edit text right on the slide, or ask the AI in plain English or Arabic to correct a figure on one slide or across the whole deck.

Step 4: Make the matrix slide readable

Put your matrix on the slide as a table from your register, with the score printed in every cell. Click any element and tell the AI what to change, for example to shade the four bands in one colour from light to dark or to bold the risk still above appetite.

Step 5: Add the money slide and your brand

Paste Prompt 2 to add the expected-loss slide for your top risk, then add your logo and brand colour. Ask the AI to move the full register to appendix slides, and rehearse full-screen in present mode, timing yourself against the 10 minutes.

Step 6: Share, export and present

Share a view-only link for the pre-read, or invite the risk owners by email to edit together in real time. Download an editable PowerPoint (.pptx) with real text boxes and embedded fonts, or a PDF, or present full-screen from NOXI.

Frequently asked questions

What should a risk management presentation include?
A risk management presentation should include the objective at risk and the appetite, the scoring method, a matrix of the top risks, the top five with owners, scores before and after controls, the top risk in money, actions with owners and dates, what changed since the last review, and the decisions needed. The full register goes in the appendix.
How do you calculate a risk score?
Rate likelihood on a written 1–5 scale, ideally as a probability per year, and impact on a 1–5 scale in money, people or regulation. Multiply them: score = likelihood × impact, from 1 to 25. Record a one-line reason for each rating, and use the same scales for every risk and every review so scores stay comparable.
What is a 5x5 risk matrix?
A 5x5 risk matrix is a grid of five likelihood levels by five impact levels whose 25 cells hold scores from 1 to 25, grouped into bands such as low, medium, high and very high. Only 14 distinct scores can occur: 1, 2, 3, 4, 5, 6, 8, 9, 10, 12, 15, 16, 20 and 25.
What is the difference between a 3x3 and a 5x5 risk matrix?
A 3x3 risk matrix uses three levels each for likelihood and impact and produces six distinct scores, so it is quick and suits site checks, small projects and students. A 5x5 uses five levels each and produces 14 distinct scores, so it ranks larger registers and shows the effect of a control more clearly.
What is the difference between inherent and residual risk?
Inherent risk is the score of a risk before any controls, in the raw state of the activity. Residual risk is the score that remains after controls. For example, a supplier failure scored 4 × 4 = 16 can fall to 2 × 4 = 8 once a second supplier is qualified. Residual risk is compared with appetite.
What is a risk register?
A risk register is a list of an organisation's or project's identified risks, with each risk's cause, event and effect, owner, likelihood and impact scores before and after controls, the controls, open actions and review dates. It usually lives in a spreadsheet or risk system, and a presentation shows only its top rows.
What is the difference between a risk register and a risk management plan?
A risk management plan sets the rules: scoring scales, bands, risk appetite, roles and how often risks are reviewed. A risk register is the record those rules produce: every risk with its scores, controls and actions. In a presentation, the method slide summarises the plan and the register slide summarises the register.
What are the 5 steps of risk assessment?
The UK's Health and Safety Executive lists five steps: identify hazards, assess the risks, control the risks, record your findings, and review the controls. In the UK, an employer with five or more employees must record the significant findings. Other countries set their own rules, so check the regulator where you work.
How do you present risks to a board?
Present risks to a board by leading with what changed since the last meeting, then showing the top five residual risks against appetite with a trend marker for each. Name the decision you need per risk, accept, reduce, transfer or avoid, with its cost. Keep the scoring method on an appendix slide the board approved earlier.
Can AI make a risk management presentation from a risk register?
Yes. AI presentation tools can turn a risk register spreadsheet into a structured deck with tables, charts and full-sentence titles. Give the tool your own scores and amounts and tell it to invent none, put the matrix on the slide as a table from your data, then check every score against the register before the meeting.

Sources & methodology

How this guide was made: every world fact comes from the publisher's own page (HSE, NIST, ISO, the UK Orange Book, WEF, the European Commission, FDA). We computed the 14 distinct scores of a 5×5 matrix (and the 6 of a 3×3) by listing every cell. The 10-slide template, timings, scales, bands, appetite statements, impact-5 rule and checklist are editorial recommendations, not published standards. Kestrel Foods and all its figures are fictional; every calculation was checked twice. All sources were checked on 21 October 2026.
