Disclosure: NOXI publishes this guide and is one of the tools it mentions; the method works in any presentation software.
Quick answer: A project proposal presentation asks a decision-maker to approve a project. Use 10 slides in 10 minutes, plus 5 minutes of questions: the decision you need, the problem in one number, three options, scope, plan, budget with contingency, benefits and payback, risks, success measures, and the ask again. Put the decision, the amount and the date on slide one.
Most project proposal templates are a cover, an "about the project" slide and a Gantt chart. A committee approves budget, not intentions, so the deck must answer three questions fast: what you want, what it costs, and why this option beats doing nothing or doing less. Below: the 10-slide template with timings, the options and budget arithmetic, student and client versions, and a fictional dental group, Brightwater, worked through in full.
In short
- The rulePut the decision, the money and the date on slide one. Spend the rest of the deck proving the recommended option beats doing nothing and the cheapest option.
- Length10 slides in 10 minutes, plus 5 minutes of questions. Detail goes in the written proposal and the appendix.
- Options slideDo nothing, minimum, recommended, each with year-1 cost, monthly benefit and year-1 net, built with the same rules.
- Budget slideLine items, a stated contingency (we use 10% for a small, well-understood project), the total, and payback with its formula.
- Worked exampleBrightwater Dental Group asks for $27,641 for online booking and reminders: $47,479 year-1 net, payback in 2.1 months.
- VersionsThe same spine works for a course project (problem, objectives, method, timeline, expected outcomes) and a client or RFP proposal.
Key numbers
All six come from PMI's 16th Pulse of the Profession report (May 2026), which measures project delivery.
What is a project proposal presentation?
A project proposal presentation is a short slide talk that asks a decision-maker (a manager, a steering group, a budget committee, a client or a course examiner) to approve a project, its budget and its start date. It argues for one recommended option and gives the cost, the benefit, the plan and the risks needed to say yes.
Three groups build this deck: employees asking for budget and people, often as a new budget year opens; students presenting a course or final-year project; and agencies presenting to a client or in a tender. The spine is the same; what changes is who decides and what they score.
Proposal presentation vs proposal deck
A proposal presentation is the talk; a proposal deck is the file. The same deck is usually presented and sent ahead as a pre-read, so every slide title should be a full sentence that works without you in the room ("Online booking cuts no-shows from 9% to 7.5%"), not a label ("Benefits").
A project proposal is not a business case: a business case argues that an investment is worth making, with a full appraisal; a proposal asks to start a specific project with a specific budget. For the full appraisal, use our business case presentation guide; this page covers the shorter approval deck.
What to include in a project proposal presentation (and what stays in the written proposal)
A project proposal presentation includes ten things: the decision requested, the problem in one number, the options, the recommended scope, the plan, the budget, the benefits and payback, the risks, the success measures and the ask. Everything else (method detail, vendor comparisons, full risk register, assumptions) stays in the written proposal or the appendix.
| Item | On the slides | In the written proposal or appendix |
|---|---|---|
| Decision | What, how much, by when, in one sentence | Approval route and who signs |
| Problem | One number with its arithmetic | Data source, period, method |
| Options | Three rows: cost, benefit, net | Every option looked at, and why most were dropped |
| Scope | In and out, 3 to 5 items each | Detailed requirements |
| Plan | 4 to 6 dated milestones | Full schedule and dependencies |
| Budget | Line items, contingency, total, payback | Quotes, rates, assumptions register |
| Risks | Top three, each with an owner and a response | Full risk register |
| Measures | 3 measures: baseline, target, date | Data collection method |
Project proposal outline
A project proposal outline is the order of sections in the written document, and the deck follows it: summary and request, background and problem, objectives, options, recommended solution and scope, plan and milestones, budget, benefits, risks, measures and governance, then appendices. Write the outline first, so the deck summarises a document instead of squeezing one onto slides.
Project proposal format
A workable project proposal format is a short written document with the sections above, plus a deck of about 10 slides for the meeting, sent ahead as a PDF pre-read. If your organisation or course has its own template or rubric, map the ten items onto its headings and keep its order, because reviewers score against their own list.

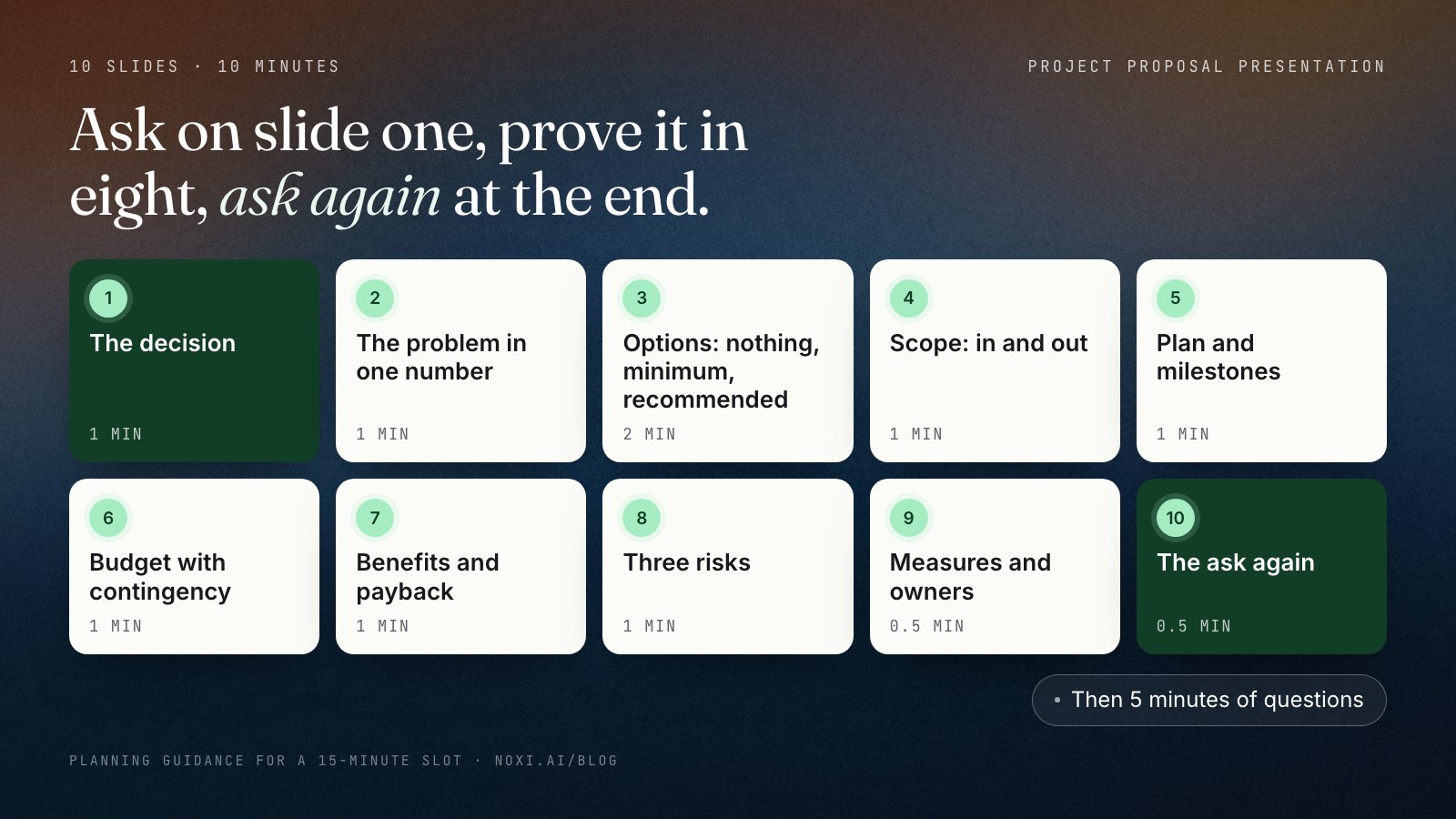

The 10-slide project proposal presentation template
The 10-slide project proposal template runs 10 minutes: decision, problem, options, scope, plan, budget, benefits and payback, risks, measures and governance, and the ask. The options slide gets the most time, because it is where the decision is actually made.
| # | Slide | What goes on it | Minutes |
|---|---|---|---|
| 1 | The decision | What you are asking for, how much, by when, and who decides | 1 |
| 2 | The problem | One number, calculated in front of the reader, and what it costs per month or year | 1 |
| 3 | Options | Do nothing, minimum, recommended: year-1 cost, monthly benefit, year-1 net | 2 |
| 4 | Scope | What is in and what is out of the recommended option | 1 |
| 5 | Plan and milestones | 4 to 6 dated milestones from approval to full benefit | 1 |
| 6 | Budget | Line items with arithmetic, contingency, total | 1 |
| 7 | Benefits and payback | Monthly benefit by source, payback with its formula | 1 |
| 8 | Risks | Three risks, each with an owner, a response and a trigger | 1 |
| 9 | Measures and governance | Three measures with baselines and targets; sponsor, owner, review dates | 0.5 |
| 10 | The ask | The decision again, plus the next three steps with dates | 0.5 |
| Total | 10 slides | 1 + 1 + 2 + 1 + 1 + 1 + 1 + 1 + 0.5 + 0.5 | 10 |
The timings are our planning guidance, not a standard, for a 15-minute slot: 10 minutes of talk and 5 of questions. With a 30-minute slot, keep 10 slides and give the extra time to questions.

Project proposal PPT: setting up the file
To build a project proposal PPT, create ten slides in PowerPoint or Google Slides, rewrite each row's slide name as a finding for your project, and give each slide one table, chart or short list. Right-align numbers in tables and put appendix slides after slide 10.
How many slides for a project proposal?
A project proposal presentation needs about 10 slides for a 10-minute talk, roughly one slide a minute. Fewer than 7 usually means the options or the budget were skipped; more than 15 usually means detail from the written proposal moved onto slides.
How long should a proposal presentation be?
A proposal presentation should be 10 to 15 minutes of talk plus 5 to 10 minutes of questions, unless your organisation or course sets the slot. Course rules vary: the final-year project guideline at Universiti Kebangsaan Malaysia's computing faculty gives 20 minutes including questions, with slides that fit within 15 minutes (UKM FTSM guideline), and a University of Texas at Austin course asks for 10 to 12 minutes followed by 5 minutes of questions (UT Austin CS378). In a tender, the buyer sets the time limit in the solicitation.
Slide 1: the decision slide (what, how much, by when)
The decision slide states, in one sentence, what you want approved, how much it costs and when it starts. A reader who sees only slide one should know exactly what they are being asked to sign.
Most proposals explain the project for eight slides and ask for the money on the ninth. The committee spends those eight slides guessing the price. Name the ask first and the same slides become evidence for a known decision.
| Part | Weak | Strong |
|---|---|---|
| Title | Project proposal: online booking | Approve $27,641 for online booking and reminder texts across 6 clinics |
| What | Modernise patient scheduling | Online booking plus automatic reminder texts; phone booking stays |
| How much | Budget to be confirmed | $27,641 in year 1, including a 10% contingency of $2,513 |
| By when | Q1 next year | Pilot at 2 clinics from 1 March 2027; all 6 live on 3 May 2027 |
| Why it's worth it | Improves patient experience | $6,260 a month of benefit; pays back in 2.1 months |
Add one line naming who decides and who owns delivery. A vague amount ("about $25k–35k") invites the committee to approve the low end or defer; ask for one number with the contingency inside it. When members decide at an annual general meeting, the same slides support a resolution; see our AGM presentation guide.
The problem slide: one number, calculated in front of the reader
The problem slide gives one number that shows what the current situation costs, with the arithmetic on the slide so nobody has to trust it. One number with its source beats five bullet points of pain.
Name the source ("practice management system, January to December 2026") and use a 12-month window so a seasonal peak does not inflate the problem. Every benefit later in the deck is a change to this number, so get it right first.

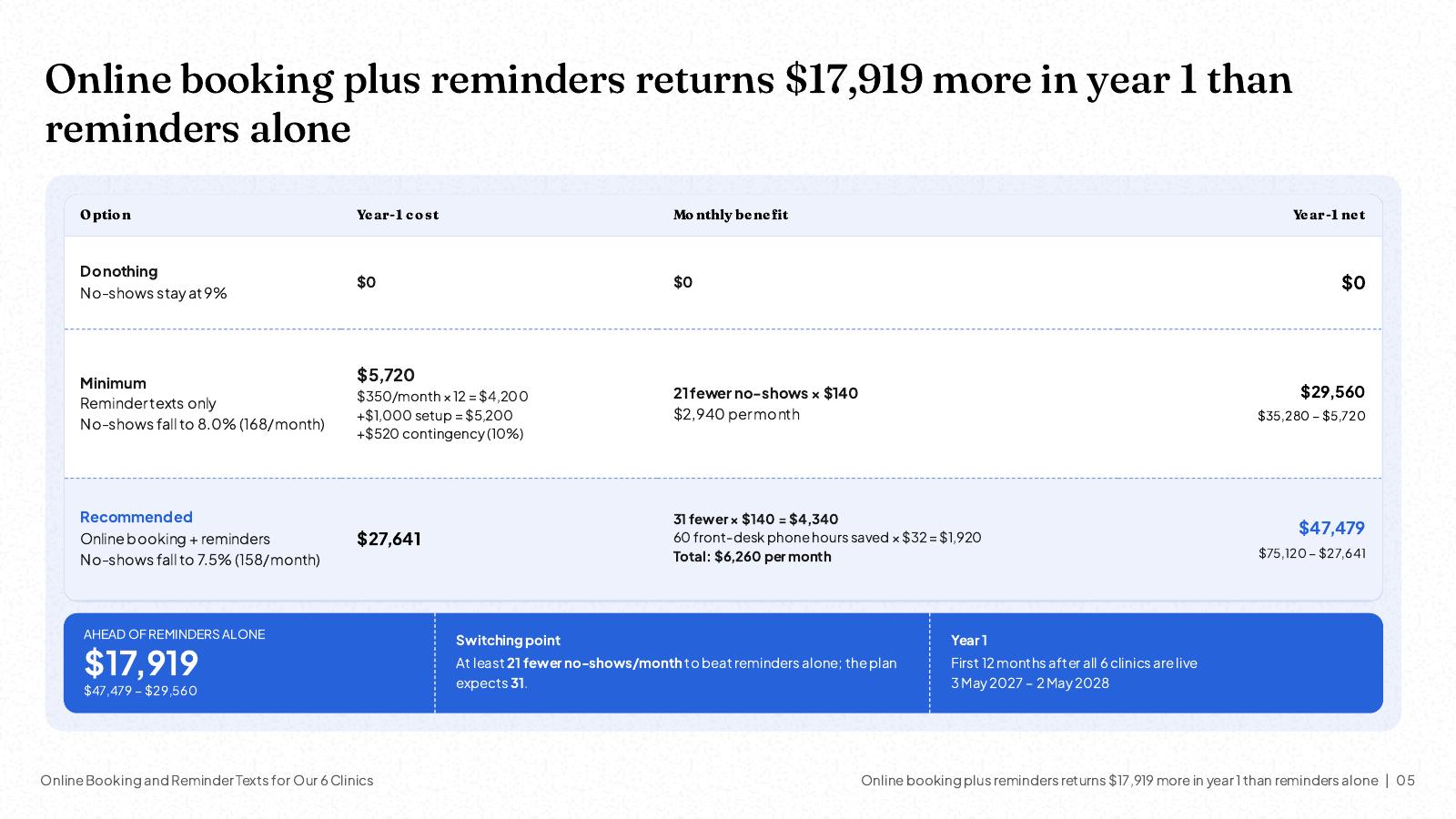

Options: do nothing, minimum, recommended
The options slide compares three choices with the same rules: do nothing, the cheapest option that helps, and the recommended option. Each row shows year-1 cost, monthly benefit and year-1 net, so the committee can see why the recommendation wins and what it would get for less.
Do nothing is the baseline, with a real cost: the problem number. The minimum option matters most, because a cautious committee will try to approve it instead; if you cannot show why the recommendation beats it, the committee is right to choose it.
| Option | Year-1 cost | Monthly benefit | Year-1 net |
|---|---|---|---|
| Do nothing | $0 | $0; no-shows stay at 9%, 189 a month, $26,460 a month lost | $0 (baseline) |
| Minimum: reminder texts only | $350 × 12 = $4,200 + $1,000 setup = $5,200; + 10% contingency $520 = $5,720 | No-shows to 8.0%: 2,100 × 0.08 = 168, so 21 fewer × $140 = $2,940 | 2,940 × 12 − 5,720 = 35,280 − 5,720 = $29,560 |
| Recommended: online booking + reminders | $17,400 + $6,000 + $1,728 = $25,128; + 10% contingency $2,513 = $27,641 | No-shows to 7.5%: 2,100 × 0.075 = 157.5, counted as 158, so 31 fewer × $140 = $4,340; + 60 phone hours × $32 = $1,920; $6,260 | 6,260 × 12 − 27,641 = 75,120 − 27,641 = $47,479 |
Year 1 means the first 12 months after all six clinics are live (3 May 2027 to 2 May 2028). The same 10% contingency is applied to both paid options; leaving it off the cheaper one would flatter it. The recommended option beats the minimum on year-1 net by 47,479 − 29,560 = $17,919.

Show the switching point
A switching point is the result at which the decision would flip. For Brightwater: (29,560 + 27,641) ÷ 12 = $4,766.75 of monthly benefit is needed to match the minimum; minus $1,920 of phone time leaves $2,846.75; ÷ $140 = 20.3 appointments. So the recommended option must cut at least 21 no-shows a month, the same as reminders alone, to be worth its extra cost; the plan expects 31. Put that line under the table; it answers the sharpest question before it is asked.
Scope: what is in and what is out
The scope slide lists what the recommended option includes and, just as clearly, what it does not. A visible "out" column is the cheapest protection against scope creep, because the committee approves the boundary along with the budget.
| In scope | Out of scope (and why) |
|---|---|
| Online booking on the website for all 6 clinics | A patient mobile app: a separate decision after 6 months of booking data |
| Reminder texts 48 hours and 2 hours before each appointment | Changes to billing or payment collection |
| Training for 18 front-desk staff, 3 hours each | Changes to clinical records |
| Phone booking kept for patients who prefer it | Closing or reducing phone lines |
Write each "out" item as a decision with a reason, so the committee sees you considered it. Once approved, the scope table becomes slide one of the delivery plan; our project kickoff presentation guide uses the same in, out and later format for the first team meeting.
Plan and milestones: four to six dates from approval to benefit
The plan slide shows four to six dated milestones from the approval meeting to the date the benefits start. The committee needs to know when money is spent and when results arrive, not every task.
| Date | Milestone | Owner |
|---|---|---|
| 26 Jan 2027 | Operations committee approves the proposal | Chief Operating Officer |
| 15 Feb 2027 | Vendor contract signed, with a go-live date in the contract | Practice Systems Manager |
| 1 Mar–30 Apr 2027 | Pilot at 2 clinics; all 18 front-desk staff trained by 30 April | Practice Systems Manager |
| 3 May 2027 | All 6 clinics live; year 1 starts | Clinic managers |
| 15 Jun 2027 | First results at the operations review, then monthly | Practice Systems Manager |
| 31 Aug 2027 | Targets due: no-shows at 7.5%, 40% of bookings online | Chief Operating Officer |
The pilot is the plan's main risk control: two clinics for two months, then a go or no-go before the other four join. Keep any Gantt chart for the appendix.
How to present a budget proposal: line items, contingency and payback
Present a budget proposal as line items with their arithmetic, a stated contingency, one total and the payback period with its formula. The committee should be able to recompute every figure from the slide without opening the spreadsheet.
| Line | Arithmetic | Year-1 cost |
|---|---|---|
| Software subscription | $1,450 a month × 12 | $17,400 |
| Setup and two-clinic pilot | Vendor quote, one-off | $6,000 |
| Staff training | 18 staff × 3 hours × $32 an hour | $1,728 |
| Subtotal | 17,400 + 6,000 + 1,728 | $25,128 |
| Contingency | 10% × 25,128 = 2,512.80, rounded | $2,513 |
| Total requested | 25,128 + 2,513 | $27,641 |
How much contingency to include
Contingency is money inside the budget for risks you have identified but cannot price exactly. We use 10% of the base estimate for a small project with a known vendor and a fixed quote, and 15% to 25% when the scope, the vendor or the technology is new. That range is our planning guidance, not a published rule; your finance team may set its own. Whatever you use, show it as its own line and say who can release it.
Benefits and payback
Benefits go on their own slide, split by source, so the committee can challenge each one. Brightwater has two: recovered appointments, 31 a month × $140 = $4,340, and front-desk time, 6 clinics × 25 hours × 40% moved online = 60 hours × $32 = $1,920. Together: $6,260 a month.
Brightwater's one-off costs are setup, training and the contingency: 6,000 + 1,728 + 2,513 = $10,241. The monthly net benefit is the benefit minus the subscription: 6,260 − 1,450 = $4,810. Payback is 10,241 ÷ 4,810 = 2.13, so about 2.1 months after go-live, in early July 2027. After 12 months the cumulative net is −10,241 + 4,810 × 12 = $47,479, the same year-1 net as the options table.

What a finance reviewer will ask
Expect three questions: what if the result is lower, what if only cash counts, and what if the whole budget is treated as upfront. Answer them in a small table; each one moves the payback, and the cash-only case also tests the recommendation itself.
| Case | Arithmetic | Payback |
|---|---|---|
| Base case | 10,241 ÷ (6,260 − 1,450) | 2.1 months |
| Lower result: no-shows only to 8.0% | Benefit 2,940 + 1,920 = 4,860; 10,241 ÷ (4,860 − 1,450) = 10,241 ÷ 3,410 | 3.0 months; year-1 net $30,679 |
| Cash only: phone time not counted | 10,241 ÷ (4,340 − 1,450) = 10,241 ÷ 2,890 | 3.5 months; year-1 net $24,439 |
| Whole year-1 budget as upfront | 27,641 ÷ 6,260 | 4.4 months |
In the lower-result case the recommended option still beats the minimum by 30,679 − 29,560 = $1,119 in year 1. In the cash-only case it does not: 4,340 × 12 − 27,641 = $24,439, which is $5,121 below the minimum's $29,560. Phone time is staff time freed, not cash saved, unless hours are cut, so the case rests on valuing those 60 hours; say so and let the committee decide. For net present value and full sensitivity analysis, the business case guide shows the method.
Risks: three, each with an owner, a response and a trigger
The risk slide names the three risks most likely to change the result, and gives each an owner, a response and a trigger that says when you will act. Three specific risks are more credible than a register of twenty.
| Risk | Response | Trigger | Owner |
|---|---|---|---|
| Patients over 70 prefer the phone | Phone booking stays; reminder texts go to everyone with a mobile number | Online share below 25% at the June review | Clinic managers |
| Vendor delay | Two-clinic pilot first; go-live date written into the contract | Pilot not live by 8 March 2027 | Practice Systems Manager |
| Front desks keep booking by phone out of habit | One trained champion per clinic; online share reported by clinic each month | Any clinic below 30% online in July | Clinic managers |
Choose risks that touch the numbers on the benefits slide. PMI's 2026 Pulse report found only about one in five practitioners use scenario planning (PMI, 12 May 2026). A trigger column is a light version: it says in advance which result makes you change course.
Success measures and governance: baseline, target, date, owner
The measures slide shows three numbers that will prove the project worked, each with today's baseline, a target and a date, plus who reports them and when. It turns the approval into a promise the committee can check.
| Measure | Baseline (2026) | Target | By |
|---|---|---|---|
| No-show rate | 9.0% (189 a month) | 7.5% (158 a month) | 31 Aug 2027 |
| Bookings made online | 0% | 40% | 31 Aug 2027 |
| Front-desk phone booking hours | 150 hours a month (6 × 25) | 90 hours a month (−60) | 31 Aug 2027 |
Governance fits in one line: sponsor (Chief Operating Officer), owner (Practice Systems Manager), first report at the 15 June 2027 operations review, then monthly. PMI's 2026 report found sponsor alignment at initiation in 39% of high performers against 30% of low performers (PMI, 12 May 2026); naming the sponsor and the measures on the proposal is where that alignment starts. For the monthly report after approval, our project status report presentation guide has the RAG rules and the one-slide format.
Project proposal presentation example: Brightwater Dental Group, slide by slide
Brightwater's proposal is 10 slides in 10 minutes, presented by the Practice Systems Manager to the operations committee on 26 January 2027, with the pre-read sent on 19 January. Every title is a full-sentence finding.
- Approve $27,641 for online booking and reminder texts across our 6 clinics (1:00): pilot at 2 clinics from 1 March 2027, all 6 live on 3 May 2027; decision today by the operations committee.
- No-shows cost us $26,460 a month (1:00): 9% of 2,100 appointments, 189 a month, × $140; $317,520 a year in 2026.

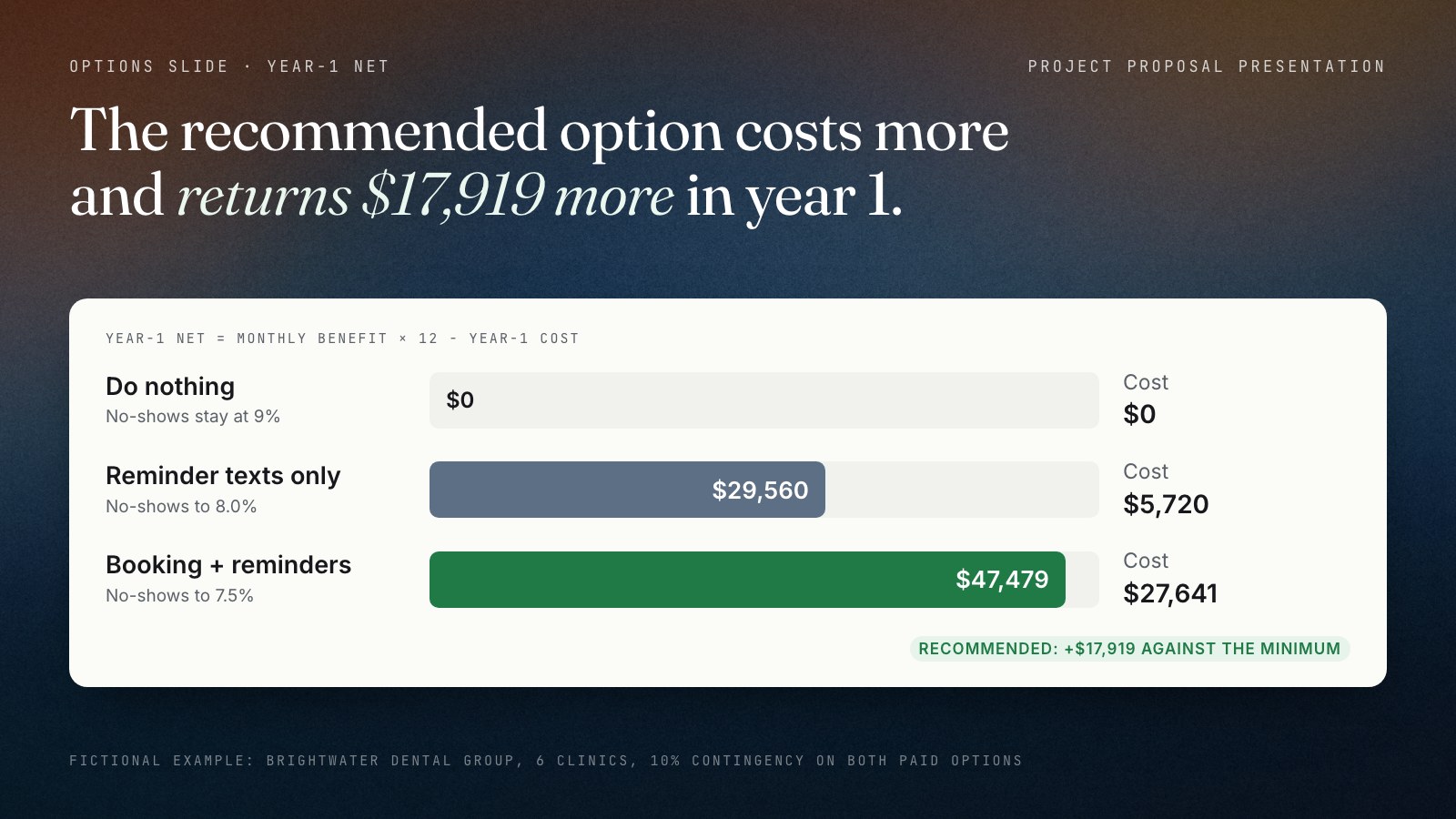

- Online booking plus reminders returns $17,919 more in year 1 than reminders alone (2:00): do nothing $0; reminders only $5,720 cost, $29,560 net; recommended $27,641 cost, $47,479 net.
- We add online booking and reminders, and keep the phone (1:00): in: booking, texts, training; out: patient app, billing, clinical records.
- Two clinics pilot in March and April; all six are live on 3 May (1:00): contract 15 February; all staff trained by 30 April; first results 15 June.

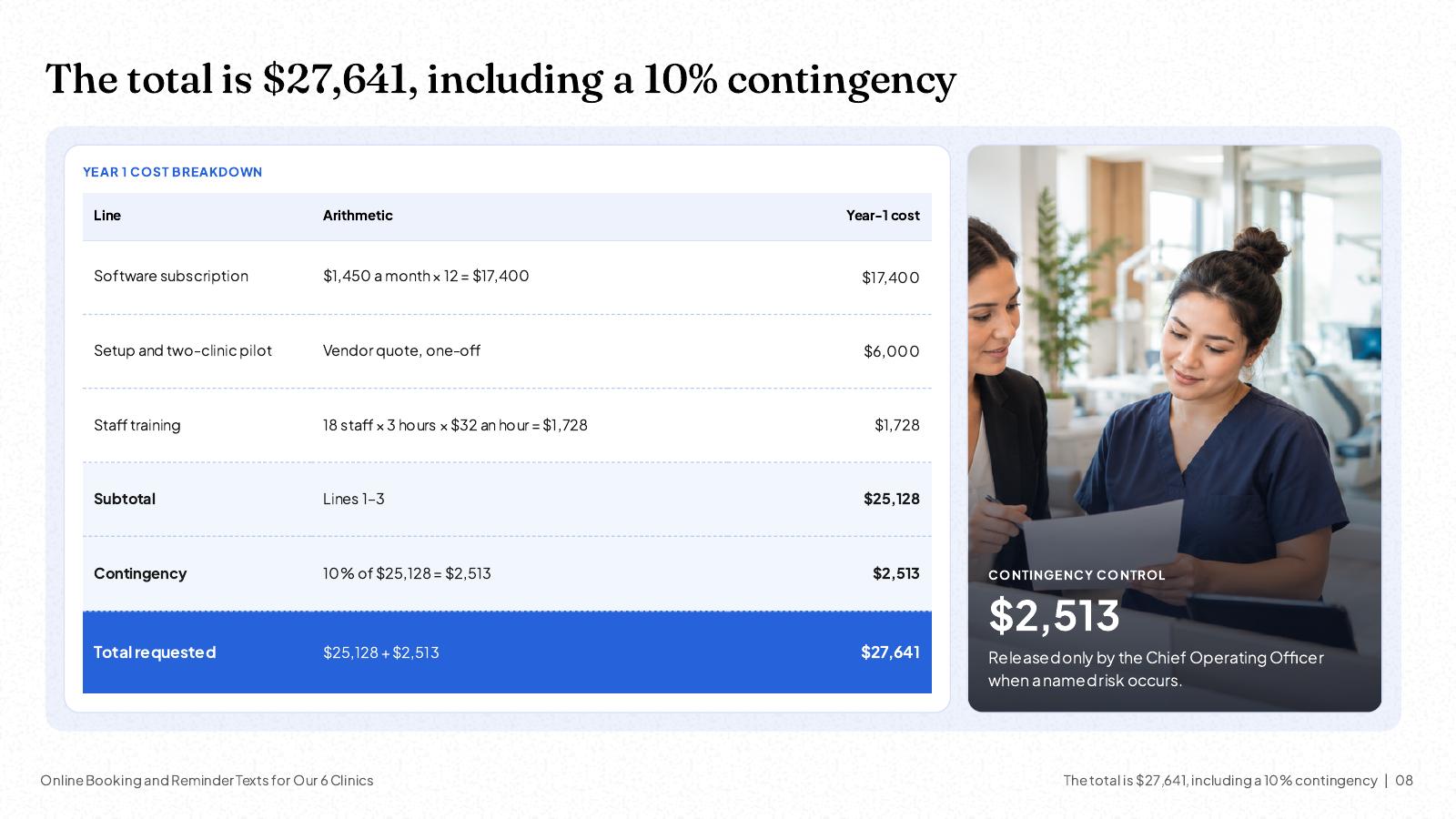

- The total is $27,641, including a 10% contingency (1:00): software $17,400; setup and pilot $6,000; training $1,728; contingency $2,513.

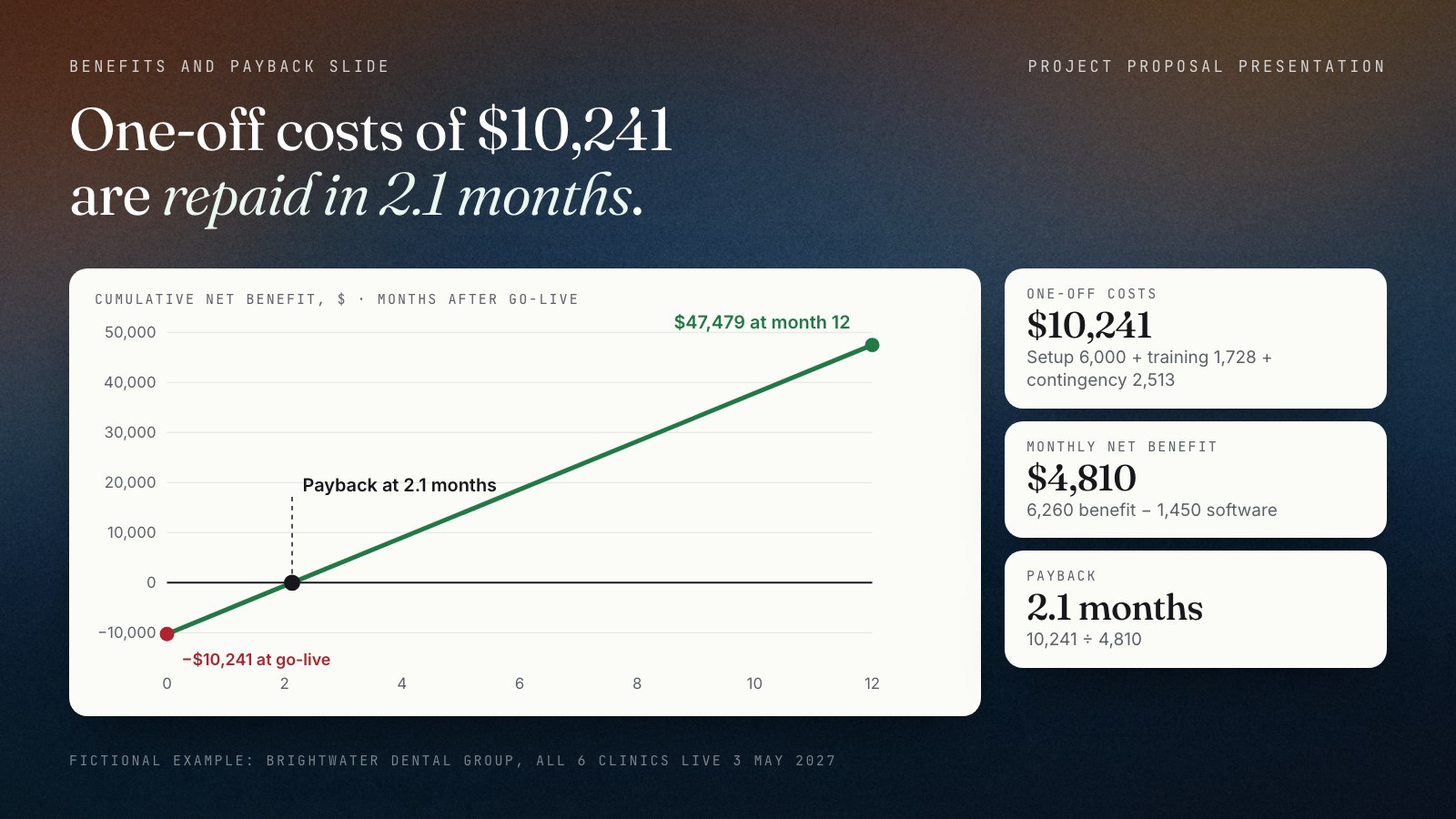

- The project pays back in 2.1 months (1:00): $4,340 recovered appointments + $1,920 front-desk time = $6,260 a month; one-off costs $10,241 ÷ $4,810 monthly net.
- Three risks, each with a trigger and an owner (1:00): older patients prefer the phone; vendor delay; booking habits at the front desk.
- Three numbers will show it worked by 31 August 2027 (0:30): no-shows 7.5%, 40% online, 60 fewer phone hours a month; monthly report from 15 June.
- Approve $27,641 today so the vendor contract can be signed by 15 February (0:30): sponsor Chief Operating Officer; owner Practice Systems Manager; then questions.
The times add up: 1 + 1 + 2 + 1 + 1 + 1 + 1 + 1 + 0.5 + 0.5 = 10 minutes. The appendix holds the vendor quote, the no-show data by clinic and month, and the lower-result payback table.
Here are two slides from this article's worked example, as NOXI built them, unedited.


How to make a project proposal presentation: 7 steps from written proposal to deck
To make a project proposal presentation, write the decision sentence first, build the numbers in a spreadsheet, then turn each section of the written proposal into one slide with a full-sentence title.
- Write the decision sentence. If you can't write it, the proposal isn't ready.
- Price the problem. One number with a unit, a period and a source.
- Build the options in a spreadsheet. Do nothing, minimum, recommended, with the same contingency and the same year-1 window for each.
- Draft the ten titles. Read them in order without the slide bodies; they should tell the whole argument.
- Give each slide one table, chart or list. The rest goes to the appendix.
- Recompute every number from the slides alone. If a reviewer can't, add the arithmetic.
- Send a pre-read and brief the sponsor first, so they never see the ask for the first time in front of the committee.
How to present a project proposal in the room
To present a project proposal, say the decision in your first sentence, spend the most time on the options slide, finish on time, and end by repeating the ask with the next step and its date. Leave at least a third of the slot for questions.
- Open with the ask. "I'm asking you to approve $27,641 today so we can sign the vendor contract by 15 February." Then: "Here's why it's worth it."
- Don't reread the pre-read. Point to the one number on each slide and move on.
- Stay on the options slide. Invite the challenge: "Why not reminders alone? Here's the difference."
- Answer from the appendix: 4 to 6 backup slides for the questions you expect.
- Close on the decision. Repeat the amount and the date, then stop. If the answer is "not today", ask what would make it yes.
- Send a one-paragraph decision note the same day: what was approved, the amount, conditions, next review date.
Project proposal presentation example for students
A student project proposal presentation follows the course rubric, usually problem, objectives, method, timeline and expected outcomes; add a small budget and the risks even if not required. Examiners score whether the plan is feasible in the time you have.
Course guidelines name the content. UKM's computing faculty lists project introduction, problems, objectives, suggested solutions with designs and specifications, a prototype demonstration if any, and a conclusion, and says the examiner will also assess how well students answer questions (UKM FTSM guideline). UT Austin's course asks students to spend about half the talk on problem formulation and technical approach (UT Austin CS378).
| # | Student slide | Leak-sensor example | Minutes |
|---|---|---|---|
| 1 | Title and the one-line proposal | A sensor network that alerts facilities to leaks within 15 minutes | 0.5 |
| 2 | Problem | Leaks found by staff, often after damage; one measured example from the building | 1.5 |
| 3 | Objectives | 3 measurable objectives, e.g. alert within 15 minutes, battery life above 6 months | 1 |
| 4 | Related work or existing solutions | Two to three existing systems and what each misses | 1.5 |
| 5 | Method or proposed design | Sensors, gateway, alert logic, test plan | 3 |
| 6 | Timeline | 12 weeks: build weeks 1 to 6, install 7 to 8, test 9 to 11, report 12 | 1 |
| 7 | Budget and resources | $552 + $55.20 contingency = $607.20; lab access; facilities contact | 0.5 |
| 8 | Risks | Wi-Fi coverage in the basement; sensor delivery time | 0.5 |
| 9 | Expected outcomes | Alert time measured at all 24 locations; working prototype; report | 0.5 |
| Total | 9 slides | 0.5 + 1.5 + 1 + 1.5 + 3 + 1 + 0.5 + 0.5 + 0.5 | 10 |
Problem, objectives and method take 1.5 + 1 + 3 = 5.5 of the 10 minutes, about half. For the end-of-project talk, our capstone project presentation guide has the deck and rubric. For a research study, with literature, method and ethics slides, use the research proposal presentation guide instead.
Business proposal presentation for a client, RFP orals and grant panels
A business proposal presentation to a client keeps the same spine but changes the voice: the problem is the client's in their words, the options become ways of working with you, and the budget becomes your price and terms. The decision slide still comes first.
| Internal slide | Client version |
|---|---|
| The decision | Our recommendation and the price |
| The problem | Your situation, in your numbers |
| Options | Two or three scopes at different prices |
| Plan | Phases, dates, what we need from you |
| Team | The named people who will do the work |
| Proof | Two relevant results with numbers |
| The ask | Price, terms, start date, what happens next |
For the sales side (discovery, objection handling, follow-up), our sales deck guide covers the deck around the proposal.
RFP presentation (orals)
An RFP presentation, often called "orals", is a presentation a bidder gives to the buyer's evaluation panel during a formal tender, usually to shortlisted bidders. The buyer sets the topics, time limit and rules, and the panel scores it against stated evaluation factors, so build the deck in the order of those factors.
In US federal contracting, FAR 15.102 (version effective 13 March 2026) lets the government use oral presentations in place of or alongside written proposal material, names suitable topics such as capability, past performance, work plans and staffing, and requires the solicitation to give bidders enough information to prepare, which may include the time allowed for each presentation. Anything the parties intend as contract terms must still be put in writing (FAR 15.102, Oral presentations). For any tender: answer the evaluation factors by name, bring the people named in the bid, and promise nothing the written proposal does not say.
Grant proposal presentation
A grant proposal presentation pitches a funded project to a panel and follows the funder's criteria: need, outcomes, method, budget and capacity to deliver. Lead with the amount requested and the outcome it buys, show cost per outcome, and stay inside the funder's time limit. Our nonprofit fundraising presentation guide covers the donor and foundation versions in full.
Pass/fail checklist before you present a project proposal
Run this check before you send the pre-read. Each line passes only if the stated condition is true.
- Slide one states the decision.What, one amount, a start date and who decides, in one sentence.
- The problem has a number.A unit, a 12-month period and a named source, with the arithmetic shown.
- Three options are compared on the same rules.Do nothing, minimum, recommended; the same contingency and the same year-1 window for each.
- Scope has an "out" column.At least three exclusions, each written as a decision.
- The plan has dates and owners.4 to 6 milestones, from approval to the date benefits start.
- The budget adds up.Line items with arithmetic, contingency as its own line, one total that matches slide one.
- Payback has its formula.One-off costs ÷ monthly net benefit, plus a lower-result case.
- Each risk has a trigger.Three risks with a response, a trigger and an owner.
- Measures have baselines.Three measures, each with a baseline, a target and a date.
- It fits the slot.Rehearsed at or under 10 minutes, leaving a third of the slot for questions.
3 AI prompts for a project proposal presentation
Use them in NOXI after attaching your written proposal and budget spreadsheet, or in any AI tool that accepts files. Replace the brackets; the tool should arrange your facts, never invent them.
Create a 10-slide project proposal presentation for the [operations committee], 10 minutes, from the attached [written proposal (Word)] and [budget and options sheet (Excel)]. Slide 1: the decision, [approve $27,641 for online booking and reminders across 6 clinics; pilot from 1 March 2027]. Then: the problem in one number [$26,460 a month of no-shows]; three options (do nothing, minimum, recommended) with year-1 cost, monthly benefit and year-1 net; scope in and out; 5 dated milestones; budget with a 10% contingency line; benefits and payback with the formula; three risks with triggers and owners; three measures with baselines and targets; the ask again with next steps. Use every number exactly as in the files and invent none. Titles as full-sentence findings.
On the benefits and payback slide, add a small table with four rows: base case, lower result [no-shows only to 8.0%], cash only [phone time not counted] and whole year-1 budget as upfront, each with its arithmetic and payback in months, using the figures in the attached [budget sheet]. Keep the payback line chart. Retitle the slide to state the base-case payback and the slowest case. Change nothing else.
Create a 9-slide project proposal presentation for my [final-year engineering] course, 10 minutes, from the attached [course brief and rubric (PDF)] and [project proposal draft (Word)]. Follow the rubric's headings in order: problem, objectives, related work, method, timeline, budget, risks and expected outcomes. Give the method slide the most space. Use my numbers exactly [budget $607.20 including $55.20 contingency; 12 weeks; 24 sensor locations] and add nothing I did not write.
How to build a project proposal presentation in NOXI
NOXI turns your written proposal and budget spreadsheet into a structured deck with charts from your data. It is free, with no card and no watermark; uploading files needs a free account, and a full deck uses about 25 of the 1,000 monthly credits.
Step 1: Attach your proposal and your budget sheet
Choose Create from file and attach your written proposal as Word or PDF and your options and budget sheet as an Excel or CSV file, up to 200 MB each. Paste Prompt 1 so NOXI builds the 10 slides from your own numbers.
Step 2: Review the outline first
Choose Plan mode to review the outline before generation. Check that slide one states the decision with one amount and a date, that the ten titles read as findings, and that the ask closes the deck, then generate and watch each slide being built.
Step 3: Check every number against your spreadsheet
Compare each cost, benefit, date and payback figure with your sheet. Edit text on the slide, edit table cells and chart numbers in NOXI, or ask the AI in plain English or Arabic to correct a figure on one slide or across the whole deck.
Step 4: Add your logo and brand colour
Add your logo and brand colour so the deck looks like your organisation's own. Click any element and tell the AI what to change, for example to bold the recommended row of the options table or enlarge the total on the budget slide.
Step 5: Tighten the deck to the time slot
Paste Prompt 2 to add the finance reviewer's cases to the payback slide, then ask the AI to shorten any slide that takes more than its minute and to move supporting detail to appendix slides after the ask. Rehearse in present mode with a timer.
Step 6: Share, export and present
Share a view-only link with the sponsor for the pre-read, or invite a colleague by email to edit together in real time. Download an editable PowerPoint (.pptx) with real text boxes and embedded fonts, or a PDF, or present full-screen from NOXI.
Frequently asked questions
- What should be included in a project proposal presentation?
- A project proposal presentation should include the decision you need, the problem in one number, three options compared on the same rules, the recommended scope, a dated plan, a budget with contingency, benefits and payback, three risks with owners, success measures with baselines, and the ask repeated at the end. Detailed requirements and quotes go in the appendix.
- How do you present a project proposal?
- Present a project proposal by stating the decision, the amount and the date in your first sentence. Show the problem as one number, then compare doing nothing, a minimum option and your recommendation. Spend the most time on that comparison, finish within your slot, leave a third of it for questions, and end by repeating the ask.
- How many slides should a project proposal presentation have?
- A project proposal presentation should have about 10 slides for a 10-minute talk: decision, problem, options, scope, plan, budget, benefits and payback, risks, measures, and the ask. Fewer than 7 usually means options or budget are missing. Put backup material, such as quotes and detailed schedules, on appendix slides after the ask.
- How long should a proposal presentation be?
- A proposal presentation should usually run 10 to 15 minutes, followed by 5 to 10 minutes of questions, unless the organisation, course or tender sets the slot. Universities vary: one Malaysian faculty allows 20 minutes including questions, and one US course asks for 10 to 12 minutes plus 5 of questions. Rehearse under the limit.
- What is the difference between a project proposal and a business case?
- A project proposal asks to start a specific project with a specific budget, scope and date. A business case argues that an investment is worth making, usually with a full options appraisal, net present value and sensitivity analysis. Large investments often need a business case first; the project proposal then requests approval to deliver.
- How do you present a budget in a proposal?
- Present a budget in a proposal as line items with their arithmetic, a separate contingency line, one total that matches the amount on slide one, and the payback period with its formula. Add a small table showing how payback changes if results come in lower, so the finance reviewer's main question is answered on the slide.
- How much contingency should a project budget include?
- As a planning guide, include about 10% contingency for a small project with a known vendor and fixed quotes, and 15% to 25% when the scope, vendor or technology is new. These ranges are rules of thumb rather than a standard. Show contingency as its own line and say who can release it.
- How do you present a project proposal as a student?
- Follow your course rubric's headings in order, typically problem, objectives, related work, method, timeline and expected outcomes, and give the method the most time. Add a small budget with contingency and two or three risks even if not required. Keep to the time limit and prepare backup slides for the examiner's questions.
- What is an RFP presentation?
- An RFP presentation, often called orals, is a presentation a bidder gives to a buyer's evaluation panel during a formal tender. The buyer sets the topics, time limit and scoring factors in the solicitation. Build the deck in the order of those factors, bring the people named in the bid, and promise nothing your written proposal does not say.
- Can AI make a project proposal presentation from my document?
- Yes. AI presentation tools can turn a written proposal and a budget spreadsheet into a structured deck, write full-sentence titles and lay out the options table and charts. Give the tool your own numbers and tell it to invent none, then recompute every cost, benefit and date against your spreadsheet before anyone sees the deck.
Sources & methodology
How this guide was made: the PMI figures come from PMI's own report page and press release, the tender rule from the official FAR text, and the course timings from the universities' own guidelines. The 10-slide template, timings, options rules, contingency ranges, payback cases, student and client versions and checklist are editorial recommendations, not published standards. Brightwater Dental Group, the student team and all their figures are fictional; every calculation was checked twice. All sources were checked on 20 October 2026.
- [1] 16th edition of Pulse of the Profession, released 12 May 2026; 31% of complex projects fail to achieve the full scope of intended benefits; 97% managed at least one complex project in the past year; five times more likely to succeed, 88% against 14%; 81% say projects became more complex; sponsor alignment at initiation 39% against 30%; about one in five use scenario planning; 72% success with frameworks against 61% without — PMI, Why Complex Projects Fail: Best Practices Are Not Enough, System Thinking Gives Your Team the Edge (12 May 2026).
- [2] Report dated May 2026; about one in three complex projects fail, nearly twice the 13% rate of failure for projects overall; 97% and 5x — PMI, Pulse of the Profession 2026: Driving Success in Complex Projects (May 2026).
- [3] Oral presentations may substitute for or augment written information; suitable topics; what the solicitation must give offerors and may specify, including time limits; contract terms must be put in writing; version effective 13 March 2026 — Acquisition.gov, FAR 15.102 Oral presentations.
- [4] Proposal presentation of 20 minutes including questions; slides within 15 minutes; required content; examiner assesses answers to questions — Universiti Kebangsaan Malaysia, FTSM, Project Proposal Presentation Guidelines T_4172 (updated July 2023).
- [5] Talk of about 10 to 12 minutes followed by 5 minutes of questions; about half the talk on problem formulation and technical approach — University of Texas at Austin, CS378 Proposal Presentation Guidelines (fall 2016).
Build your project proposal presentation in NOXI, free: attach your written proposal and budget sheet, check the decision slide and the ten titles in Plan mode, and export an editable PowerPoint or a PDF.
